Quick answer: Our free bathroom cost calculator gives Auckland homeowners an indicative renovation estimate in under 60 seconds, based on real 2026 figures, a mid-range bathroom in Auckland runs $25,000–$35,000, and the calculator helps you see where your project sits before you talk to anyone.
Most people start a bathroom renovation with a number in their head. Usually it’s wrong. Either it came from a mate’s job three years ago, or a clickbait headline about a $9,000 bathroom that turned out to be a paint-and-fittings refresh, not a real renovation.
A bathroom cost calculator exists to replace that guess with something closer to reality. Ours was built by the team that quotes and builds these renovations every week across Auckland — not borrowed from a national average that ignores the city’s labour rates. Punch in your details, get an indicative range emailed to you, and start the conversation already knowing roughly what you’re dealing with.
Here’s how to use it properly, what the number means, and the things no calculator can see.
Takes under 60 seconds · results emailed to you · no obligation
What the Bathroom Cost Calculator Actually Does
The tool asks you a handful of questions, bathroom size, the type of work, your finish level, and returns an indicative cost range for your renovation. It takes less than a minute, and the breakdown lands in your inbox.
It’s an estimate, not a quote. That distinction matters. A calculator works off averages and the inputs you give it. A quote comes after a designer has stood in your bathroom, seen the state of the framing, checked where the pipes run, and worked out exactly what your job needs. The calculator gets you in the right ballpark. The consultation gets you the actual number.
Why a Renovation Company’s Calculator Beats a Generic One
Search “bathroom cost calculator” and you’ll find plenty of tools run by sites that don’t actually renovate bathrooms. Some of them point you off to three other calculators. That’s not much use when you’re trying to budget for a real job in Glen Eden or Howick.
Ours is different for one simple reason: the numbers behind it come from jobs we’ve actually delivered. When the calculator says a mid-range bathroom is $25,000–$35,000, that’s not a number we found online. That’s what these renovations cost in Auckland right now, including design, supply, all trades, and project management.
“People treat the estimate like a price tag, and it isn’t one. What it’s really good for is telling you whether your wishlist and your budget are even in the same room. If you’ve got $20,000 in mind and a full wet-room plan, the calculator will show you that gap before you’ve spent a cent on design.” — Cici Zuo, Designer (NZ Dip. Interior Design, Certified Designer), Superior Renovations
💡 Quick tip: Run the calculator twice, once at your dream spec and once at a more modest one. The difference between the two numbers tells you exactly where your money is going, and where you’ve got room to compromise.
How to Read Your Bathroom Renovation Estimate
You’ve got your range. Now what does it actually mean? The calculator sorts most Auckland bathroom renovations into three tiers, and knowing which one you’re aiming for makes the estimate far more useful.
The Three Tiers, in Plain Numbers
Renovation Tier
Auckland Cost (2026)
What You Get
Budget refresh
$9,000–$16,000
New paint, fittings, minor tiling. Fixtures stay where they are. Often a DIY or plumber-only job, not a full renovation-company project.
Mid-range full renovation
$25,000–$35,000
Complete strip-out, new tiling and waterproofing, mid-range fixtures, full project management. Where most Auckland renovations land.
Luxury / custom
$45,000+
Wet-room layouts, premium brands, custom joinery, high-end tapware and stone. Often involves moving plumbing.
These reflect 2026 pricing, which sits roughly 5–8% above 2025 after another round of material and labour inflation. Auckland runs 10–20% above the national average, mostly down to higher labour rates of $90–$120 an hour and city material costs. If a calculator gives you a number well below these and claims to be NZ-specific, it’s likely quoting a national figure or leaving out trades.
What the Estimate Doesn’t Include
This is where most budgets come unstuck. The headline range covers the planned work. It does not automatically cover the surprises, and bathrooms, of all rooms, are where surprises live.
Behind the tiles and under the floor of an older Auckland home, you can find rot, failed waterproofing, or plumbing that should have been replaced a decade ago. Pre-1940s villas and bungalows are the usual suspects: a shower that has been leaking slowly into the floor framing for years looks completely normal until the tiles come off. Nothing on a calculator can see that. The fix runs from a few hundred dollars to several thousand, which is exactly why we tell every client to hold back a contingency of 10–15% on top of their estimate.
Important note: Treat your calculator estimate as the cost of the visible job. Add 10–15% on top for the things that only show up once the demolition starts. On a $30,000 renovation, that’s $3,000–$4,500 set aside — far better than finding it mid-build.
Two bathrooms the same size can come back with wildly different estimates. Here’s what’s pulling the number around — so when you run the tool, you know which lever you’re pulling.
Whether the Plumbing Moves
This is the single biggest swing. Keep the toilet, basin, shower, and bath roughly where they are and you keep costs down. Relocate the shower or move the toilet to the other wall and you’ve added $5,000–$10,000 in plumbing alone, before you’ve touched a tile. Moving services is also one of the main triggers for needing Auckland Council consent.
Tile Choice and Area
Tiles are sneaky. A 6m² bathroom tiled floor-to-ceiling is closer to 30m² of tile once you count the walls. Double the price per square metre, say from a $40/m² ceramic to a $120/m² porcelain, and you’ve added well over a thousand dollars on that line alone. Tile Depot is a good place to compare what your range actually buys you. For bathroom design inspiration, browse our completed projects to see how those tile choices look finished.
An off-the-shelf vanity sits around $800–$2,000. A custom NZ-made one with a stone top is $4,500–$8,000-plus. Tapware does the same thing quietly, the gap between entry-level and premium across your mixer, shower, and basin can swing the total by $2,000–$4,000. Brands like Reece are worth a look to see where your spec lands.
“The calculator can’t tell you which $3,000 is worth spending. That’s the bit we love about the consultation, sometimes the smartest move is a modest vanity and a really good tap, not the other way round. Spend where your hand actually touches the bathroom every day.” — Alison Yu, Designer, Superior Renovations
💡 Quick tip: Before you run the calculator, decide one thing, are you keeping the existing layout? That single answer changes your estimate more than any other input, because moving plumbing is the most expensive thing you can do in a bathroom.
Want to put real numbers against your own bathroom? Have a go with the bathroom renovation cost calculator and the estimate will be in your inbox before the kettle’s boiled. If you’re weighing up the bigger picture first, our full bathroom upgrade page walks through how we run a full project end to end.
Ensuites, Full Renovations and Refreshes: Matching the Estimate to the Job
The calculator returns a range for the job you describe. Describing it accurately is the part people get wrong, and there are three jobs that regularly get typed in as if they were the same thing.
What “Full Bathroom Renovation” Actually Means
A full renovation is a complete strip-out back to the framing. Everything comes out, the substrate is checked and repaired, new waterproofing goes down, the room is re-tiled, and all the fixtures, joinery and tapware are new. Every trade is scheduled and project-managed. That is the $25,000–$35,000 mid-range band, and it is where most Auckland bathroom renovations land.
What it is not is a refresh. A refresh keeps every fixture where it is, updates the surfaces, and sits at $9,000–$16,000. The gap between those two numbers is not finish level, it is scope: waterproofing, tiling and project management across all trades. If you enter “full renovation” but you are picturing a refresh, the estimate will look alarming for no good reason. We’ve set the two side by side in our guide to full versus partial bathroom renovations.
Renovating an Ensuite
An ensuite is usually the smallest wet area in the house, and homeowners reasonably expect it to be the cheapest. It often isn’t, proportionally, and the reason is the same one that makes small kitchens expensive per square metre: the fixed costs do not shrink with the room.
An ensuite still needs a full waterproofing system, a compliant fall to the waste, ventilation, and every trade through the door. Tiling is a smaller area but a fiddlier one, because a compact room is mostly cuts, corners and junctions. Where an ensuite does come in below a main bathroom is fixture count: often a shower, basin and toilet with no bath, and less tiled area overall.
Two things move an ensuite out of that comfortable band:
Adding a brand-new ensuite where none existed. That is not a bathroom renovation, it is a new wet area: new drainage runs, new waste, new ventilation, framing changes, and almost certainly Auckland Council consent. Enter it in the calculator as a full renovation with plumbing relocation, not as a refresh.
Going to a wet-room layout. Popular in ensuites because it makes a small footprint feel bigger, and it puts the waterproofing and floor falls under real scrutiny. We cover that in detail in our guide to wet room bathrooms in NZ.
Whether a new ensuite needs consent in your particular house is a question for Auckland Council or a Licensed Building Practitioner, not for a calculator. For layout ideas before you cost anything, our guide to ensuite bathroom design is a better starting point than a price.
💡 Quick tip: Renovating a main bathroom and an ensuite together almost always beats doing them a year apart. One set of trades, one waterproofing visit, one project management line, one lot of disruption.
How Long the Job Takes, and Why That Affects the Budget
A standard full bathroom renovation takes 3 to 4 weeks from the day demolition starts. Consent, where it is needed, adds 4 to 8 weeks of Auckland Council processing before anything begins. Tiling itself is only a few days of that.
Time matters to the budget in one specific way: if you are living in the house with one bathroom, a three-to-four-week job is a very different proposition to a two-week one, and that is a real cost even though it never appears on a quote. Our guides to how long a bathroom renovation takes and the stages of a bathroom renovation set out the sequence, and if you are at the very start of this, how to renovate a bathroom in NZ covers the decisions that come before any number.
From Estimate to Real Quote: What Happens Next
So you’ve run the numbers and the range feels workable. Where to from here?
The calculator’s job is done — it’s told you whether your project is realistic and roughly what to budget. The only way to get an accurate, fixed price is a free in-home consultation, where one of our designers sees the actual space. That’s when the unknowns become knowns: the state of the substrate, where the pipes really run, whether your plan triggers consent.
Do You Need Consent? The Calculator Can’t Tell You
Most straightforward bathroom renovations, new tiles, vanity, toilet, and shower in the same spots, don’t need Auckland Council consent. You’ll need it if you’re moving plumbing to a new location, removing or adding walls, or making electrical changes beyond like-for-like swaps. Consent isn’t just a cost; it’s time — Auckland Council processing typically adds 4 to 8 weeks before work can start. Worth knowing before you set a move-in-ready deadline. You can check the current rules on the MBIE Building Performance site.
Why Talk to a Renovation Company Rather Than Piece It Together
A full bathroom renovation pulls in 8 to 10 different trades — demolition, plumbing, electrical, waterproofing, tiling, cabinetry, painting. Coordinating that lot yourself is the single biggest source of stress for homeowners who go it alone. Superior Renovations runs all of it as one job: in-house design, fixed-price contract, one project manager, a 147-point quality check, and a 12-month workmanship warranty on top of the trade warranties. It’s the difference between an estimate on a screen and a finished bathroom that doesn’t leak in two years.
Our showroom at 16B Link Drive, Wairau Valley is open if you’d rather see real tiles, vanities, and tapware in person before you commit to a spec.
Get Your Bathroom Cost Estimate Today
A good estimate turns a vague plan into a real decision. Run the calculator, sit with the number, then let’s talk about turning it into a bathroom you actually want to stand in.
Yes. The bathroom cost calculator was built by Superior Renovations and is completely free, with no obligation. It takes under 60 seconds and the indicative cost breakdown is emailed straight to you. We then follow up to answer any questions and, if you're keen, arrange a free in-home consultation for an accurate fixed-price quote. There's no charge for the tool or the follow-up.
How much does a bathroom renovation cost in Auckland?
In Auckland in 2026, a mid-range full bathroom renovation costs $25,000–$35,000, covering design, supply, all trades, and project management. A budget refresh, new paint, fittings, minor tiling, starts from $9,000–$16,000. A luxury or custom bathroom with a wet room and premium fixtures starts from $45,000 and up. Auckland runs 10–20% above the national average due to higher labour rates of $90–$120 an hour.
How accurate is a bathroom cost calculator?
A calculator gives you a realistic indicative range, not a fixed price. It works off averages and the inputs you provide, bathroom size, type of work, finish level. It can't see the state of your framing, where your plumbing runs, or whether you'll uncover water damage during demolition. Treat the estimate as the cost of the visible job, then add a 10–15% contingency. An accurate price only comes after an in-home consultation.
What does a bathroom cost calculator estimate include?
Our calculator estimates the full renovation scope: demolition, supply of products and fixtures, installation, waterproofing, tiling, plumbing, electrical, painting, and project management. It does not include hidden repairs like rotten framing or failed waterproofing, which only show up once work begins. That's why we recommend holding back 10–15% of your budget as a contingency on top of the calculator figure.
Do I need building consent for a bathroom renovation?
Most standard bathroom renovations, replacing tiles, vanity, toilet, and shower in the same positions, do not require Auckland Council consent. Consent is required if you're moving plumbing to a new location, removing or adding walls, or making electrical changes beyond standard replacements. Consent also adds 4 to 8 weeks of council processing time before work can start. Superior Renovations assesses this during your consultation and manages the application for you.
Why is the calculator estimate higher than I expected?
Usually because the number reflects a full renovation by a company that manages every trade, not a DIY fixture swap. A budget refresh of $9,000–$16,000 is a different job to a $25,000–$35,000 mid-range renovation with new waterproofing, tiling, and project management. The other common reason is Auckland pricing, which sits 10–20% above the national average. Running the calculator at two different spec levels shows you exactly where the cost sits.
How long does a bathroom renovation take in Auckland?
A standard full bathroom renovation takes 3 to 4 weeks from the day demolition begins, assuming the design is finalised and all materials are on site before work starts. If your project needs consent, for moving plumbing or structural changes, add 4 to 8 weeks for Auckland Council processing before the build can begin. Your project manager gives you a clear timeline at the start and keeps you updated throughout.
Can I get a fixed price from the calculator?
No, the calculator gives an indicative range only. A fixed price requires a free in-home consultation, where a designer assesses your actual bathroom, checks the substrate and plumbing, and works out exactly what your job needs. The calculator gets you in the right ballpark so the consultation is a productive conversation rather than a blank page. Both the calculator and the consultation are free.
What's the difference between a budget refresh and a full renovation?
A budget refresh ($9,000–$16,000) keeps every fixture where it is and updates the surface: new paint, new fittings, maybe minor tiling. A full mid-range renovation ($25,000–$35,000) is a complete strip-out, new waterproofing, full tiling, new fixtures, and project management across all trades. The calculator lets you estimate both so you can see whether a refresh gets you what you want, or whether you need the full job.
Should I use a contingency on top of my estimate?
Yes — always. We recommend 10–15% of your renovation budget held back as a contingency. Bathrooms in older Auckland homes commonly hide water damage, rot, or failed waterproofing behind the tiles and under the floor, none of which a calculator can predict. On a $30,000 renovation that's $3,000–$4,500 set aside. If you don't need it, you've saved it. If you do, you're not scrambling mid-build.
How much does an ensuite renovation cost in Auckland?
An ensuite is priced off the same Auckland bands as any other bathroom: a refresh from $9,000-$16,000, a full mid-range renovation $25,000-$35,000, and luxury or custom from $45,000. It is smaller, but not proportionally cheaper, because the fixed costs do not shrink with the room. You still need a full waterproofing system, a compliant fall to the waste, ventilation and every trade through the door, and a compact room is mostly tile cuts and junctions. Adding a brand-new ensuite where none existed is a different job again, with new drainage and almost certainly Auckland Council consent.
What is included in a full bathroom renovation?
A full bathroom renovation is a complete strip-out back to the framing: demolition, substrate repair, a new waterproofing system, full re-tiling, new fixtures, tapware and joinery, plumbing and electrical, painting, and project management across every trade. That is the $25,000-$35,000 mid-range band in Auckland. A budget refresh at $9,000-$16,000 is a different job entirely - fixtures stay where they are and only the surfaces change. The difference between the two is scope, not finish level.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
A wet room in Auckland usually sits in the mid-range bathroom band, about $20,000–$35,000, and up from there. It rarely comes in at the budget end, because the whole room gets tanked and tiled, not just the shower. Converting an existing bathroom to a doorless wet-area layout can be less. What you’re really paying for is waterproofing done right.
A wet room is the most misunderstood bathroom in New Zealand. Done well, it’s the most usable room in the house. Done badly, it’s a leak waiting to happen. Here’s what one actually costs, what the Building Code requires, and how we build them so they last.
No step, no shower tray, no lip to catch a toe on — just a fully waterproofed floor doing all the work
What is a wet room, exactly?
A wet room is a fully waterproofed bathroom where the shower area is open to the rest of the room, with no step and often no screen or just a single pane of glass. The whole floor is tanked and tiled, laid to a gentle fall so water runs to a drain. There’s no shower tray and no lip to step over.
That’s the difference from a standard bathroom, where waterproofing is concentrated in a contained shower. In a wet room the water can go anywhere, so the whole room has to be built to handle it. It’s also why a wet room feels bigger and cleaner-lined than a normal bathroom of the same size, and why it suits small bathrooms and accessible layouts so well. If step-free access is the priority, our accessible bathroom renovation guide goes deeper on that side of it.
The tiled floor runs without a break from the shower zone into the rest of the room — the defining feature of a properly built wet room.
What does a wet room cost in Auckland?
We price wet rooms the way we price any bathroom, but the scope pushes them up the range. Here’s where they land against our 2026 Auckland bathroom bands:
Scope
Indicative cost
Doorless wet-area layout within an existing bathroom
Wet rooms sit mid-range and up because the whole room is tanked and tiled, not just the shower zone. The bigger cost drivers: full-room waterproofing, floor-to-ceiling tiling (stone runs $100–$150/m2 against ceramic at $30–$50/m2), the drainage falls, and custom glass. Labour is 40–50% of any bathroom budget, and a wet room is labour-heavy because every surface is a wet surface. These are indicative figures to plan around, not a fixed quote. Plug your own scope into the bathroom renovation cost guide and calculator for a closer read.
Waterproofing is the whole game
This is where a wet room is made or ruined. Because water isn’t contained to a tray, the entire floor and the lower walls have to be tanked and waterproofed to AS/NZS 3740 before a single tile goes down. Get the membrane, the falls to the drain, and the junctions right and it lasts decades. Get them wrong and you’re chasing a leak through the ceiling below.
Three things we don’t cut corners on:
The fall to the drain. The floor has to be set to a consistent gradient so water always runs to the outlet, never pools. This is set in the substrate, before tiling.
Membrane continuity. The waterproof membrane has to be unbroken across the floor, up the walls, and around every penetration – the drain, the mixer, the niche.
The right substrate. In an older Auckland home with a timber floor, the substrate often needs work before it’s fit to tank. We check this before quoting, not after demo.
Bathroom waterproofing and drainage is restricted building work, and reconfiguring a wet room can trigger a building consent (Auckland Council consent fees run about $500–$2,000). Confirm your own consent pathway with Auckland Council or a Licensed Building Practitioner. The waterproofing standard itself sits under the Building Code’s internal-moisture clause (E3) via Building Performance (MBIE).
The standard behind all of this is the Building Code’s internal-moisture clause, E3, and its Acceptable Solution E3/AS1. According to BRANZ, the waterproof membrane has to run at least 25mm beyond the wet zone, shower walls are tanked to at least 1800mm above the floor, and any adjacent walls to at least 150mm. The membrane system itself must be BRANZ-appraised or CodeMark-certified and installed by a trained applicator, not improvised on site. That is the line between a wet room that lasts decades and one that fails in a few winters.
Does a wet room need building consent?
Often, but not always. A straight like-for-like bathroom refit usually does not need building consent. Turning a standard bathroom into a wet room frequently does, because you are almost always altering drainage and sometimes moving walls, and both sanitary plumbing and waterproofing are Restricted Building Work that has to be done or supervised by a licensed tradesperson.
The waterproofing has to meet Building Code clause E3 either way. Where consent does apply, Auckland Council fees on a typical bathroom job run about $500 to $2,000, and the finished work is inspected and signed off before you get a Code Compliance Certificate. We work out the consent pathway for your specific job at quote stage, and where it needs design or consent input we bring in the team at Sonder Architecture. For the rules first-hand, Auckland Council covers consents and BRANZ’s Level guide sets out the statutory wet-area requirements.
Wet room design that works in an NZ home
A wet room can look like a hotel or feel like a wet, cold cave. The difference is in a few decisions:
Keep the rest dry. A single pane of glass or a smart layout keeps spray off the vanity and toilet while still feeling open. Fully doorless works best in larger rooms.
Heat it. Underfloor heating and a heated towel rail dry the room out fast, which matters in Auckland’s damp winters and keeps mould at bay.
Ventilate it. A wet room holds moisture, so a good extractor is non-negotiable.
Small rooms love it. Losing the shower tray and screen makes a small bathroom feel noticeably bigger, which is why wet rooms suit compact Auckland ensuites and villas.
Wet rooms earn their keep in two situations especially. The first is small bathrooms and ensuites, where losing the tray and screen buys back real floor space and makes a tight villa bathroom feel open. The second is accessibility. A step-free, doorless wet area is the most future-proof bathroom you can build, which matters if you are renovating a forever home or planning to age in place. Designing step-free access in now is far cheaper than retrofitting it later.
Two honest caveats before you commit. A fully open wet room in a large family bathroom can leave the whole floor wet after every shower, so unless the room is genuinely big, a single pane of glass to keep the vanity and toilet dry is usually the smarter call. And an older Auckland home with a sprung timber floor needs its substrate checked before anything is tanked. We flag both at the quote, not halfway through the build. There is more on step-free layouts in our accessible bathroom guide.
How we build a wet room, step by step
Every wet room we build runs through the same sequence, and the order is what keeps water where it belongs.
Strip-out and substrate check. The old bathroom comes out and we assess the floor. In an older home the substrate often needs firming up or re-sheeting before it is fit to tank.
Plumbing and drainage set to the fall. The waste and the floor gradient go in first, so water always runs to the drain rather than pooling in a low spot.

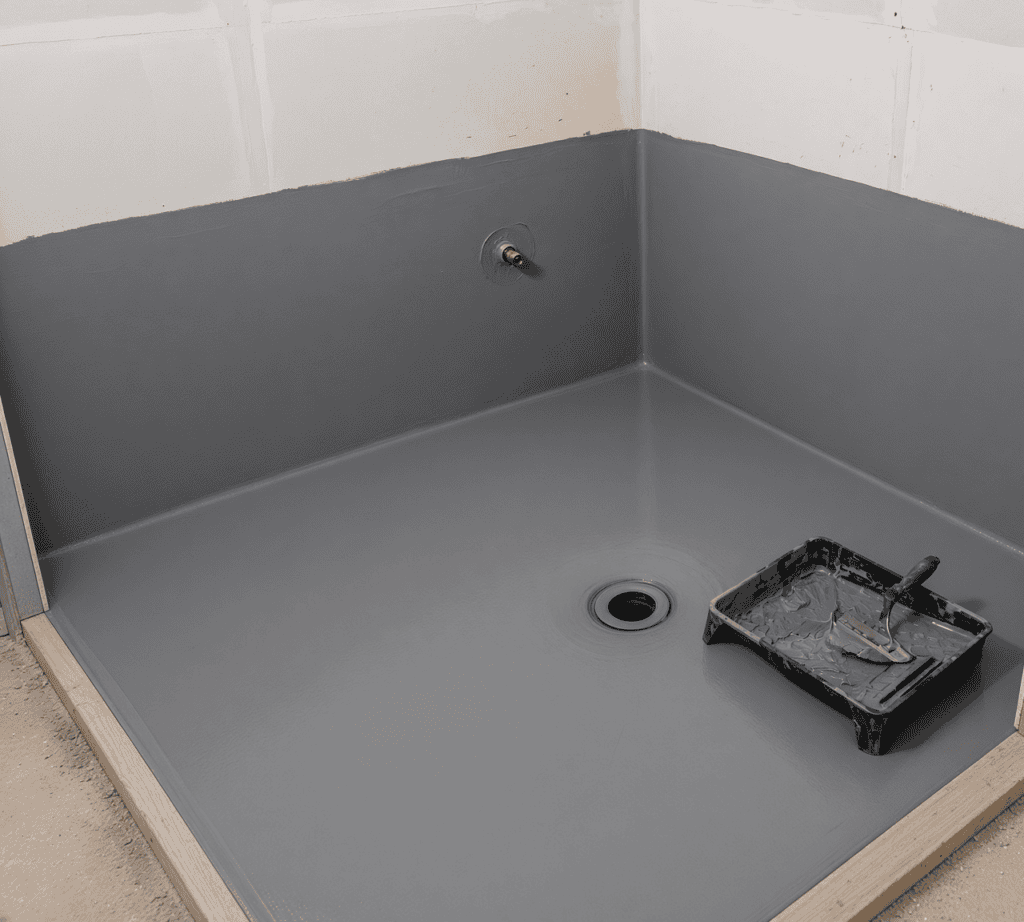

Tanking. A continuous waterproof membrane goes over the floor and up the walls, sealed around the drain, the mixer and any niche, then left to cure. Nothing later in the build can make up for a rushed membrane.
Step 2 — tanking. The membrane goes over the floor and up the walls, sealed around every penetration, and left to cure before a single tile is laid.

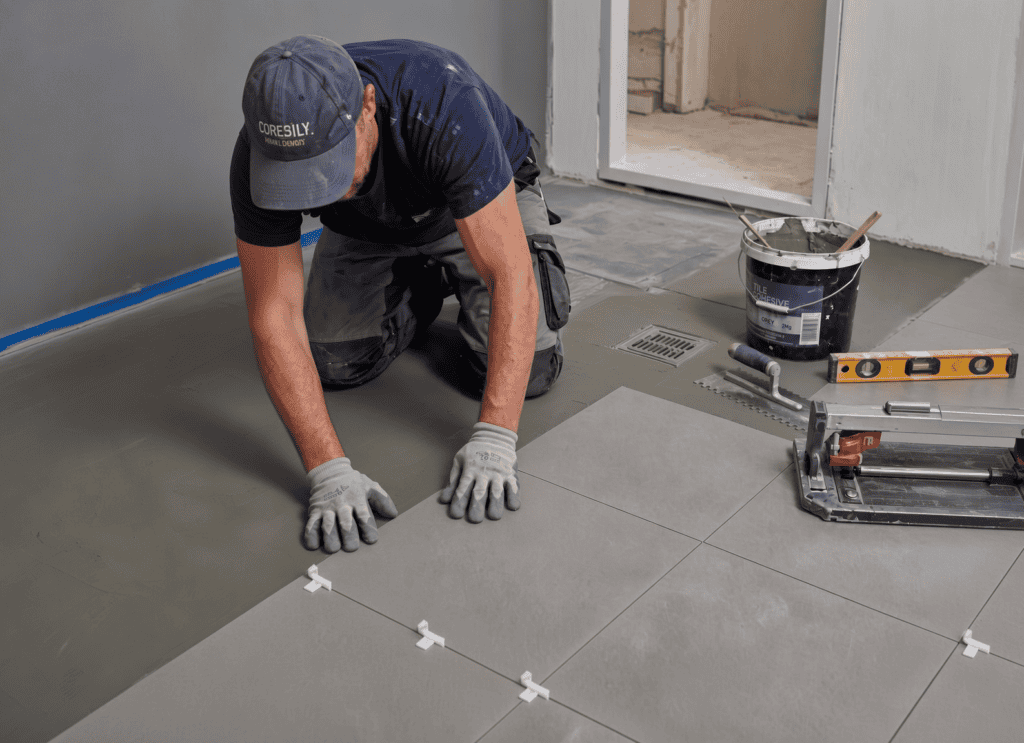

Tiling. Floor and walls are tiled onto the cured membrane, keeping the falls true so the finished floor drains cleanly and never ponds.
Step 3 — tiling. Floor and walls go onto the cured membrane, keeping the fall true so the finished floor drains cleanly and never ponds.
Fit-off and heat. Tapware, glass, heated towel rail and underfloor heating go in, the extractor is commissioned, and the room is checked over.
Sign-off. Where the job was consented it is inspected for its Code Compliance Certificate, and either way it goes through our quality-assurance check before handover.
Keeping a wet room warm and dry
A wet room holds more moisture than a standard bathroom because more of the room gets wet, so managing that moisture is part of the design, not an afterthought. Clause E3 of the Building Code is specifically about protecting the home from internal moisture, and in practice that means three things working together: a properly sized extract fan vented outside, underfloor heating and a heated towel rail to dry the room quickly, and tiling and joinery that shrug off damp. Get those right and an Auckland wet room stays warm and mould-free through winter. Skimp on ventilation and even a perfectly waterproofed room will feel clammy and grow mould in the grout.
One more point that is easy to overlook: because the whole floor gets wet, we specify slip-resistant floor tiles with a higher slip rating than you would use in a dry bathroom. It keeps a wet floor safe underfoot for young kids and older users, and it is a small choice that matters most in exactly the step-free, doorless layout a wet room is built around.
Wet rooms we’ve built in Auckland
We build wet-area bathrooms across Auckland, so this isn’t theory.
In Westmere, we stripped out a character-home bathroom and rebuilt it around a generous wet area – moss-green feature tiling, floor-to-ceiling dark tile, a doorless custom-cut glass divider, matte gold tapware, and the whole room fully waterproofed to standard before tiling. The brief was “warm, not clinical,” and the wet-area layout is what made a modest room feel like somewhere to wind down. You can see it in our rustic wet-room project.
In Torbay, a two-ensuite renovation used an open wet area with a bathtub and a doorless glass shower to give a sense of space, with underfloor heating and demister mirrors. It’s written up in our designer bathroom project on the North Shore.
Thinking about a wet room?
A wet room is one of the smartest ways to modernise a bathroom or squeeze more out of a small one – as long as the waterproofing is done properly. That starts with a realistic figure and a proper look at your space.
In Auckland, a full wet room typically costs $20,000-$35,000 at a mid-range finish, rising to $35,000-$65,000+ for premium tiles, heating and custom glass. A doorless wet-area layout within an existing bathroom can come in around $15,000-$25,000. Wet rooms sit higher than a standard bathroom because the whole room is tanked and tiled, not just the shower.
What is the difference between a wet room and a normal bathroom?
In a wet room the shower is open to the rest of the room with no tray and no step, and the entire floor is waterproofed and laid to a fall so water runs to a drain. A standard bathroom contains the water in a shower tray or enclosure. The wet room approach feels more open and suits small or accessible bathrooms.
Are wet rooms a good idea in New Zealand?
Yes, when they're built properly. They make small bathrooms feel bigger, suit step-free and accessible layouts, and are easy to clean. The catch is waterproofing - because water isn't contained, the whole room must be tanked to AS/NZS 3740. A wet room built by someone who cuts that corner is a leak risk, so the build quality matters more than in a standard bathroom.
Do wet rooms leak?
A properly built wet room does not leak. The whole floor and lower walls are tanked with a continuous waterproof membrane, laid to a fall to the drain, with every penetration sealed. Leaks come from poor waterproofing, a bad fall, or a broken membrane junction - all avoidable with the right build. That is why waterproofing is the part not to save money on.
Do I need building consent for a wet room?
Reconfiguring a bathroom into a wet room can trigger an Auckland Council building consent, especially if you move plumbing or walls. Bathroom waterproofing and sanitary plumbing is also restricted building work. A like-for-like refit may not need consent. Always confirm your situation with Auckland Council or a Licensed Building Practitioner before starting.
Can you put a wet room in a small bathroom?
Wet rooms are ideal for small bathrooms. Removing the shower tray and screen opens the space up and makes a compact room feel noticeably larger, which is why they suit small Auckland ensuites and villa bathrooms. A single glass pane can still keep the vanity and toilet dry.
Do wet rooms need underfloor heating?
It is not compulsory, but it is strongly recommended. Underfloor heating and a heated towel rail dry the room quickly, which matters in Auckland's damp winters and helps keep mould away. Paired with good ventilation, heating keeps a wet room warm and dry rather than cold and clammy.
How long does it take to build a wet room?
A wet room takes a little longer than a standard bathroom because of the full-room waterproofing and the time the membrane needs to cure before tiling. Most run a few weeks on site. Your project manager gives you a full timeline before work starts.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
Quick answer: A mid-range bathroom renovation in Auckland costs $25,000–$35,000 in 2026, with budget refreshes starting from $9,000 and full luxury builds reaching $65,000+. Auckland sits 20–30% above the national average due to higher labour rates and material costs.
A bathroom renovation is the most trade-intensive job you can do in a house. Plumber, electrician, tiler, waterproofer, painter, plasterer, all working in sequence in a space the size of a small car. Get the coordination wrong and the budget blows out. Get it right and a $30,000 bathroom adds genuine value to your home and your daily life.
We’ve renovated hundreds of Auckland bathrooms since 2017, from quick rental refreshes in Papatoetoe to $55,000 luxury ensuites in Parnell. This guide breaks down what each type of renovation actually costs, where the money goes, and where you can make smart trade-offs without cutting corners that matter.
The cost figures in this guide reflect 2026 Auckland pricing. Residential construction prices rose 1.9% in the 12 months to March 2025 (Stats NZ), and material inflation has continued to push bathroom renovation costs up 5–8% year-on-year. We update this guide annually with data from our own completed projects, Auckland Council fee schedules, and national construction cost indices from MBIE.
If you want a ballpark figure specific to your bathroom before you read any further — try our bathroom renovation cost calculator. It takes two minutes and gives you a realistic starting range.
The trades involved in a bathroom renovation include a designer, demolisher, plumber, electrician, tiler, waterproofer, installer, painter, grouter, and plasterer. Managing them yourself carries real risk, blown budgets, extended timelines (see our guide on how long bathroom renovations take in NZ), and the stress of coordinating multiple companies. A project manager keeps the sequence tight and the budget visible.
Before you renovate, get clear on why you’re doing it. The reason shapes the brief, the brief shapes the design, and the design determines the cost.
How Much Does a Bathroom Renovation Cost in Auckland in 2026?
The answer depends entirely on scope. A fresh coat of paint and new taps is a different job from ripping everything back to the framing and starting again. Here’s where the three main tiers land in Auckland right now.
Renovation Type
Auckland Cost (2026)
What’s Included
Budget refresh
$8,000–$15,000
Like-for-like fixture swaps, new taps, paint, minor tiling. Existing plumbing and GIB stays. Suits rentals and quick updates.
Mid-range full renovation
$20,000–$35,000
Full strip-out including GIB. New plumbing, electrical, tiling, waterproofing, mid-range fixtures. The standard for Auckland family homes.
Those figures sit 20–30% above the national average. Outside Auckland, a comparable mid-range job in Christchurch or Hamilton comes in at $18,000–$26,000. The gap is driven by Auckland’s higher labour rates ($90–$120/hour versus $70–$100 nationally), urban material costs, and stronger demand for skilled trades.
“People ask me why Auckland bathrooms cost more. It’s simple, when your plumber charges $110 an hour and a bathroom needs 40–60 hours of trade labour, the numbers add up fast. That’s before you touch a tile.” — Dorothy Li, Design Manager, Superior Renovations
Auckland vs the Rest of New Zealand
Tier
Auckland
NZ Average
Auckland Premium
Budget
$8,000–$15,000
$6,000–$12,000
~25%
Mid-range
$20,000–$35,000
$18,000–$26,000
~20–30%
Luxury
$35,000–$65,000+
$30,000–$50,000
~20–30%
💡 Quick tip: Use our bathroom renovation cost calculator to get a personalised estimate based on your bathroom size, finish level, and scope. It’s free and takes two minutes.
See Mid-Range Bathroom Projects at These Price Points
Contemporary bathroom renovation in Henderson Valley, matte black tiles, wall bathtub, custom vanity, top-mounted sink, tiled shower, and brushed brass fittings.
Where Your Money Goes: Bathroom Renovation Cost Breakdown
Labour is the single biggest line item in any Auckland bathroom renovation. Not materials. Not tiles. Not the vanity you spent three weekends choosing. Labour accounts for 40–50% of your total, $10,000–$25,000 on a mid-range project. That’s before a single tile is purchased.
Here’s how the full budget typically breaks down across the three tiers.
Component
Budget ($)
Mid-Range ($)
Luxury ($)
% of Total
Labour (all trades)
3,000–5,000
8,000–12,000
15,000–25,000
40–50%
Materials (tiles, GIB, adhesive)
1,500–3,000
4,000–8,000
8,000–15,000
20–25%
Fixtures (shower, toilet, vanity)
1,000–2,500
3,000–6,000
6,000–12,000
15–20%
Plumbing
1,000–1,500
2,000–3,000
3,000–6,000
8–12%
Electrical
500–1,000
1,000–2,000
2,000–4,000
5–8%
Waterproofing
300–500
500–1,000
1,000–2,000
3–5%
Painting and plastering
500–1,000
1,500–2,500
2,500–4,000
5–10%
Structural changes
0
0–1,000
2,000–5,000+
0–10%
Total
$8,000–$15,500
$20,000–$35,500
$35,000–$65,000+
—
A few things worth unpacking in that table. Budget renovations keep costs down by minimising trade time, you’re swapping a toilet ($600), installing basic ceramic tiles ($30–$50/m²), and staying on the existing plumbing. The moment you strip the GIB off the walls, you’ve committed to waterproofing, replastering, and a full electrical inspection. That’s the jump from $15,000 to $20,000+.
The luxury tier costs what it does because of material choices and structural complexity. Stone tiles at $100–$150/m² versus ceramic at $30–$50. A $3,000 custom vanity versus an $800 off-the-shelf unit from Mitre 10. And if you’re building a wet room or moving walls, you’re adding consents ($500–$2,000 from Auckland Council), an engineer, and an extra 1–3 weeks to the timeline.
Separate Toilet Renovation — Do It at the Same Time
Separate toilets are common in Auckland homes and usually get renovated alongside the main bathroom. Smart move. A standalone toilet renovation in Auckland runs $6,500–$9,000, but bundling it with a bathroom reno saves 10–15% through shared trade callouts ($200–$400 per visit).
Toilet Component
Cost Range
Wall tiles (to ceiling)
$2,200–$3,500
Floor tiles
$900–$1,200
Toilet bowl and bidet spray
$600–$1,000
Wash basin and tap
$300–$500
Piping upgrades
$500–$900
Haulage and disposal
$400–$700
Total
$6,500–$9,000
Turnaround: 5–10 working days standalone, faster when bundled. Older North Shore and inner-city homes often have toilets that are well overdue, getting it done alongside the bathroom makes sense financially and practically.
💡 Quick tip: Auckland Council consent may be required if you relocate a toilet or basin ($500–$2,000 in fees). Replacing like-for-like in the same position? Usually exempt under Schedule 1 of the Building Act 2004.
What Pushes the Number Up — Quick Reference
In small 5–7m² bathrooms, complexity matters more than floor area. Fixed trade costs mean a compact Ponsonby powder room can cost nearly as much as a full ensuite in Epsom. Premium porcelain or stone tiles ($50–$150/m²) versus basic ceramic ($30–$50/m²) can shift the total by $2,000–$4,000. Relocating plumbing adds $1,000–$5,000. And coastal areas like St Heliers need proper waterproofing ($300–$2,000) and good ventilation, skip these and you’re dealing with mould remediation later.
Why Auckland Homeowners Renovate, and What Each Scenario Costs
Different households renovate for different reasons. The reason you’re doing it should shape the brief you give your renovation company, and the brief determines the cost. Here are four common scenarios we see across Auckland, with real project examples and photos.
1. Young Families — Safety and Practicality ($25,000–$35,000)
New parents and families with young kids need a bathroom that works hard. A bathtub is usually the first addition. Non-slip tiles are non-negotiable. Storage keeps the space safe and tidy when small humans are around.
Key costs for young families: A mid-range freestanding tub runs $1,500–$3,000 in Auckland. Textured anti-slip tiles cost $50–$100/m². Built-in shelves or cabinets add $500–$1,500. Soft-close toilet seats ($100–$200) and handheld showers ($150–$300) are small additions that make a genuine difference.
Auckland example — Westmere: Rustic design with a large wet area for bathing kids, matte anti-slip tiles, and a double-sink vanity. Artisan Moss Green tiles from Tile Depot (6.5x20cm, $80/m²) and custom MDF cabinetry. Total: $30,000–$35,000. The small tile format is labour-intensive, at Auckland rates, that’s reflected in the bill.
This Westmere bathroom is designed for a family with young children. The wet area is large enough for an adult to bathe a toddler comfortably.
West Harbour bathroom ($35,000–$38,000): Full wall and floor tiling, freestanding bathtub, vanity, toilet, and custom tiled shower. The freestanding format makes cleaning around the tub easier, practical for a heavily used family bathroom. Full project details and before-and-after photos.
Freestanding bathtub in a West Harbour family bathroom renovation.
2. Growing Families — More Space, More Function ($28,000–$50,000)
Teenagers. Extended family. Multi-generational households. When the family expands, the bathroom needs to keep up. In Auckland, where older homes often house multiple generations, this can mean adding a separate toilet, splitting an ensuite, or converting a bedroom into a new bathroom entirely.
Auckland example — Albany ($28,000–$32,000): Shower and bathtub combined, oversized dark tiles ($60/m²), timber floating vanity. Designed for a busy household of different ages.
Avondale ($40,000–$50,000): A bedroom converted into two bathrooms for a three-generational family, including plumbing and Auckland permit fees ($1,000–$2,000). See project details.
Modern bathroom in Albany, oversized dark floor tiles against neutral walls, timber floating vanity. Designed for a household of different ages.
3. Adding Value for Resale or Rental ($20,000–$28,000)
Renovating to sell or rent? Focus on cost-effective updates that read well, not luxury finishes that won’t return their cost. Bathroom renovations in Auckland typically return around $1.50 per $1 spent, which is higher than most other renovation types.
Smart choices: a $500 vanity delivers better ROI than a $3,000 designer sink. Half-height tiles ($30–$50/m²) with a clean layout have broad appeal. Fix leaks and mould ($1,000–$3,000) before touching cosmetics.
St Heliers ($20,000–$25,000): Narrow bathtub, wall-hung vanity, dark tiles tiled halfway up the walls. Budget-conscious and contemporary, strong for resale without overcapitalising. See project details.
St Heliers bathroom, narrow bathtub, wall-hung vanity, dark tiles to mid-wall. Tiling only halfway to the ceiling kept costs down while maintaining a clean, contemporary look.
4. Personal Comfort, a Luxury Bathroom ($35,000–$60,000+)
Renovating purely for yourself? This is where the fun is. Luxury upgrades, popular in Parnell, Titirangi, and Remuera, are about quality of life, not ROI.
Wet rooms suit smaller spaces and run $10,000–$15,000 with tiling that runs unbroken from wall to floor. Premium Methven matte black tapware ($300–$600) lifts the whole space. Art deco tiles at $100–$150/m² or sliding shower doors ($1,500–$2,500) add design precision that holds its value.
“Matte black fixtures are still the top choice in premium suburbs like Parnell and Remuera in 2026. If you’re in a coastal area like St Heliers, pair them with anti-corrosion coatings, salt air can be hard on hardware.” — Cici Zuo, Designer (NZ Dip. Interior Design), Superior Renovations
Titirangi ($35,000–$40,000): Art deco floor tiles (labour-intensive at $120/m²) and premium St Michel fixtures. The tiling looks simple, but each tile had to align perfectly with the pattern across the entire floor. That level of precision takes time. Full project details.
Parnell ($45,000–$55,000): Dark, high-finish interior with premium brands throughout. Full project details.
Mellons Bay ($40,000–$45,000): Large-format matte tiles with minimal grout lines, custom MDF vanity panels, sliding shower door. The round black top-mounted basin and wooden-look vanity panels add warmth to an otherwise dark palette.
💡 Quick tip: Matte black tapware looks striking, but it shows water marks more than brushed nickel or chrome. For busy family bathrooms, consider brushed brass or gunmetal, they hide fingerprints better and still look premium.
Small Bathroom, Budget, and Rental Renovation Costs in Auckland
Two things most people get wrong about small bathrooms: they assume a smaller room is automatically cheaper to renovate, and they assume rental bathrooms can’t look good on a tight budget. Both wrong.
Why a Small Bathroom Doesn’t Cost Much Less
A small bathroom (5–7m²) full renovation costs $20,000–$30,000 in Auckland, surprisingly close to a mid-size bathroom. The reason is straightforward: trades and complexity drive cost, not square footage. A compact Ponsonby powder room needs the same plumber, electrician, tiler, and waterproofer as a full ensuite in Parnell. The floor area is different. The process isn’t.
Fixed trade costs in Auckland, plumbers, electricians, tilers at $90–$120/hour, account for $10,000–$15,000 regardless of bathroom size. What does scale with size is tiles and waterproofing membrane. On a 5m² bathroom versus a 10m² bathroom, that’s perhaps a $1,000–$2,000 difference. Not the $10,000 people expect.
Small Bathroom Scope
Auckland Cost
NZ Average
Minor upgrade (fixture swaps, paint)
$5,000–$10,000
$4,000–$8,000
Full renovation (demo, trades, retiling)
$20,000–$30,000
$15,000–$25,000
Custom renovation (layout changes, premium)
$30,000–$45,000
$25,000–$35,000
Auckland example — Henderson Valley: A 5m² bathroom with matte black tiles ($80/m²), custom vanity, and tiled shower, $28,000 with Superior Renovations. The confined space meant precise tiling and careful plumbing coordination. Size didn’t reduce complexity. It didn’t reduce cost much either.
Space-saving fixtures can help the budget: wall-hung vanities ($500–$1,500) versus freestanding ($1,500–$3,000), and corner showers ($1,000–$2,500) versus walk-in configurations ($4,000–$7,000). A large mirror ($200–$600) opens up a small space without touching a wall.
What a Bathroom Renovation Costs Per Square Metre
People ask for a per-square-metre rate because it works for extensions and recladding. It works badly for bathrooms, and it is worth understanding why before you use one to budget.
A typical Auckland bathroom is 4 to 6m². Dividing the price bands above by that floor area gives the following, which is arithmetic off our own published figures rather than a rate we quote from:
Scope
Total (Auckland 2026)
Implied rate on a 4–6m² bathroom
Budget refresh
$9,000–$16,000
roughly $1,500–$4,000 per m²
Mid-range full renovation
$25,000–$35,000
roughly $4,200–$8,750 per m²
Luxury or fully custom
$45,000+
$7,500 per m² and up
Those numbers are three to four times the per-square-metre rate of a house extension, and that is not an error. A bathroom packs the two most expensive trades in residential building, plumbing and waterproofing, plus tiling, electrical and joinery, into the smallest room in the house. The rate per square metre is high precisely because the room is small: the plumber charges for the same connections whether the floor is 4m² or 7m².
Use the total, not the rate. The only situation where a per-square-metre figure is genuinely useful for a bathroom is comparing your own bathroom against a larger one in the same scope band, and even then the fixture count matters more than the floor area.
Bath Resurfacing vs Replacing: When the Cheap Option Is the Right One
Resurfacing, sometimes called reglazing or bath restoration, means an applied coating over the existing bath rather than removing it. It is a specialist trade rather than something a renovation crew does in passing, and on the right bath it costs a fraction of a replacement.
It is the right call when the bath is structurally sound and everything around it is staying. An enamelled steel or cast-iron bath with surface staining, dulling or a chip, sitting in a tiled surround you are keeping, is the classic candidate. You avoid demolition, avoid disturbing the waterproofing, and avoid re-tiling the surround, which is usually the expensive part of removing a bath rather than the bath itself.
It is the wrong call when anything behind it is changing. If the tiles are coming off, if the layout is moving, if there is any sign of moisture in the wall behind the bath, or if you are going to a freestanding bath, resurfacing just adds a cost to a wall you are about to demolish. The same applies to an acrylic bath that has flexed or cracked, because the coating cannot fix a substrate that moves.
The honest caveat: a resurfaced bath is a refreshed surface, not a new one, and it has a finite life measured in years rather than decades. We do not publish a price for it because it depends entirely on the bath’s condition and the size of the repair, and a resurfacing specialist should quote it after seeing the bath. If you are deciding between a bath you keep and a bath you replace, our comparison of freestanding versus built-in baths covers what a replacement actually involves.
Budget Bathroom Renovations — What $5,000–$10,000 Gets You
A budget bathroom renovation in Auckland means keeping the existing layout, reusing serviceable plumbing, and spending smart on finishes. Move one pipe and you’ve added $1,000–$2,500 plus potential consent fees. Keep everything where it is and the savings are immediate.
Five strategies that work:
1. Refresh rather than replace. Repaint cabinets ($50–$100 in supplies) or resurface a bathtub ($300–$600) instead of buying new ($1,500–$3,000). If the unit is structurally sound, fresh paint and new handles ($20–$100) make it look new.
2. Swap fittings, not whole fixtures. New Methven taps from Mitre 10 ($150–$500) and new cabinet handles ($20–$100) update the look at a fraction of a full fixture replacement ($3,000–$10,000).
3. Re-grout rather than retile. Re-grouting ($100–$200 in materials) and sealing ($50–$100) can transform tired-looking tiles without the $600–$1,500 cost of new tiling in Auckland.
4. Paint with moisture-resistant products. Resene’s bathroom range ($50–$100) transforms walls effectively. DIY for $100–$200 versus $500–$1,000 for a professional at Auckland rates.
5. Source secondhand. Trade Me and Facebook Marketplace have surplus vanities ($100–$300), toilets ($50–$150), and tiles ($20–$40/m²) at half the price of new.
Rental Bathrooms — Practical, Not Luxury
Tenants need a bathroom that’s clean and functional. They don’t need stone tiles or sliding shower doors. A solid rental refresh in Auckland is achievable for $1,500–$6,000 if you keep the brief tight.
Auckland rental example — Papatoetoe: 6m² bathroom, existing plumbing kept, shower retiled, fixtures updated. Second-hand vanity from Trade Me ($200), 30x30cm tiles from a Mitre 10 sale ($30/m², $180 for 6m²), new taps ($100), Resene moisture-resistant paint ($80), re-grout ($150), tiler via Builderscrack ($600). Total: under $1,500, tenant-ready and Healthy Homes compliant.
Important note: Ensure ventilation (extractor fan, $200) and waterproofing ($400–$600) meet Healthy Homes requirements before cosmetic upgrades. Compliance first, aesthetics second.
“For investment properties, I always tell clients to spend the money on waterproofing and ventilation first. A good extractor fan costs $200 and prevents $3,000 worth of mould damage. That’s the best return on investment in any rental bathroom.” — Alison Yu, Designer, Superior Renovations
Shower Renovation and Tiling Costs in Auckland
Showers and tiles account for a big chunk of any bathroom renovation budget, and they’re the two areas where costs can swing the most depending on your choices. Here’s what to expect in Auckland in 2026.
Tiled Shower Installation, $2,000–$9,500
A new tiled shower in Auckland costs $2,000–$9,500, above the national range of $1,550–$8,250. The gap comes from Auckland’s higher labour rates and the cost of quality waterproofing membrane products. Retiling an existing shower (keeping the plumbing where it is) runs $1,800–$4,000, excluding waterproofing.
Shower Component
Auckland Cost
Remove old unit
$150–$250
Haul away debris
$250–$500
Prepare surface (levelling + waterproofing)
$500–$1,200
New tiled shower (varies by tile type)
$1,000–$7,500
Total
$2,000–$9,500
Acrylic shower units are the budget alternative: $900–$2,000 installed, quick to fit, easy to clean, and well suited to rental properties. But in suburbs like Remuera and Titirangi, a well-done tiled shower adds to property value in a way acrylic simply doesn’t.
Shower Options Compared
Option
Cost Range
Notes
Acrylic shower box
$900–$2,000
Budget-friendly, low maintenance, quick install
Custom tiled shower
$2,500–$4,000
Premium look, more labour-intensive
Hinged glass door
$800–$1,500
Standard option, lower cost
Sliding glass door
$1,200–$2,500
Higher cost, requires precise installation
New plumbing lines
$1,000–$2,500
Avoid if existing pipes are serviceable
Bathroom Tiling Costs Per Square Metre
Flooring choice sits alongside this decision. Our guide to bathroom flooring options in NZ compares tile against the alternatives, and acrylic versus tiled showers covers the biggest single tiling decision in the room. Tiling costs in Auckland depend on tile size, material, and the scope of the work, not just the area being covered. Smaller tiles (mosaics, 10x10cm) need more cutting, more grout, and more labour time. Larger formats (60x60cm) cover ground faster but are heavier and need precise levelling.
Tile Size
Auckland Cost/m²
NZ Average/m²
Notes
Small (10x10cm)
$70–$120
$60–$100
More grout lines, more labour
Medium (30x30cm)
$60–$100
$50–$90
Popular balance of cost and look
Large (60x60cm)
$80–$150
$70–$120
Fewer grout lines, heavier to handle
Material type matters as much as size. Ceramic ($30–$50/m²) is the budget choice, fine for rentals. Porcelain ($50–$100/m²) is the sweet spot for most Auckland homes: durable, water-resistant, and wide range of styles at Tile Depot. Natural stone ($80–$150/m²) is premium territory, it needs sealing and maintenance, but it looks the part in a high-end Remuera or Herne Bay bathroom.
Waterproofing is mandatory in wet areas under NZ Building Code Clause E3. Skip it and you’re looking at leaks, mould, and a repair bill that dwarfs the $400–$1,500 you would have spent doing it properly.
Shower area only (2–3m²): $400–$600 in Auckland. Full bathroom (10m²): $800–$1,500. Quality membrane products (Mapei, $20–$30/m²) cost more than generic alternatives but perform better in Auckland’s humid climate.
Total Cost Example, 10m² Auckland Bathroom Tiling
Mid-range 30x30cm porcelain tiles at $80/m²: tiles $800, labour $600–$1,000 (6–10 hours at Auckland rates), waterproofing $1,000, prep and disposal $300–$500. Total: $2,700–$3,300. The same job in Wellington: $2,200–$2,800.
💡 Quick tip: Larger tiles (60x60cm) cut labour time, saving $100–$300. If budget is tight, tile only the shower area (2–3m², $120–$300 in materials) instead of full walls. You still get the impact where it counts.
Vintage bathroom, North Shore, Englefield fixtures throughout. The client wanted a consistent vintage aesthetic, so fixture selection was central to the design brief.
7 Factors That Affect Bathroom Renovation Costs in NZ
Two bathrooms that look identical on paper can cost $10,000 apart. Here’s what actually moves the number, and where you have control.
1. Bathroom size. A standard NZ bathroom runs 8–12m². Bigger bathrooms need more tiles and more waterproofing membrane, but the fixed trade costs (callouts, minimum charges, coordination) stay roughly the same regardless of size. That’s why small bathrooms aren’t as cheap as people expect.
2. Material quality. This is the biggest variable you control. Natural stone at $150/m² versus ceramic at $30/m² on a 10m² floor is a $1,200 difference on materials alone, before labour. The decision is a trade-off between upfront cost and long-term durability. In Auckland’s humid climate, cheaper materials can degrade faster.
3. Design complexity. A straightforward refresh costs less than a custom layout. Adding a new shower, changing where the toilet sits, or installing custom cabinetry all increase labour time. Every hour of trade time at $90–$120 adds up.
4. Plumbing and electrical work. Moving or adding plumbing requires licensed professionals and often Building Consent. These are non-negotiable costs, cutting corners here creates insurance problems and consent issues that are expensive to fix later.
5. Labour costs. Labour is 40–50% of every Auckland bathroom renovation. Experienced, reputable trades cost more per hour but deliver fewer callbacks, fewer delays, and better results. Sound familiar? The cheapest quote rarely turns out cheapest in the end.
6. Consents and fees. Depending on scope, Building Consent from Auckland Council may be required, $500–$2,500 in fees plus 1–4 weeks processing time. Heritage homes in Ponsonby and Mt Eden can need additional approvals ($500–$1,000 extra).
7. Location. Auckland costs more than the rest of New Zealand. Full stop. Higher labour rates, higher material costs, higher demand for skilled trades. Apartments and multi-storey buildings can also carry additional access costs for getting materials in and waste out.
“The factor most Auckland homeowners underestimate is what’s behind the walls. We opened up a 1960s Mt Eden bungalow last year and found rotten framing, outdated wiring, and no waterproofing at all. That turned a $25,000 job into a $38,000 job, but now it’s done properly and it’ll last decades.” — Eunice Qin, Designer, Superior Renovations
💡 Quick tip: Always add 15–20% contingency to your budget. Auckland’s older housing stock, villas, bungalows, leaky-era homes, regularly produces surprises once the GIB comes off. A $30,000 budget should have $4,500–$6,000 set aside for the unexpected.
Building Consent, Timelines, and the 5 Mistakes That Cost Money
When Do You Need a Building Consent?
Not every bathroom renovation needs consent. But getting this wrong is expensive, fines up to $200,000 apply under the Building Act for unconsented work.
Renovation Type
Consent?
Fee
Timeline Impact
Like-for-like fixture swaps
Usually no
$0
None
Mid-range (new tiled shower, plumbing changes)
Often yes
$1,000–$2,500
2–3 weeks
Structural changes, wet rooms, wall removal
Yes
$2,000–$3,500+
3–4 weeks
Auckland Council specifics: Minor plumbing work under $5,000 with a producer statement attracts a fixed fee of $343. Adding new sanitary fixtures, tiled wet areas, or drainage changes generally requires full consent. Replacing an existing toilet or sink in the same position is usually exempt under Schedule 1 of the Building Act 2004, but always check first. Visit aucklandcouncil.govt.nz or call 09 301 0101.
How Long Does a Bathroom Renovation Take in Auckland?
Renovation Type
Auckland
NZ Average
Budget refresh
3–7 days
2–5 days
Mid-range full renovation
3–4 weeks
2–3 weeks
Luxury / structural
4–8 weeks+
5–6 weeks
Auckland takes longer because of tradie availability (high demand means 1–2 week delays before work starts), Building Consent processing (1–3 weeks through Auckland Council), and humidity slowing drying times for paint and grout. Pre-ordering tiles from Tile Depot (allow a week for delivery) and using a project manager ($1,000–$2,000) both shorten the timeline. For a deeper look at scheduling, see our guide: How long does a bathroom renovation take in NZ?
The 5 Mistakes That Actually Cost Auckland Homeowners Money
1. Skipping consent. Assuming minor plumbing changes don’t need consent. The cost: fines ($1,000+) or forced rework ($5,000–$10,000) from council non-compliance. The consent ($500–$2,500) is always cheaper than the alternative.
2. Underestimating costs. Budgeting $10,000 for a job that’s realistically $20,000–$35,000 in Auckland. Mid-project cuts compromise quality. Stopping work while you find more funds is expensive in a different way, idle tradies, extended timelines, interest on bridging finance.
3. Choosing cheap materials that don’t last. Vinyl flooring ($20–$40/m²) or $50 tapware that fails within two years in Auckland’s humidity. Replacement costs $1,000–$2,000 versus porcelain ($50–$100/m²) or mid-range tapware ($150–$300) lasting 10+ years. Match material quality to how long you plan to live in the house.
4. Skipping ventilation. A $200 extractor fan prevents $1,000–$3,000 in mould remediation, and it’s mandatory for rental properties under the Healthy Homes standards. Cheap insurance.
5. Poor scheduling. Not coordinating trades or ordering tiles late stalls a $20,000+ job. Idle labour adds $500–$1,000. Rushed work creates quality problems that cost $600+ to redo. Plan 4–6 weeks ahead and pre-order everything before the first demo day.
Auckland example — Mt Eden: A homeowner budgeted $15,000 for a 10m² renovation but skipped a $1,500 consent for plumbing changes. Council halted the job, adding three weeks and $3,000 in corrections. Total reached $22,000. Proper planning and the consent upfront would have kept it at $18,000.
💡 Quick tip: Check consent requirements with Auckland Council before you finalise your renovation brief. A five-minute phone call to 09 301 0101 can save you thousands and weeks of delay.
Choosing Materials and 2026 Bathroom Renovation Trends in Auckland
Material choices shape both the cost and the result. Auckland’s humidity and property market mean these decisions carry more weight here than in most NZ cities.
Material Comparison — What to Use Where
Material
Cost
Best For
Ceramic tiles
$30–$50/m²
Rentals, budget renovations
Porcelain tiles
$50–$100/m²
Mid-range family homes, the sweet spot
Natural stone tiles
$80–$150/m²
Luxury owner-occupied homes
Laminate vanity
$200–$500
Rentals, affordable, mimics timber
Solid timber vanity
$1,000–$3,000
Luxury homes, needs maintenance
Acrylic shower
$900–$2,000
Rentals, mid-range, quick install
Tiled shower
$2,500–$4,000
Mid-to-high-end, customisable, durable
Auckland’s humidity (70–80% year-round) means moisture-resistant choices matter at every price point. Vinyl flooring ($20–$40/m²) looks good initially but warps and degrades faster in our climate. Porcelain and acrylic hold up better long-term and cost less to maintain.
What’s Trending in Auckland Bathrooms for 2026
These are the trends we’re seeing across our Auckland projects right now, what’s working, what it costs, and where it makes sense.
Matte black fixtures ($500–$1,500 for a full set) remain the dominant choice across Auckland, from Ponsonby rentals through to Parnell luxury homes. Chrome sets run $300–$800, the premium for matte black is real but the look holds value.
Large-format tiles ($1,400–$2,500 for 10m²) are increasingly popular because they mean fewer grout lines, less cleaning, and less labour. Porcelain at $50–$100/m² from Tile Depot gives excellent results without the cost of stone.
Wet rooms ($10,000–$15,000) suit Auckland’s compact apartments and inner-city homes. Building Consent is typically required ($1,000–$2,500). Space-efficient, easy to clean, but only cost-effective for owner-occupiers, not rental properties.
Floating vanities ($500–$1,500 mid-range, $2,000–$3,000 luxury) make small Auckland bathrooms (5–7m²) feel more open. Laminate versions ($200–$500) keep costs low for rentals without looking cheap.
Smart lighting ($300–$800 plus $500–$1,000 electrical labour) adds quality to a mid-range renovation with minimal disruption. LED strips and motion sensors are energy-saving and add a premium feel.
Bathroom Renovations Across Auckland, and What Changes by Area
We work across the whole region from our Wairau Valley base, and the honest answer is that the price bands above hold everywhere in Auckland. What changes by area is the housing stock, and the housing stock is what produces surprises once the walls are open.
South Auckland, Papatoetoe, Manurewa, Papakura, Otahuhu and out through Flat Bush, is where we do the most work on 1960s and 1970s homes and on investment properties. The recurring theme is bathrooms that were compact by design and have had one previous patch-up. That is a straightforward job, and it is the part of the region where an affordable bathroom renovation genuinely means the budget-refresh band rather than a compromise on the work itself.
West Auckland, Henderson, Titirangi, New Lynn, Massey and Te Atatu, mixes weatherboard bungalows with 1990s subdivisions. Bush-clad Titirangi sites bring ventilation and damp questions that a Papakura brick-and-tile does not, so extraction and waterproofing detail matter more here than tile selection does.
Central and eastern suburbs, Ponsonby, Grey Lynn, Mt Eden, Remuera, Epsom, St Heliers, are villa and bungalow territory. Old floor structures, cast-iron waste pipes and rooms that were converted from something else are common, and heritage or character-area rules can apply to anything that changes the exterior.
The North Shore, Takapuna, Devonport, Albany, Browns Bay and out to the Hibiscus Coast, spans everything from character homes to plaster-clad 1990s builds. On the 1990s stock the first question is always weathertightness, because a bathroom is where an existing moisture problem tends to surface first.
None of that changes the trades or the sequence. It changes what we expect to find on strip-out, which is the number that actually moves a bathroom budget.
What to Look For in a Renovation Company
In Auckland’s busy renovation market, your choice of builder shapes the result, the timeline, and the final cost. Here’s what matters.
Experience with Auckland homes. Look for 5+ years in bathroom renovations specifically. Companies familiar with Auckland’s older villas and bungalows handle the surprises better, rotten floors, outdated wiring, heritage compliance in Ponsonby and Mt Eden. Visit our Wairau Valley showroom to see completed work firsthand.
Licensed and insured. Licensed Building Practitioners (LBP) and liability insurance are non-negotiable. Verify LBP status at building.govt.nz. Before you sign anything, our guide to choosing the right renovation company covers the checks worth doing. Unlicensed work creates consent and insurance problems down the track.
Transparent quotes. Get a breakdown: labour, materials, fixtures, consents. Vague quotes lead to unexpected costs mid-project. Get three quotes and compare the detail, not just the total.
Project management included. Companies that coordinate all trades ($1,000–$2,000 as part of the service) save the headache of managing plumbers, tilers, and electricians yourself. For any project over $20,000, it’s worth every dollar.
Reviews and references. 4+ stars on Google, and ask for two or three references from similar-scope projects. Auckland’s busy tradies can overcommit, reviews tell you whether they follow through. Check out our online reviews and client stories.
💡 Quick tip: Peak renovation season (summer) books out 4–6 weeks ahead in Auckland. If you’re planning for summer, start the conversation with your renovation company in autumn. We’ve seen clients miss their preferred window by waiting until October to call.
Ready to see materials in person? Our Wairau Valley showroom (16B Link Drive, Auckland) is open 7 days, 9am–5pm, with 5 bathroom displays, 3 kitchen setups, and hundreds of materials to compare. Call us on 0800 199 888.
How to Finance Your Auckland Bathroom Renovation
Auckland bathroom renovation costs range from $9,000 for a basic rental refresh to $65,000+ for a high-end build. How you fund it matters as much as how you plan it.
Personal savings work well for budget renovations ($9,000–$16,000). No interest, full control, but set aside an extra 15–20% for what older Auckland homes regularly produce behind the walls.
Home loans make sense for larger projects, using your property’s equity at competitive rates (often 4–6%). Superior Renovations partners with Linda Eagleton from Loan Market to help clients assess their options and structure finance against their home, particularly useful for mid-to-high-end renovations ($20,000–$65,000). More detail in our renovation finance guide.
Q Mastercard interest-free financing (available through Superior Renovations, see finance options) offers up to 18 months interest-free. Spreading a $36,000 renovation over 18 months at around $2,000 per month is manageable for most Auckland households. Standard lending criteria apply.
Personal loans (8–14% interest) suit mid-range projects where the payback period is short. Credit cards work for small add-ons ($150–$400 tapware) paid off quickly, avoid using them for anything larger.
A common split: part savings, part borrowing. On a mid-range Auckland bathroom, funding roughly the first third from savings and the balance on interest-free finance or an increase against the home loan is the pattern we see most often, and it keeps the contingency in cash rather than tied up in a fixed drawdown.
💡 Quick tip: Match your financing to your renovation scope and repayment comfort. Rentals: savings or interest-free finance to preserve cash flow. Owner-occupied homes: home loans give the best rates for long-term gain.
Completed Bathroom Renovations by Superior Renovations
Featured Projects (Mid-Range to Luxury)
Luxury bathroom renovation in Redvale, Auckland
Two bathrooms renovated to a luxury feel at mid-range cost. Sold with the property. Custom built-in vanities maximised storage in the available space. Full project details and photos.
Mid-range bathroom renovation in St Heliers
Three leaky bathrooms renovated in a contemporary style, timber-look tiles paired with white fixtures. The warm wood tone against white makes the space feel larger and brighter. See project details.
Contemporary bathroom renovation in Titirangi
Art deco floor tiles are the standout, each one had to align perfectly with the pattern of the next. That level of precision takes time and skill. Full project details and photos.
Spanish-style bathroom — Stanmore Bay
Mary wanted her kitchen and bathroom to feel like a Spanish villa. Blue walls, mosaic feature tiles, brass sink and tapware. A specific brief that produced a bathroom looking like it belongs in a different country entirely. See project details.
Your Next Step
Renovating a bathroom in Auckland in 2026 costs $8,000 for a no-frills rental fix through to $65,000+ for a full luxury build. Auckland’s labour rates ($90–$120/hour), material costs, and Building Consent requirements push prices above the NZ average at every tier, but smart decisions around layout, materials, and timing keep the number manageable. A company that includes project management reduces the risk of blowouts. From consents to timelines to the five mistakes that cost people money, you’ve now got the numbers to walk into a consultation knowing what to expect.
How much does a bathroom renovation cost in Auckland in 2026?
In 2026, bathroom renovation costs in Auckland range from $8,000–$15,000 for a budget refresh (fixture swaps, paint, minor tiling), $20,000–$35,000 for a full mid-range renovation (complete strip-out, new plumbing, tiling, mid-range fixtures), and $35,000–$65,000+ for custom luxury work. Auckland sits 20–30% above the NZ average due to higher labour rates ($90–$120/hour) and urban material costs.
What is the average cost to tile a bathroom in Auckland?
Tiling a 10m² bathroom in Auckland costs approximately $2,700–$3,300 including tiles ($60–$150/m² depending on material), labour ($600–$1,000 at Auckland rates), waterproofing ($800–$1,500), and prep and disposal ($300–$500). Smaller tiles cost more to install due to additional grout and cutting. The same job in Wellington runs $2,200–$2,800.
Can I renovate a rental bathroom cheaply in Auckland?
Yes, a rental bathroom refresh can be done for $1,500–$6,000 by keeping existing plumbing in place, sourcing second-hand materials (vanity from Trade Me at $200, tiles from Mitre 10 sales at $30/m²), DIY painting with Resene moisture-resistant paint ($80–$200), and hiring individual tradies via Builderscrack. Ensure ventilation and waterproofing meet Healthy Homes standards before cosmetic work.
How long does a bathroom renovation take in Auckland?
Budget refreshes take 3–7 days. Full mid-range renovations take 3–4 weeks. Luxury projects with structural changes take 4–8 weeks or longer. Auckland timelines run longer than NZ averages due to high tradie demand (1–2 week wait before starting) and Auckland Council consent processing (1–3 weeks for plumbing or structural work).
Do I need a Building Consent for a bathroom renovation in Auckland?
Not for like-for-like fixture replacements (swapping a toilet or vanity in the same position). Mid-range renovations involving plumbing changes or new tiled wet areas often require consent ($1,000–$2,500 from Auckland Council). All projects with structural work, wall removal, wet rooms, drainage changes, require consent. Fines for unconsented work can reach $200,000 under the Building Act.
Does a small bathroom cost less to renovate in Auckland?
Not as much as you would expect. A small bathroom (5–7m²) full renovation costs $20,000–$30,000 in Auckland, close to mid-size because trades, fixed callout costs, and complexity drive the budget more than floor area. Tiles and waterproofing membrane do scale with size, but the difference is typically only $1,000–$2,000 between a 5m² and 10m² bathroom.
How much does a shower replacement cost in Auckland?
A new tiled shower in Auckland costs $2,000–$9,500 depending on tile type and bathroom size. Acrylic shower units are the budget option at $900–$2,000 installed. Hinged glass doors run $800–$1,500 versus $1,200–$2,500 for sliding doors. Reusing existing plumbing saves $1,000–$2,500. Auckland costs sit above the NZ average ($1,550–$8,250) due to higher labour rates.
What materials work best for Auckland bathrooms?
For rentals: ceramic tiles ($30–$50/m²) and laminate vanities ($200–$500). For mid-range family homes: porcelain tiles ($50–$100/m²) and acrylic showers ($900–$2,000). For luxury: natural stone tiles ($80–$150/m²) and solid timber vanities ($1,000–$3,000). Auckland's year-round humidity (70–80%) means moisture-resistant choices are important at every price tier.
What are the biggest <a href='https://superiorrenovations.co.nz/bathroom-renovation-mistakes-nz/'>bathroom renovation mistakes</a> in Auckland?
The five costliest mistakes are: skipping Building Consent (risks fines and forced rework), underestimating costs (budget $15–20% contingency for older Auckland homes), choosing cheap materials that fail in Auckland's humidity, skipping ventilation ($200 extractor fan prevents $3,000 mould damage), and poor scheduling that causes idle trade time. All are avoidable with proper planning.
What bathroom renovation trends are popular in Auckland in 2026?
Matte black fixtures ($500–$1,500), large-format tiles that reduce grout lines ($1,400–$2,500 for 10m²), wet rooms ($10,000–$15,000), floating vanities ($500–$3,000), and smart LED lighting ($300–$800 plus electrical). Matte black remains dominant across all price tiers. Rentals should stick to durable, low-maintenance options rather than trend-driven choices.
How can I reduce bathroom renovation costs in Auckland?
Keep the existing plumbing layout (saves $1,000–$5,000 in pipe relocation and potential consent fees). Refresh rather than replace cabinets ($50–$100 paint versus $800–$3,000 new vanity). Use mid-range porcelain tiles ($50–$100/m²) over stone ($80–$150/m²). Do your own painting and demolition ($500–$2,000 saving). Source clearance materials from Mitre 10 or Bunnings sales.
How much does it cost to renovate a toilet separately in Auckland?
A standalone toilet renovation in Auckland costs $6,500–$9,000 including wall and floor tiling, new toilet bowl, wash basin, piping, and disposal. Bundling with a bathroom renovation saves 10–15% through shared trade callouts. Turnaround is 5–10 working days. Consent may be required if plumbing is relocated ($343–$2,000 in Auckland Council fees).
What does a bathroom renovation cost per square metre in Auckland?
A typical Auckland bathroom is 4 to 6m2, so a budget refresh of $9,000 to $16,000 works out at roughly $1,500 to $4,000 per m2, a mid-range renovation of $25,000 to $35,000 at roughly $4,200 to $8,750 per m2, and a luxury build from $45,000 at $7,500 per m2 and up. Those rates are three to four times an extension because plumbing, waterproofing, tiling and electrical are all packed into the smallest room in the house, and most of that cost is fixed regardless of floor area. Budget from the total, not the rate.
Is bath resurfacing worth it instead of replacing the bath?
It is worth it when the bath is structurally sound and everything around it is staying. An enamelled steel or cast-iron bath with staining or a chip, in a tiled surround you are keeping, is the ideal candidate, because you avoid demolition, disturbing the waterproofing and re-tiling the surround. It is the wrong choice if the tiles are coming off, the layout is moving, there is moisture in the wall behind, or the bath is acrylic and has flexed. A resurfaced bath is a refreshed surface with a life measured in years rather than decades, and a resurfacing specialist should quote it after seeing the bath.
Do bathroom renovation costs change across Auckland?
The price bands hold across the region. What changes by area is the housing stock, and that is what produces surprises on strip-out. South Auckland work is mostly 1960s and 1970s homes and rentals with compact bathrooms. West Auckland mixes weatherboard bungalows with 1990s subdivisions, and bush-clad sites raise ventilation and damp questions. Central and eastern suburbs are villa and bungalow territory with old floor structures and cast-iron waste pipes. On the North Shore, 1990s plaster-clad homes raise weathertightness first, because a bathroom is where an existing moisture problem tends to surface.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
Bathroom Ventilation NZ: How to Stop Mould Before It Starts
Quick answer: Good bathroom ventilation in NZ means an externally-ducted extractor fan rated for your room size (at least 25 litres per second), used every time you shower and left running for 15–20 minutes after. That alone stops most bathroom mould. When mould keeps returning despite a working fan, it usually points to a waterproofing or grout failure — a renovation problem, not a ventilation one.
If you wipe condensation off the mirror most mornings, or you’ve scrubbed the same black patch out of the ceiling corner three times this winter, your bathroom has a ventilation problem. And in a lot of older Auckland homes, it’s not your fault — the bathroom was built before anyone took moisture seriously.
This guide walks through why NZ bathrooms mould up so readily, how to actually fix it (fan sizing included, properly), and how to tell the difference between a problem you can sort with a $200 fan and one that needs the wall opened up.
Why NZ Bathrooms Get Mould (And Why It’s Worse Here)
Free cost calculator
How much will your bathroom renovation cost?
Get an instant Auckland price range for your project — no details required to see it.
Mould needs three things: moisture, a surface to grow on, and time. A bathroom hands it all three on a plate. A single 10-minute shower can put the equivalent of a full spray bottle of water into the air of a small bathroom — and in a sealed-up room with no extraction, that moisture has nowhere to go but onto your walls, ceiling, and grout lines.
New Zealand makes this harder than most countries. Our average outdoor humidity sits high, our winters are damp, and we heat our homes less consistently than colder countries that build for it. So the air outside is already moist, and the air inside cools down enough overnight for that moisture to condense out onto cold surfaces. That’s the film you find on the window and the mirror.
Older Auckland housing stock is the usual culprit
The bathrooms that mould the worst tend to share a few traits, and we see them constantly across the city.
The pre-1940s villas and bungalows in Grey Lynn, Mt Eden and Ponsonby often have single-skin construction and a small bathroom that was carved out of an existing room decades ago — frequently with no extractor fan at all, or a window that’s painted shut. The 1970s and 80s brick-and-tile homes common through West and South Auckland tend to have internal bathrooms with no external wall and a fan that vents into the roof cavity rather than outside — which is worse than useless, because it just dumps the moisture onto your roof timbers.
Then there’s the no-window ensuite, which shows up in every era. If there’s no window and no working fan, that room cannot dry out. Simple as that.
💡 Quick tip: Check where your existing fan actually vents. Pop into the roof space and look — if the ducting is disconnected, kinked, or just blowing into the cavity, your fan is doing nothing for your mould problem. This is the single most common fault we find.
“People assume a mouldy bathroom means they’re not cleaning enough. Nine times out of ten it’s a ventilation issue, not a hygiene one. If the room can’t dry itself out between showers, no amount of scrubbing will keep mould away — it’ll be back within a fortnight.” — Cici Zou, NZ Dip. Interior Design, Certified Designer, Superior Renovations
Getting the Extractor Fan Right: Sizing, Type, and Controls
The extractor fan is the workhorse of bathroom ventilation, and most of the ones we pull out were the wrong size or wrongly installed. Getting this right is the bit that actually fixes the problem.
How to size a bathroom extractor fan
Fans are rated by how much air they move, in litres per second (L/s) or cubic metres per hour (m³/h). The goal is to swap the air in the room often enough to clear the moisture — bathrooms need a high air-change rate because the moisture load is so concentrated.
The practical method: measure your bathroom’s volume (length × width × height in metres = cubic metres), then choose a fan that can turn that air over roughly 10–15 times an hour. For a typical 6m³ Auckland bathroom that works out to a fan moving at least 25 litres per second — and for anything larger, or an ensuite with a separate shower, you want to step up to 60 L/s or more. Undersizing is the classic mistake. A whisper-quiet little fan that can’t shift the air is just decoration.
Bathroom size
Approx. volume
Minimum fan rating
Small / powder room
Up to 6m³
25 L/s
Standard family bathroom
6–12m³
40–50 L/s
Large bathroom / ensuite with separate shower
12m³+
60–80 L/s
Ducted (ceiling) vs wall-mounted vs window fans
Where the fan sits depends on your bathroom’s construction. Ceiling-mounted ducted fans are the most common and the most effective for NZ homes — they sit above the moisture, draw it up, and push it out through ducting to an external vent. The non-negotiable rule: that ducting must terminate outside the building, never in the roof cavity. Venting into the roof is what rots the timbers and grows mould where you can’t see it.
Wall-mounted fans punch straight through an exterior wall and are the practical choice when there’s no ceiling access or the bathroom sits on an outside wall — handy in those single-skin villas where running ducting through the ceiling is a nightmare. Window fans are the last resort, used when there’s neither ceiling nor external-wall access, though they’re less tidy and less powerful.
The best fan in the world is useless if nobody runs it long enough. Two upgrades solve that. A humidity-sensor fan switches itself on when the air gets damp and runs until the room dries out — no human decision required, which is exactly why we recommend them for households with teenagers or anyone who forgets. A timer-delay fan keeps running for a set period (15–20 minutes is the sweet spot) after you flick the light off, clearing the lingering moisture a quick shower-length blast would miss.
💡 Quick tip: Run the fan during your shower and for at least 15 minutes after. The post-shower run is where most of the moisture actually gets cleared — switching it off the moment you step out is why a lot of “working” fans still leave a mouldy room.
All fan wiring is electrical work that needs a registered electrician, so factor that into any DIY plan. If you’re already planning a bathroom renovation, the fan, ducting and lighting all get sorted properly as part of the build.
Ventilation Beyond the Fan: Windows, Passive Options, and Whole-Home Systems
A fan is the main event, but it isn’t the only lever. The more ways moist air can leave the room, the better.
Windows and passive ventilation
An opening window is the simplest ventilation there is, and it’s genuinely effective — but only if it actually opens and you actually use it. A window that’s painted shut, which we find in villas constantly, counts for nothing. The catch in winter is obvious: nobody wants to crank a window open in a Titirangi bathroom in July. So a window is a great backup, but it can’t be your only plan in the NZ climate. You need mechanical extraction you’ll use regardless of the weather.
Whole-home ventilation systems
Positive-pressure and balanced systems (the HRV-style units you’ll have seen advertised) push drier, filtered air through the whole house and lift the overall humidity baseline. They help — a drier house generally means a drier bathroom. But here’s the honest caveat: a whole-home system runs at a low, continuous flow that isn’t designed to clear the sudden moisture spike of a shower. It’s a complement to a proper bathroom extractor fan, not a replacement for one. Don’t let anyone sell you a whole-home unit as the fix for a single mouldy bathroom.
“The bathrooms that never have a mould problem are the ones with layered ventilation — a properly sized fan that does the heavy lifting, plus a window for the in-between times. You don’t need anything exotic. You need the basics done right and used consistently.” — Alison Yu, Designer, Superior Renovations
When Mould Means a Bigger Problem (And It’s Renovation Territory)
Here’s the bit the fan retailers won’t tell you, because they’re selling fans. Sometimes ventilation isn’t the problem at all — the mould is a symptom of water getting in where it shouldn’t. If you’ve fitted a correctly sized, externally-vented fan and you’re using it properly, but the mould keeps coming back, the moisture is coming from somewhere other than the air.
A few signs tell us the issue has moved from “ventilation fix” to “renovation”.
Mould that grows along the bottom of the wall or in the floor corners, rather than up high near the ceiling, suggests water is tracking in at floor level — often a sign the waterproofing membrane under the tiles has failed. Grout that’s gone soft, dark or crumbly, or silicone seals that peel away and regrow mould within weeks of being redone, point the same way. A spongy or discoloured patch on the floor, or a musty smell that lingers even when the room looks dry, can mean water has got behind the tiles and into the substrate — and once that’s happening, no fan will fix it.
This is common in bathrooms renovated cheaply or DIY’d a decade or two ago, and in the leaky-building-era homes (mid-1990s to mid-2000s) scattered right across Auckland, where waterproofing was often the weak point. Imagine you’ve finally pulled off the mouldy silicone in your Henderson ensuite, gone to reseal it, and found the GIB behind it is soft to the touch — that’s the moment a ventilation question becomes a renovation question.
If any of that sounds familiar, the cost question comes next. A mid-range full bathroom renovation in Auckland runs $25,000–$35,000, while a budget refresh — new fittings, fan, and tidy-up without re-doing the waterproofing — sits around $9,000–$16,000. The right number depends entirely on whether the waterproofing needs redoing. You can get an early sense of where you’d land with our bathroom renovation cost calculator.
💡 Quick tip: Before you spend money re-tiling or resealing, get the waterproofing assessed. Re-doing the surface over a failed membrane just buries the problem for another two years — and costs you twice.
Healthy Homes, the Building Code, and What the Rules Actually Say
There’s a lot of confused information out there about what’s legally required, so let’s be clear about who the rules apply to.
If you own and live in your home, there’s no law forcing you to install a bathroom fan — though the NZ Building Code (Clause G4) does set ventilation standards for any new bathroom or renovation that goes through consent. The legal requirement most people are thinking of is the Healthy Homes ventilation standard, and that applies to rental properties only.
If your bathroom is in a rental, the standard is specific. A fan installed after 1 July 2019 must vent to the outside and have either a ducting diameter of at least 120mm or an extraction capacity of at least 25 litres per second. All private rentals were required to meet the full Healthy Homes Standards by 1 July 2025. Worth knowing even as an owner-occupier: that 25 L/s is a legal minimum, not a performance target — for a larger bathroom it often isn’t enough to actually clear the moisture, which is why we size on room volume rather than the bare legal floor.
Important note: The Healthy Homes ventilation standard is a rental obligation, not a rule for owner-occupiers. If you’re renovating a bathroom in a home you rent out, build to the standard from the start — retrofitting compliant ducting later is more expensive than doing it once.
If you’re moving plumbing or making structural changes, your renovation will need Auckland Council consent regardless — and ventilation gets designed in properly at that stage. Our renovation FAQ covers when consent applies in more detail.
Prevention vs Remediation: Stopping It Coming Back
Cleaning mould off is remediation. Stopping it returning is prevention — and prevention is the only one that actually saves you the weekend scrubbing.
To clean existing mould, a diluted bleach or a dedicated mould product clears surface growth on tiles and grout. But if you clean it and it’s back within a fortnight, you haven’t solved anything — you’ve just reset the clock. That return is the diagnostic signal: either the ventilation isn’t doing its job, or water is getting in behind the surface.
Prevention is the boring stuff done consistently: run a correctly sized fan every shower and for 15–20 minutes after, wipe the screen and walls down, keep the door open between showers so the room can breathe, and deal with any failed grout or silicone before it lets water in. Get those right and mould struggles to get a foothold. Get the ventilation wrong and you’ll be remediating forever.
“When we design a bathroom now, ventilation is decided before the tiles. It used to be an afterthought — fan goes wherever’s easy. Do it the other way round and you build a room that dries itself out, and the homeowner never thinks about mould again.” — Dorothy Li, Design Manager, Superior Renovations
We’ve sorted bathroom ventilation as part of renovations across Auckland — from compact villa bathrooms in Ponsonby to full ensuite rebuilds in Albany — and the pattern never changes: get the extraction right and the mould problem disappears. You can see the standard of finish in our bathroom design gallery, or drop into the showroom at 16B Link Drive, Wairau Valley to talk it through.
The Bottom Line on Bathroom Ventilation
Most bathroom mould in NZ comes down to one fixable thing: air that can’t escape fast enough. Fit a fan sized to your room, vent it outside, run it long enough, and you’ve solved the problem for the price of a fan and an electrician. The moment mould ignores all that and keeps coming back, stop fighting the symptom — there’s water getting in somewhere, and that’s worth a proper look before you spend another dollar on sealant.
What size extractor fan do I need for my bathroom in NZ?
Size the fan to your bathroom's volume — length × width × height in metres — and aim to turn the air over 10–15 times an hour. As a guide, a small bathroom up to 6m³ needs at least 25 litres per second, a standard family bathroom of 6–12m³ wants 40–50 L/s, and a large bathroom or ensuite with a separate shower needs 60–80 L/s. Undersizing is the most common mistake. When in doubt, size up — a fan that's slightly too powerful clears moisture faster, while an underpowered one never quite gets there.
How do I stop my bathroom getting mouldy?
Run an externally-vented extractor fan every time you shower and leave it going for 15–20 minutes after. That single habit stops most bathroom mould. Back it up with a window when weather allows, wipe down wet surfaces, and keep the door open between showers so the room can dry. If mould still returns within a couple of weeks despite a working fan, the moisture is likely coming from a waterproofing or grout failure rather than the air — and that needs investigating, not more scrubbing.
Do I legally need an extractor fan in a bathroom in NZ?
It depends on whether you own or rent the property. If you own and live in your home, there's no law requiring a bathroom fan, though the Building Code sets ventilation standards for any consented renovation. If it's a rental, the Healthy Homes ventilation standard applies — a fan installed after 1 July 2019 must vent outside and have at least a 120mm ducting diameter or 25 L/s extraction capacity. All private rentals had to meet this by 1 July 2025.
Why does my bathroom get so much condensation?
Condensation forms when moist air hits a cold surface — your mirror, window or walls. A single shower releases a surprising amount of water vapour into a small room, and NZ's damp climate and cooler indoor surfaces make it worse, especially in winter. Older Auckland homes with single-skin walls and no insulation get the worst of it. The fix is removing the moist air before it can settle: a properly sized extractor fan, used during and after every shower, plus a window where practical.
Should an extractor fan vent into the roof or outside?
Always outside. Venting an extractor fan into the roof cavity is one of the most common faults we find, and it's actively harmful — it dumps warm, moist air onto your roof timbers, where it condenses and causes rot and hidden mould. The Building Code and Healthy Homes standard both require external venting for this reason. If you're not sure where your fan goes, check the ducting in the roof space: it should run to a vent through the roof or an external wall, with no disconnections or kinks.
What's the difference between a ducted and a wall-mounted extractor fan?
A ducted fan sits in the ceiling and pushes moist air out through ducting to an external vent — it's the most common and effective option for NZ homes, since it draws from above where moisture collects. A wall-mounted fan punches straight through an exterior wall, which suits bathrooms with no ceiling access or those sitting on an outside wall, like many single-skin villas. Both work well when sized and installed correctly. Window fans are a last resort for bathrooms with neither ceiling nor external-wall access.
Will a whole-home ventilation system fix my bathroom mould?
Not on its own. Whole-home systems like HRV-style units lift the overall humidity baseline of your house and help keep things drier generally, but they run at a low continuous flow that isn't designed to clear the sudden moisture spike of a shower. They're a useful complement to a dedicated bathroom extractor fan, not a replacement for one. If a single bathroom is your problem, a properly sized extractor fan is the more effective and far cheaper fix.
How long should I run my bathroom fan after a shower?
At least 15–20 minutes after you finish. The shower itself produces the moisture, but it lingers in the air and on surfaces well after you step out, so switching the fan off straight away leaves most of it in the room. A timer-delay fan handles this automatically — it keeps running for a set period after the light goes off. A humidity-sensor fan is even better, switching itself on when the air gets damp and running until the room has properly dried out.
My bathroom mould keeps coming back even with a fan — why?
If you've got a correctly sized, externally-vented fan that you use properly and the mould still returns, the moisture isn't coming from the air — it's getting in behind the surfaces. Common causes are a failed waterproofing membrane under the tiles, degraded grout, or silicone seals that have let go. Tell-tale signs are mould low on the walls or in floor corners, a spongy floor patch, or a musty smell when the room looks dry. At that point it's a renovation issue, and re-sealing over the top only delays it.
How much does it cost to fix a mouldy bathroom in Auckland?
It depends on the cause. If it's purely ventilation, a new extractor fan supplied and installed by an electrician is a few hundred dollars. If the mould signals failed waterproofing, you're into renovation territory — a budget bathroom refresh in Auckland sits around $9,000–$16,000, while a mid-range full renovation that re-does the waterproofing properly runs $25,000–$35,000 in 2026. The honest answer comes from assessing whether the membrane has failed, which is why we recommend getting it looked at before spending money on the surface.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
Superior Renovations is quickly becoming one of the most recommended renovation company in Auckland and it all comes down to our friendly approach, straightforward pricing, and transparency. When your Auckland home needs renovation/ remodeling services, Superior Renovation is the team you can count on for high-quality workmanship, efficient progress, and cost-effective solutions.
Get started now by booking a free in-home consultation.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Quick answer: Underfloor heating in NZ costs roughly $80–$150/m² installed for electric and $150–$200/m² for hydronic, and running an electric system in a 9m² bathroom works out around $12–$20 a month depending on your power price. It’s worth it when the floor is already coming up — far less so as a standalone retrofit.
Most people who ask us about underfloor heating have stood on a cold tiled floor in a Mt Eden bungalow at 6am in July and thought, never again. That’s the right instinct. The wrong move is deciding it’s worth it — or not worth it — before anyone’s told you what it actually costs to run, or whether your floor can even take it without a major dig-up.
We’re a renovation company, not a heating supplier. So this is the version we give clients across the table at our Wairau Valley showroom: what underfloor heating costs to put in, what it costs to run on real Auckland power prices, where it earns its keep, and where a $400 towel rail does the same job for a tenth of the money.
Underfloor heating panel – Hotwire
Electric vs Hydronic Underfloor Heating: Which One Suits a Renovation?
There are two systems, and the gap between them matters more for renovators than for new builds. Electric (sometimes called “wire” or “dry” systems) is a thin heating mat or cable that sits under your floor finish. Hydronic (“wet” systems) runs warm water through pipes laid in or under the floor.
For a renovation, electric wins most of the time. The mat is only a few millimetres thick, so it barely changes your floor height — which is the thing that quietly kills retrofits. Warmup NZ, the brand most Kiwis associate with the category, makes the same point: electric suits upgrades to existing homes, hydronic suits new slabs.
When Hydronic Actually Makes Sense
Hydronic comes into its own on a concrete slab in a new build or a full ground-floor extension — heating a large area, every day, for years. The pipes and manifold cost more upfront, but the running cost per square metre is lower, so over a whole house it pays back. Pump it through a small bathroom retrofit and the maths falls over: too much plumbing, too much disruption, for one cold room.
Here’s the short version we give people. Doing one or two rooms in an existing home? Electric. Building new or extending with a fresh slab and heating the whole floor plate? Get hydronic priced.
“The number that decides it on a reno is floor height, not the heating spec. Once you’ve got tiles, underlay and a mat to stack up against an existing doorway and the hallway floor next door, a couple of millimetres is the difference between a clean job and re-hanging every door. We work that out before we ever talk brands.” — Cici Zou, Certified Designer (NZ Dip. Interior Design), Superior Renovations
💡 Quick tip: If you’re tiling a bathroom or kitchen anyway, that’s the cheapest moment you’ll ever get to add electric underfloor heating — the floor’s open, the tiler’s there, and the only real extra is the mat and a thermostat.
The system we spec on bathroom and tiled-area jobs is Heatwell electric — it’s reliable, easy to integrate while the floor’s up, and the running costs stack up sensibly for the room sizes most Auckland homes have. We recommend by the room, not by the brochure.
How Much Does Underfloor Heating Cost to Install in NZ?
Install cost depends on the system, the area, and what’s already under your floor. Here are the ranges we work with on Auckland renovations — and where the published supplier figures sit, so you can sanity-check any quote you’re handed.
System
Install cost (per m²)
Typical bathroom (8–10m²)
Best for
Electric mat/cable
$80–$150
$1,500–$4,000
Retrofits, bathrooms, single rooms, tiled areas
Hydronic (water)
$150–$200+
Rarely cost-effective at this size
New builds, slabs, whole-home, large open-plan
Whole-home hydronic (new build)
—
$17,000–$40,000+ (full system)
Designed in from the slab up
Those per-m² figures line up with what NZ suppliers publish — installed electric figures from $60–$100/m² for straightforward jobs, climbing once you factor in a separate circuit, thermostat, and any floor prep. For a standard Auckland bathroom, budget $1,500–$4,000 for electric underfloor heating supplied and installed — and remember that’s a line item inside a wider $26,000–$35,000 mid-range bathroom renovation, not a standalone bill.
The Hidden Cost Nobody Quotes For: Floor Prep
The mat is cheap. Getting your floor ready for it sometimes isn’t. On a 1970s brick-and-tile in Manurewa with a timber subfloor, you may need a self-levelling compound or a backer board before anything goes down — that’s labour and material the headline per-m² rate doesn’t include. On a concrete slab it’s usually simpler. This is exactly why a real quote beats a calculator estimate, and why we’d rather see your floor than guess.
Want a sense of where heating sits inside your total bathroom budget before we visit? Run the numbers on our bathroom renovation cost calculator — it’ll give you a realistic range to work from.
💡 Quick tip: Always get the heating wired on its own thermostat with a timer. It’s a small line item at quote stage and it’s the single biggest lever on what the thing costs you to run later.
Underfloor Heating Running Costs in NZ — The Number Most Guides Dodge
This is where most underfloor heating content goes vague, because the honest answer takes a bit of maths. So let’s do it properly, on Auckland power prices.
Electric underfloor heating draws roughly 150 watts per square metre — the standard output rating for residential heating mats sold in NZ, and the figure EECA uses when it talks about sizing electric heating to a room. Take a typical 9m² Auckland bathroom — that’s about 1,350 watts, or 1.35 kilowatts, at full draw.
Now the price. Power costs vary a lot by retailer and plan, so we’ll run it two ways. On a keen low-user rate of 35c/kWh, running that bathroom flat-out costs around 47 cents an hour. On the MBIE national average of about 39c/kWh (its February 2026 Quarterly Survey of Domestic Electricity Prices), it’s closer to 53 cents an hour. Either way, you’re not running it flat-out.
With a thermostat and timer set for an hour or two morning and evening through winter, you’re realistically looking at around $12–$18 a month on a low-user rate, or roughly $14–$20 a month at the MBIE average, across the colder months for that bathroom — and close to nothing the rest of the year. That’s the same ballpark as a heated towel rail left on, and far less than most people assume when they hear “electric heating.”
Scale that up and the picture changes. Heat a whole open-plan living floor with electric and the monthly bill climbs fast — which is precisely why hydronic, with its lower cost per square metre, takes over for large areas. EECA makes the broader point that how you control heating matters as much as the system itself: a timer and thermostat are doing most of the work on your running cost, whatever the brand on the box.
Area
Approx. draw
Cost/hr at 35c (low-user)
Cost/hr at 39c (MBIE avg)
Realistic winter month (timed use)
9m² bathroom
~1.35 kW
~47c
~53c
~$12–$20
15m² kitchen/diner
~2.25 kW
~79c
~88c
~$25–$45
40m² open-plan (electric)
~6 kW
~$2.10
~$2.34
Hydronic territory — price it instead
The figures are indicative — your wattage, insulation, power plan and how long you run it all move the dial. But the shape is right, and it’s a lot more useful than “it depends.”
💡 Quick tip: Good underfloor heating relies on a warm, dry slab or floor holding heat. If your subfloor’s poorly insulated, you’re paying to heat the dirt below. Pairing underfloor heating with proper floor insulation is what makes the running cost behave.
Best Applications: Bathrooms, Tiles, and the Slab-vs-Timber Question
Underfloor heating shines under hard floors. Tile, stone, polished concrete — they conduct heat well and they stay warm. That’s why bathrooms are the number-one spot we install it: cold tile underfoot is the exact problem it solves, and the room’s small enough that running cost stays sensible.
Kitchens with tiled or stone floors are the next best fit. Engineered stone and quartz benchtops aside, a tiled kitchen floor over electric heating is a genuinely nice thing to stand on while you cook on a winter morning in Titirangi.
Concrete Slab vs Timber Subfloor
This is the make-or-break question for retrofits. A concrete slab is the ideal host — it stores heat and releases it slowly, so the system works efficiently. A suspended timber subfloor, common in older Auckland villas and bungalows, is trickier: there’s an air gap below, heat can escape downward without insulation, and the floor build-up has to be managed carefully. It’s still doable with electric mats over a properly prepped and insulated timber floor — we do it regularly — but it needs planning, not a punt.
What Flooring Works (and What Doesn’t)
Tile and stone are ideal. Many engineered timber and quality vinyl products are rated for underfloor heating too — but not all, and laying an unrated floating floor over heating can void its warranty or warp the boards. Always check the flooring’s underfloor-heating rating before you commit, not after. Solid hardwood is generally the wrong choice; it moves too much with the temperature swings. The Wooden Floor Company and other NZ suppliers note that engineered timber handles the temperature changes better than solid timber — which matches what we see on site.
If you’re choosing tiles and heating together, our bathroom renovation team sorts both as one decision — the floor finish, the heating, the waterproofing and the levels all get worked out before the tiler starts, which is the whole point of doing it inside a renovation.
Underfloor Heating vs Heated Towel Rail vs Panel Heater
Here’s the honest comparison — because for a lot of bathrooms, underfloor heating isn’t the right answer, and we’ll tell you that.
Option
Install cost
Heats the room?
Best when
Electric underfloor
$1,500–$4,000
Yes — warm floor + radiant warmth
You’re retiling anyway and want the floor experience
Heated towel rail
$300–$700
Partly — dries towels, takes the edge off
Budget’s tight or the floor’s staying put
Panel / wall heater
$300–$1,050
Yes — fast air heat
You want quick warmth, not warm floors
The truth most people don’t hear: if the floor isn’t already coming up, the cost of retrofitting underfloor heating alone rarely justifies it over a good towel rail plus a ceiling unit. Where it’s a no-brainer is when you’re already renovating — then the marginal cost is small and the payoff is daily.
Can You Retrofit Underfloor Heating in an Existing Auckland Home?
Yes — with one honest caveat. Retrofitting only makes sense when you’re already lifting the floor. Tearing up a perfectly good bathroom purely to add heating is money poorly spent. Doing it as part of a renovation, when the tiles are coming off anyway, is one of the best-value upgrades on the job.
The practical hurdles in an older home are floor height and the subfloor type. Add a heating mat, backer board and new tiles, and your finished floor sits higher than it did — which affects door clearances and the transition to the hallway. On a villa in Grey Lynn with a timber subfloor, that needs designing around. On a slab-on-ground 1990s home in Albany, it’s usually straightforward. None of it is exotic; it just needs to be planned at design stage, not discovered mid-build.
For whole-home or extension projects where heating is part of a bigger thermal upgrade, it’s worth thinking about the envelope as a whole — insulation, glazing and heating together. If you’re combining heating with a larger structural change, our house extensions team can build it into the plan from the start.
“The clients who love their underfloor heating are the ones who added it during a reno they were doing anyway. The ones with regrets usually retrofitted a single room in isolation and paid for the disruption without the rest of the upgrade around it. Timing is most of the value.” — Cici Zou, Certified Designer (NZ Dip. Interior Design), Superior Renovations
Does Underfloor Heating Help with Healthy Homes and Damp?
Worth being straight here, because it’s oversold elsewhere. Underfloor heating is comfortable and it warms a room evenly, which helps keep surfaces above the dew point and discourages the mould that plagues Auckland bathrooms through our damp, humid winters — NIWA describes Auckland’s subtropical climate as warm and humid with rainfall plentiful all year round. That’s a real benefit.
But it’s not a Healthy Homes compliance product. According to Tenancy Services, which administers the standards for MBIE, the Healthy Homes heating standard applies to rental properties and requires one or more fixed heaters (at least 1.5kW) that can directly heat the main living room to 18°C — alongside separate standards for insulation, ventilation, moisture and draught-stopping. Underfloor heating isn’t a recognised qualifying heater for that standard. If you’re a landlord, don’t install underfloor heating expecting it to tick the heating standard; check the actual requirements first. If you’re an owner-occupier chasing a warmer, drier home, it’s a genuine comfort upgrade — just paired with good ventilation and insulation, not instead of them.
Important note: Hardwired underfloor heating must be installed by a licensed electrician and comply with the NZ Building Code. It’s not a DIY job — and if you’re already having electrical work done in a renovation, bundling it in is the cheapest, cleanest way to get it done right.
So, Is Underfloor Heating Worth It in NZ?
If you’re renovating and the floor’s coming up, electric underfloor heating in a bathroom or tiled area is one of the easiest yeses we give. Small marginal cost, daily payoff, sensible running cost. If you’re thinking about ripping up a sound floor purely to add it, the honest answer is usually no — put the money toward a great towel rail and ventilation instead.
The decision really comes down to timing and floor type, and both are easiest to sort with someone looking at your actual home rather than a spec sheet. That’s what we do — across 1000+ Auckland renovations, heating gets decided alongside tiling, levels and waterproofing, not bolted on at the end.
It's worth it when you're already renovating and the floor is coming up — the marginal cost of electric underfloor heating in a bathroom or tiled area is small and the daily comfort payoff is high. As a standalone retrofit, where you'd tear up a sound floor just to add it, it's usually not worth it over a good heated towel rail plus a ceiling unit. The deciding factors are timing and floor type, not the heating brand.
How much does underfloor heating cost in NZ?
Electric underfloor heating runs about $80–$150/m² installed, which works out to roughly $1,500–$4,000 for a typical 8–10m² Auckland bathroom supplied and fitted. Hydronic (water) systems cost more at around $150–$200+/m² and make sense for new builds and whole-home slabs rather than single-room retrofits. Floor preparation, a dedicated circuit and a thermostat can add to the headline per-m² rate, which is why an on-site quote beats an online estimate.
Is underfloor heating expensive to run in NZ?
Not for a bathroom. Electric underfloor heating draws around 150 watts per m², so a 9m² bathroom pulls about 1.35kW — roughly 47 cents an hour on a low-user rate of 35c/kWh, or about 53 cents an hour at the MBIE national average of around 39c/kWh (February 2026). Run on a timer and thermostat for an hour or two morning and evening through winter, that's around $12–$20 a month and close to nothing the rest of the year. Costs climb fast over large areas, which is where hydronic takes over.
What's the difference between electric and hydronic underfloor heating?
Electric systems use a thin heating mat or cable under the floor finish — only a few millimetres thick, so they suit retrofits and single rooms. Hydronic systems run warm water through pipes laid in or under the floor; they cost more upfront but run cheaper per m², so they suit new builds, slabs and whole-home heating. For renovating one or two rooms in an existing Auckland home, electric is almost always the right call.
Can you retrofit underfloor heating in an existing house?
Yes, with electric mats — but it only makes financial sense when you're already lifting the floor as part of a renovation. The two practical hurdles are floor height (the mat, backer board and new tiles raise the finished floor, affecting door clearances) and subfloor type. A concrete slab is the ideal host; a suspended timber subfloor, common in older Auckland villas and bungalows, needs careful insulation and planning but is still doable.
What flooring works with underfloor heating?
Tile, stone and polished concrete are ideal — they conduct and hold heat well. Many engineered timber and quality vinyl products are rated for underfloor heating, but not all, so check the manufacturer's rating before laying anything over a heating system, as an unrated floating floor can warp or void its warranty. Solid hardwood is generally a poor choice because it moves too much with the temperature swings.
Is underfloor heating good for bathrooms in Auckland?
It's the single best application. Bathrooms are small, so running cost stays low, and cold tile underfoot is exactly the problem underfloor heating solves. Auckland's subtropical climate — NIWA describes it as warm and humid with rainfall plentiful year-round — makes warm, even heat useful for keeping surfaces dry and discouraging mould on fresh tiles. We install electric underfloor heating most often in bathrooms and tiled ensuites, specced in alongside the waterproofing and tiling rather than added afterwards.
Does underfloor heating meet Healthy Homes Standards?
Not on its own. According to Tenancy Services, the Healthy Homes heating standard applies to rental properties and requires one or more fixed qualifying heaters (at least 1.5kW) that can directly heat the main living room to 18°C, plus separate standards for ventilation, insulation, draught-stopping and moisture. Underfloor heating isn't a recognised qualifying heater for that standard, so landlords shouldn't install it expecting it to tick that box. For owner-occupiers it's a genuine comfort and dryness upgrade, best paired with good ventilation and insulation rather than used instead of them.
Underfloor heating or a heated towel rail — which should I get?
If you're retiling the bathroom anyway, underfloor heating ($1,500–$4,000) gives you a warm floor and radiant warmth across the whole room. If the floor's staying put or the budget's tight, a heated towel rail ($300–$700) dries towels and takes the chill off at a fraction of the cost. Many Auckland bathrooms do well with a towel rail plus a 3-in-1 ceiling unit, with underfloor reserved for when the floor is already open.
Do I need building consent for underfloor heating?
The heating mat itself usually doesn't, but the electrical work must be done by a licensed electrician and comply with the NZ Building Code, and any wider bathroom renovation it's part of may trigger consent for plumbing or waterproofing changes. The simplest path is to install underfloor heating as part of a managed renovation where the consents and the licensed trades are already handled — which removes the guesswork for you.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
Quick answer: To renovate a bathroom in NZ you work through eight stages in a fixed order — design, ordering, demolition, plumbing and electrical rough-in, lining, waterproofing, tiling, then fit-off. A standard Auckland bathroom takes three to four weeks from the day demolition starts, longer if council consent is needed.
Most guides tell you a bathroom renovation has “five easy steps” and then spend the rest of the page talking about cost. That’s not much help when you’re standing in your only bathroom wondering how long you’ll be showering at the gym.
So here’s the part nobody explains properly: the order of a bathroom renovation isn’t a suggestion — it’s a chain of dependencies, where each stage physically cannot start until the one before it has finished and, in some cases, cured. Get the sequence wrong and you’re ripping out new tiles to fix a pipe. This guide walks the real process the way it runs on an Auckland job site, with a genuine week-by-week timeline and an honest look at what makes projects run late.
There’s a reason we take this seriously. A bathroom is the most complex room in the house to renovate — not because it’s big, but because it’s small and crammed with trades. Demolition crew, plumber, electrician, waterproofer, tiler, painter, and the fit-off team all have to move through the same few square metres in the right order. Coordinating that is the whole job.
First, Know Which Project You’re Running
Before the process makes sense, one decision shapes everything after it: are you doing a cosmetic refresh or a full strip-out? A refresh keeps the layout, plumbing positions, and waterproofing intact — you’re updating surfaces and fixtures, and you can often be back in the room inside a fortnight. A full strip-out takes the room back to the framing, runs the complete eight-stage process below, and is the right call when the bones need work or you’re moving fixtures.
That choice deserves its own proper comparison — costs, timelines, and the signs that push a job one way or the other. We’ve covered it in full over here: deciding between a refresh and a full renovation. The rest of this guide walks the full renovation process — the harder of the two paths, and the one where getting the order right actually matters.
💡 Quick tip: If you’re moving any fixture more than a few hundred millimetres, you’ve left “refresh” territory. Relocating a toilet or shower drain means new drainage falls, which means opening the floor — plan it as a full strip-out, not a tidy-up.
The Bathroom Renovation Process, Stage by Stage
This is the part the five-step guides skip. Each stage gates the next — and understanding why is what stops you making expensive ordering mistakes. We’ll walk a full strip-out, the more involved of the two paths.
Stage 1 — Design and final decisions
Nothing physical happens until every decision is locked. Layout, fixture positions, tile selections, tapware, vanity, lighting, heating, the lot. This feels slow when you’re keen to get started, but it’s the single biggest protection against blowouts. Gathering bathroom design ideas before this stage makes those decisions far easier to lock in. Every decision left open when the trades arrive becomes a delay, a variation, or both.
A villa in Grey Lynn with original rimu framing needs decisions a 2010s townhouse in Flat Bush never will — where the waterproofing meets old timber, how a heated towel rail gets wired into knob-and-tube remnants. The design stage is where those get solved on paper instead of mid-build.
“The decisions people think they can leave until later are exactly the ones that hold a job up. Tile choice, where the niche sits, which way the vanity drawers open — sort those at the design table and the build just runs. Leave them, and the tiler’s standing in your bathroom waiting on a phone call.” — Cici Zou, NZ Dip. Interior Design, Certified Designer, Superior Renovations
Stage 2 — Ordering and lead times
Everything gets ordered and, ideally, delivered to site before demolition starts. This is non-negotiable for a reason: a standard three-to-four-week timeline assumes all materials are on site before the first tile comes off the wall. A custom vanity on a six-week lead time, ordered the week demolition starts, doesn’t delay your bathroom by the difference — it stalls the whole job, because tiling and fit-off can’t proceed around a missing centrepiece.
Tapware, tiles, shower trays, and toilets are usually quick. Custom vanities, imported tiles, and made-to-order shower glass are the long poles. Order them first.
Stage 3 — Demolition and strip-out
Now the old bathroom comes out — fixtures, tiles, linings, sometimes back to the framing. On a standard job this takes a couple of days. It’s also the stage where the house tells you its secrets: rotten framing behind a leaking shower, old galvanised pipes due for replacement, a subfloor that’s been quietly wet for years. In Auckland’s older stock — the pre-1940s villas and bungalows through Mt Eden and Ponsonby — finding something behind the wall is closer to the rule than the exception.
💡 Quick tip: Build a contingency of 10–15% into your budget specifically for what demolition uncovers. On homes built before 1960, treat it as a near-certainty rather than a maybe — rotten framing and dead plumbing don’t announce themselves until the GIB is off.
Stage 4 — Plumbing and electrical rough-in
With the walls open, the plumber and electrician do their “rough-in” — the pipework and wiring that lives inside the walls and floor. New drainage falls for a relocated toilet, hot and cold feeds for the shower and vanity, wiring for lights, the extractor fan, underfloor heating, and the heated towel rail. This work has to happen now, while everything’s open, because the next stage seals it inside the walls for good.
In NZ this is regulated work. Plumbing and drainage must be carried out by a registered plumber or drainlayer, and the electrical work by a registered electrician — both certify their own work. According to the Plumbers, Gasfitters and Drainlayers Board, this work is restricted to licensed tradespeople by law. It’s not a corner you can cut, and it’s not a DIY stage.
Stage 5 — Lining and the pre-line check
The walls get re-lined, in a bathroom with a moisture-resistant board such as GIB Aqualine rather than standard plasterboard. Before the lining goes up, the rough-in gets checked — once it’s covered, fixing a missed pipe means cutting open new work. Measure twice, line once.
Stage 6 — Waterproofing (and why it can’t be rushed)
The wet areas — shower, floor, splash zones — get a waterproof membrane applied. This is the most important stage in the entire renovation and the one most likely to be hurried by an impatient schedule. Done properly it’s invisible for the life of the bathroom. Done badly it’s the leak that rots the framing you’ll be paying to replace in five years.
Here’s the bit that trips up DIY timelines: the membrane needs curing time before anything goes on top of it. Depending on the product and the weather, that’s typically 24 to 48 hours where the room sits doing nothing. You can’t tile over a membrane that hasn’t cured. It’s dead time on the schedule that can’t be compressed, and in an Auckland winter — June through August — slower curing in the cold and damp can stretch it further.
“If a quote has the tiler starting the morning after the waterproofer finishes, I’d want to know why. The membrane needs to cure, full stop. We’ve seen the shortcuts other people’s bathrooms were built on when we strip them out — and the cure time is almost always where someone tried to save a day and cost the owner a re-do.” — Dorothy Li, Design Manager, Superior Renovations
New Zealand wet-area waterproofing sits under the Building Code clause E3 (internal moisture). Per Building Performance (MBIE), surfaces in wet areas must be impervious, easily cleaned, and ventilated to avoid the accumulation of moisture and fungal growth. The membrane itself is installed to the wet-area membrane standard AS/NZS 4858 and the Waterproofing Membrane Association’s Code of Practice for Internal Wet-area Membrane Systems, the documents the industry works to for compliance with E3. This is why waterproofing is one of the stages a good renovation company will never let a homeowner DIY.
Stage 7 — Tiling
Now the tiler goes to work — floor and walls, then grouting and sealing once the adhesive has set. On a standard bathroom this is several days of work, and it’s another stage with built-in waiting: tile adhesive needs to set before grouting, and grout needs to cure before the shower gets used. Tiling is also where the quality of every earlier stage shows up — a level floor, square walls, and a properly prepped substrate are what let a tiler do clean work.
Stage 8 — Fit-off and final checks
The finishing stage. The plumber returns to install and connect the toilet, vanity, tapware, and shower fittings. The electrician fits the lights, fan, switches, and heated towel rail. Painting is finished, the shower glass goes in, the mirror and accessories go up. Then a final check — every joint tested for leaks, every fitting working, the room cleaned and handed back.
How Long Does a Bathroom Renovation Take in Auckland?
So how long are you actually without a bathroom? A standard full bathroom renovation takes three to four weeks from the day demolition begins — and that figure assumes design is finalised and all materials are on site before work starts. Here’s how those weeks break down on a typical Auckland job.
Stage
Typical duration
What’s happening
Demolition
1–2 days
Strip-out to framing; uncover any surprises
Plumbing & electrical rough-in
2–4 days
In-wall pipework and wiring, certified by trades
Lining & pre-line check
1–2 days
Moisture-resistant board fixed after rough-in sign-off
Waterproofing + cure
1 day work + 24–48 hrs cure
Membrane applied, then mandatory drying time
Tiling, grouting & sealing
3–5 days
Floor and walls, with set and cure time between
Fit-off & final checks
2–4 days
Fixtures connected, painting, glass, leak testing
Total (standard, no consent)
3–4 weeks
From demolition to handover
Notice the timeline isn’t just the sum of the labour. The cure times between waterproofing and tiling, and between tiling and use, are built-in waits that no amount of money makes go faster. That’s why “we’ll have it done in a weekend” is a promise worth being suspicious of.
💡 Quick tip: If your home has only one bathroom, plan where you’ll wash for a month before demolition day — a relative nearby, a gym membership, or timing the job around a holiday. The single-bathroom squeeze catches more Auckland homeowners off guard than the budget does.
Want a realistic budget to sit alongside this timeline? You can estimate your bathroom renovation cost in a couple of minutes before you commit to anything.
Consent: The Bit That Changes Your Timeline
Consent is the single biggest variable in how long your renovation takes — and the part homeowners most often forget to plan around. Most standard bathroom renovations don’t need building consent, because replacing fixtures in the same positions is repair and replacement. You’ll generally need it if you’re moving plumbing to a new location, removing or adding walls, or changing electrical beyond standard replacements — and heritage overlays (common across Devonport, Ponsonby, and Mt Eden) add their own layer.
We’ve covered exactly what crosses the line, and the Schedule 1 detail behind it, in our guide on when a renovation needs building consent. What that guide doesn’t dwell on — and what matters most for sequencing — is the clock.
If your renovation needs consent, Auckland Council has a statutory timeframe of 20 working days to process the application once it’s accepted as complete, per Auckland Council. In practice, MBIE’s nationwide consent monitoring for the fourth quarter of 2025 put the median processing time at 10 working days for residential applications, with around 96% processed inside the statutory window (MBIE Building Consent System Performance Monitoring). The catch is that the clock only runs once your application is accepted — and any Request for Information stops it until you respond. Add design and documentation time on top, and a realistic consent allowance of four to eight weeks sits before demolition can even start. Plan it as the front of your timeline, not an afterthought. Even where no consent is needed, the work still has to meet the New Zealand Building Code, and plumbing and drainage run under their own certification by the registered tradesperson.
💡 Quick tip: If consent is even a possibility, get the application in early — ideally while your fixtures are still on order. Running the consent clock in parallel with your lead times, rather than after them, can claw back weeks. We handle the whole application in-house so it’s not on your plate.
What Actually Makes a Bathroom Renovation Run Late
The three-to-four-week timeline is real — but it’s the timeline for a job that’s been set up properly. Here’s what turns three weeks into seven, and almost none of it is the actual building work.
Decisions made late
The single biggest cause of delay isn’t a trade — it’s a homeowner who hasn’t chosen the tiles yet. Every decision still open when the trades arrive becomes a gap in the schedule. The design stage exists to kill this risk. Use it.
Materials ordered too late
We’ve said it already because it matters most: a long-lead custom vanity or imported tile ordered after demolition starts doesn’t delay itself, it delays everything downstream. A job in Henderson we picked up mid-stream had stalled for three weeks waiting on a vanity the previous builder ordered the day they started. The room sat gutted the whole time.
What demolition uncovers
Rotten framing, failed old waterproofing, dead galvanised pipes, a subfloor that needs replacing. On Auckland’s pre-war housing stock this is common, and it adds both time and cost. It’s not bad luck — it’s the age of the house — which is exactly why the contingency budget exists.
The consent clock and RFIs
If consent’s involved, an incomplete application drawing a Request for Information can add weeks, because the processing clock stops until the council has what it asked for. Getting the application right the first time is worth more than getting it in fast.
Cure times in winter
Waterproofing membranes and tile adhesives cure slower in cold, damp conditions. An Auckland bathroom renovated in July will have longer dead-time waits than the same job in February. It’s minor, but on a tight timeline it’s real.
“People assume the delays are the building. They’re almost never the building. They’re a tile that wasn’t chosen, a vanity that wasn’t ordered, or a consent that wasn’t lodged early enough. The trades are the easy part to schedule — it’s everything around them that needs managing.” — Dorothy Li, Design Manager, Superior Renovations
This is the real argument for a managed renovation over a DIY-coordinated one. It’s not that the individual stages are hard — it’s that holding seven trades, a materials schedule, cure times, and a council clock in the right order, in a room you can’t work in two people at once, is a full-time job. That coordination is what we do across our Auckland projects, from a single ensuite in Remuera to a full main bathroom in a Titirangi do-up.
Bringing It Together
A bathroom renovation isn’t complicated to understand — it’s a chain of eight stages, run in order, where the waiting between some of them matters as much as the work itself. Get the design locked, get the materials ordered early, respect the cure times, and sort the consent question before you swing the first hammer, and a standard Auckland bathroom is a three-to-four-week job.
The hard part was never knowing the steps. It’s running them in the right order, around one small room, without a missed pipe or a rushed membrane costing you twice. That’s the bit worth handing to a team that does it every week.
A standard full bathroom renovation in Auckland takes three to four weeks from the day demolition begins, assuming the design is finalised and all materials are on site before work starts. The timeline includes built-in cure times for waterproofing and tile grout that cannot be sped up. If your renovation needs Auckland Council consent — for moving plumbing or structural changes — allow four to eight weeks for design, documentation and processing before work can start.
What order do you renovate a bathroom in?
The sequence is fixed because each stage depends on the one before it: design and final decisions, ordering materials, demolition, plumbing and electrical rough-in, lining, waterproofing, tiling, then fit-off. Waterproofing must cure before tiling, and tile adhesive must set before grouting. Skipping or reordering stages — for example tiling before the membrane cures — leads to leaks and re-work, which is why the order is treated as non-negotiable on a professional job.
Do I need building consent to renovate a bathroom in NZ?
Most standard bathroom renovations do not need consent if you replace fixtures in the same positions. Consent is generally required if you move plumbing to a new location, remove or add walls, change electrical beyond standard replacements, or your home has a heritage overlay. Even exempt work must meet the New Zealand Building Code, and plumbing and drainage run under their own certification rules. Superior Renovations assesses this at your free consultation and handles any application.
How much does it cost to renovate a bathroom in Auckland?
In Auckland in 2026, a mid-range full bathroom renovation costs between $25,000 and $35,000, covering design, fixtures, all trades, and project management. A budget refresh of paint, fittings, and minor tiling starts from $9,000 to $16,000. A luxury bathroom with a wet room or premium fixtures starts from $45,000 and up. These figures reflect a 5–8% rise on 2025 due to material and labour inflation. Your final cost depends on size, product choices, and whether consent is required.
Can I live in my house during a bathroom renovation?
Yes, as long as you have another bathroom to use. If it is your only bathroom, you will need to plan alternative washing arrangements for the three to four weeks the room is out of action — a relative nearby, a gym, or timing the job around a holiday. The room itself is unusable from demolition through to fit-off because the floor is open, the plumbing is disconnected, and the waterproofing needs to cure undisturbed.
Why does waterproofing take so long in a bathroom renovation?
The work itself is quick, but the waterproof membrane needs curing time before anything can be tiled over it — typically 24 to 48 hours depending on the product and the weather. This is dead time on the schedule that cannot be compressed, and it cures slower in an Auckland winter. It is also the most important stage in the renovation: a rushed or skipped membrane is the most common cause of leaks that rot framing and force an expensive re-do years later.
What is the most common cause of bathroom renovation delays?
Late decisions and late material orders, not the building work. Every fixture or finish still unchosen when the trades arrive becomes a gap in the schedule, and a long-lead custom vanity or imported tile ordered after demolition starts stalls the whole job rather than just itself. On older Auckland homes, what demolition uncovers — rotten framing or dead plumbing — is the other major cause. Locking decisions and ordering early is the single best protection against a blowout.
How long does Auckland Council consent take for a bathroom renovation?
When consent is required, Auckland Council has a statutory timeframe of 20 working days to process the application once it is accepted as complete. MBIE's nationwide monitoring for late 2025 put the median residential processing time at around 10 working days, with most applications cleared inside the statutory window. A Request for Information stops the clock until you respond, and the clock only starts once the application is accepted — so it is best lodged early, ideally while your fixtures are still on order, so processing runs in parallel with your material lead times.
Is a bathroom renovation a good DIY project?
Some stages, like painting or removing old fixtures, are DIY-friendly. The core stages are not. Plumbing, drainage, and electrical work must legally be done and certified by registered tradespeople in NZ, and waterproofing is the single stage most likely to cause expensive failure if done incorrectly. The bigger challenge is coordination — sequencing seven trades, material lead times, cure waits, and a possible consent clock around one small room is what makes a bathroom the most complex room in the house to renovate.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
Quick answer: A bathroom refresh in Auckland costs $3,000–$16,000 and takes a few days to two weeks, while a full bathroom renovation runs $25,000–$60,000+ and takes three to six weeks — the right choice depends on the age of your bathroom, the condition behind the walls, and how long you plan to stay in your home.
This is the question we hear more than almost anything else at first consultations. A homeowner walks into our showroom at 16B Link Drive, Wairau Valley, pulls out their phone, shows us photos of a tired bathroom, and asks: “Do I actually need to gut the whole thing, or can I just update it?”
Fair question. And the honest answer is: it depends. Not on what we’d prefer to sell you — but on what’s actually going on in that bathroom.
A partial renovation (cosmetic refresh) works well when the bones are good — sound waterproofing, functional plumbing in the right positions, no moisture damage behind the tiles, and a layout that already works for your household. In those cases, spending $25,000+ to strip everything back to the framing would be overkill.
A full renovation makes sense when the bathroom has deeper problems. We’re talking failed waterproofing membranes, outdated plumbing that’s rusting or undersized, poor ventilation causing mould behind the GIB, or a layout that just doesn’t work for the way your family uses the space. In an older Auckland villa — say, a 1960s place in Mt Eden or a 1970s brick-and-tile in Pakuranga — there’s often more going on behind the walls than the surface suggests.
We’ve put this guide together because the existing advice online is mostly generic cost guides or thin pros-and-cons lists that don’t help you actually decide. What follows is a proper side-by-side comparison: what each option includes, what it costs in Auckland in 2026, when each one makes sense, and the hidden factors most homeowners miss.
Superior Renovations
What Counts as a Cosmetic Bathroom Refresh vs a Full Renovation?
Before we get into costs, let’s define what we’re actually comparing. These two options are often talked about as if they’re just different price points for the same thing. They’re not. They’re fundamentally different scopes of work, involving different trades, different timelines, and different levels of disruption to your home.
What a cosmetic refresh includes
A cosmetic refresh keeps the existing layout, plumbing positions, and (critically) the existing waterproofing intact. You’re updating surfaces and fixtures — not rebuilding the room.
Typical scope:
Replacing the vanity, mirror, and tapware
Swapping out the toilet (same position)
New shower screen or enclosure over the existing tray
Repainting walls and ceiling
Replacing lighting fixtures
New accessories — towel rails, hooks, toilet roll holder
Possibly replacing floor vinyl or adding a new bath panel
What a cosmetic refresh does not touch: the tiles behind the shower, the waterproofing membrane, the plumbing pipe runs, the electrical wiring, or the GIB behind the walls. That’s the key distinction.
💡 Quick tip: If your existing tiles are in good condition and firmly bonded, you can paint over them with a specialist tile paint (Dulux Renovation Range or similar) as part of a cosmetic refresh — but this is a short-to-medium-term solution, not a 15-year fix.
What a full bathroom renovation includes
A full renovation strips the bathroom back to the framing — and sometimes beyond it, if there’s damage to the timber structure. Everything comes out: tiles, GIB, waterproofing, fixtures, plumbing, and electrical.
Then it all goes back in, built to current NZ Building Code standards. A full renovation typically involves eight to ten separate trades: demolition, plumbing, electrical, waterproofing, GIB stopping, tiling, painting, joinery installation, glazing, and final fit-off.
At Superior Renovations, our full bathroom renovations include design, demolition, all trades, supply of materials and products, project management, and compliance documentation — from initial concept through to sign-off.
“The moment you pull back the tiles, you’re committed. That’s why we always tell clients — if you’re going to open up the walls, do it properly. Half-measures on waterproofing or plumbing cause more problems down the track than the original issue.” — Cici Zou, Designer (NZ Dip. Interior Design, Certified Designer), Superior Renovations
Auckland Bathroom Renovation Costs: Cosmetic Refresh vs Full Renovation in 2026
Here’s where the numbers sit in Auckland right now. These reflect 2026 pricing, which has seen a 5–8% increase from 2025 driven by labour and material inflation. According to Stats NZ’s Business Price Indexes release, which includes the producers price index, construction input costs have continued to climb year on year.
Scope
Typical Auckland Cost (2026)
Timeline
Trades Involved
DIY cosmetic tidy-up
$3,000–$5,000
1–3 days
Homeowner (paint, accessories, vanity swap)
Professional cosmetic refresh
$9,000–$16,000
1–2 weeks
Plumber, electrician, painter, installer
Mid-range full renovation
$25,000–$35,000
3–4 weeks
8–10 trades, project manager, designer
Full renovation with layout changes
$35,000–$50,000
4–6 weeks
As above + consent process
Luxury / custom full renovation
$45,000–$65,000+
5–8 weeks
As above + specialist trades (e.g. stone, underfloor heating)
The jump from cosmetic refresh to full renovation is mostly driven by three things: waterproofing, tiling labour, and trade coordination. Fixtures and fittings matter, but trades and time dominate the budget in almost every Auckland bathroom renovation we’ve quoted.
Labour accounts for 40–50% of the total on a full renovation in Auckland, with tradesperson rates sitting at $90–$120 per hour in 2026. Materials make up 20–25%, and we always recommend allowing 15–20% contingency — particularly in older homes where what’s behind the tiles is genuinely unknown until demo day.
💡 Quick tip: If you’re comparing quotes, check whether the price includes design, project management, demolition, disposal, and all materials — or just labour. An “all-inclusive” quote from a company like Superior Renovations covers everything. A labour-only quote from an independent tradie will look cheaper upfront but won’t include half the costs.
When a Cosmetic Bathroom Refresh Is the Right Call
Not every bathroom needs to be gutted. We say this openly, even though full renovations are our core business. A cosmetic refresh makes sense when the underlying structure and systems are sound — and the main issue is that the bathroom looks dated.
The bathroom is under 15 years old
If your bathroom was built or last renovated after 2010, there’s a good chance the waterproofing was done to a reasonable standard and the plumbing is still performing well. Bathrooms built in the 2010s in Auckland subdivisions like Hobsonville Point, Flat Bush, or Millwater were typically built to tighter standards than the leaky building era homes from a decade earlier.
In these cases, swapping the vanity, updating tapware, replacing a tired shower screen, and repainting can transform the look without touching any of the infrastructure. You could achieve a significant visual upgrade for $9,000–$16,000.
You’re renovating to sell — not to stay
If you’re planning to list within the next 12–18 months, a $30,000 full bathroom renovation may not return dollar-for-dollar at sale. A clean, freshly painted bathroom with modern fixtures and good lighting photographs well and removes a buyer objection — and you can achieve that for far less than a full reno.
Sound familiar? We’ve had a few clients in Remuera and Epsom who were preparing to sell and came in expecting to spend $40,000. After looking at the condition of their bathrooms, our design team advised them to save the money and do a targeted refresh instead.
The layout already works
If the shower is in the right spot, the vanity doesn’t block the door, and there’s enough storage — then a cosmetic update is all you need to bring the room up to date. Keeping existing plumbing positions is one of the easiest ways to control costs, because the moment pipes move, you’re into more labour, more materials, and potentially consent territory.
Budget is fixed and tight
If your total budget is under $15,000, a cosmetic refresh will give you a better result than trying to stretch a full renovation into that number. We’ve seen homeowners attempt a full gut-and-rebuild on a $15,000 budget using an independent tradie — and end up with cut corners on waterproofing that cost them far more to fix two years later.
When You Need a Full Bathroom Renovation
There are situations where a cosmetic refresh is a Band-Aid on a bullet wound. If any of the following apply to your bathroom, a full renovation isn’t just the better option — it’s the only responsible one.
The waterproofing has failed
This is the big one. Waterproofing failure is the single most common reason a bathroom renovation escalates from “refresh” to “full strip-out” in Auckland.
Per BRANZ guidance on waterproofing tiled showers, leaks are commonly traced back to floor-to-wall and hob-to-wall junctions and around drains — exactly the details a cosmetic refresh never touches. If water has been getting behind the tiles — even slowly, over years — the membrane has failed, the GIB is damp, and the framing behind it may be rotting.
Signs to watch for: musty smell that won’t go away, soft or spongy flooring near the shower, discolouration or bubbling paint on the wall behind the shower, or visible mould in grout lines that keeps returning after cleaning.
You can’t cosmetically refresh your way out of a waterproofing failure. The tiles have to come off, the wet area has to be rebuilt to comply with the Building Code clause E3 internal moisture requirements, and any damaged framing needs to be repaired or replaced before the room goes back together.
“We opened up a bathroom in Titirangi last year where the homeowner just wanted new tiles. Once the old tiles came off, we found the membrane had been leaking for years — the bottom plate was completely rotten. What started as a cosmetic job became a full renovation with structural repairs. That’s why we always recommend a full scope assessment before committing to any approach.” — Dorothy Li, Design Manager, Superior Renovations
Your bathroom is from the 1970s–1990s
Auckland’s housing stock from this era — the brick-and-tile homes in Pakuranga, Manurewa, and Papatoetoe, the weatherboard bungalows in Henderson and Glen Eden — often has bathrooms with galvanised steel plumbing, asbestos-containing materials (in some cases), and waterproofing that predates modern standards.
If your bathroom hasn’t been touched since before 2000, there’s a strong argument for going back to bare framing. Not because the surfaces look bad (some 1980s tiles are practically indestructible) — but because the systems behind them are past their serviceable life.
💡 Quick tip: If your home was built before 1990, ask your renovation company about asbestos testing before any demolition work begins. Disturbing asbestos-containing materials without proper handling is a health hazard and a legal issue under the WorkSafe NZ guidance on asbestos in the home.
The layout doesn’t work
If the shower is too small, the vanity blocks the door swing, there’s no storage, or the bathroom was clearly designed for a different era — no amount of new paint or tapware fixes a fundamental layout problem. Changing the layout means moving plumbing, which means a full renovation.
Common layout issues we fix in Auckland bathrooms: converting a bath-only setup to a separate shower and bath, widening a narrow shower recess to at least 900mm × 900mm, adding a double vanity where a single existed, or reconfiguring a combined toilet-bathroom into a more functional arrangement.
You’re staying long-term and want it done once
If this is your family home and you plan to be here for 10+ years, doing it properly now makes financial sense. A well-built full bathroom renovation should last 15–20 years before needing attention again. A cosmetic refresh might look good for three to five years, but it doesn’t address the ageing infrastructure underneath.
One of our clients in Glendowie put it well during her consultation: “I’d rather spend $32,000 once and not think about it for 15 years than spend $12,000 now and $35,000 in five years when things start failing behind the tiles.”
Building Consent: What Each Option Means for NZ Compliance
This is where a lot of homeowners get tripped up. Consent requirements differ significantly between a cosmetic refresh and a full renovation — and getting it wrong can cause serious problems at resale.
Under Schedule 1 of the Building Act 2004, work that replaces or repositions existing fixtures within the same bathroom — without increasing the number of sanitary fixtures — is generally exempt from building consent, provided an authorised person carries out any plumbing and drainage work.
That means replacing a toilet, swapping a vanity, repainting, and updating tapware in the same positions is fine without consent. You can even reposition fixtures within the existing bathroom space — moving the vanity to the opposite wall, for example — without consent, as long as you’re not adding a new fixture.
Full renovation — consent depends on scope
A full renovation may require consent. It depends on what you’re doing.
Consent is generally required if you are:
Installing a new tiled wet-area shower (because the waterproofing is regulated work)
Adding a bathroom or sanitary fixture where one didn’t exist before
Removing or altering structural walls
Making changes that affect the building envelope
Consent is generally not required if you are:
Replacing fixtures like-for-like in the same positions
Replacing a proprietary shower unit with another proprietary shower unit
Remodelling within the existing bathroom footprint without adding fixtures
The rules around tiled showers are the ones that catch people. Because the waterproofing in a tiled wet-area shower is critical work the council wants to inspect, installing one typically falls outside the Building Act Schedule 1 exemptions and requires consent. Auckland Council assesses this case by case, so confirm your specific scope with them before you start.
💡 Quick tip: If you’re unsure whether your renovation needs consent, check with Auckland Council’s “do I need a consent?” advisory service before you start. Or ask your renovation company — at Superior Renovations, we assess consent requirements during the free consultation and manage all applications on your behalf.
Important note: Even when consent isn’t required, all bathroom work in New Zealand must still comply with the NZ Building Code. That means waterproofing the wet area to the E3 internal moisture standard, compliant electrical work by a registered electrician, and plumbing by an authorised person. A renovation done without consent is not a renovation done without standards.
The Hidden Factor: What’s Behind the Tiles?
Here’s the part of this conversation that most online guides skip entirely. And it’s arguably the most important part.
You cannot fully assess whether your bathroom needs a cosmetic refresh or a full renovation without knowing what’s behind the surfaces. And you won’t know what’s behind the surfaces until either (a) someone qualified inspects it, or (b) the tiles come off.
This is why we always start with a thorough on-site assessment during the free consultation and feasibility process. We look for signs of hidden damage that would change the scope — and therefore the cost — of the project.
Red flags that suggest deeper problems
Some of these are visible without removing anything:
Musty or damp smell — especially persistent after cleaning. This suggests moisture behind walls or under flooring.
Cracked or loose tiles — can indicate substrate movement, which means the GIB or ply behind the tiles has swollen or shifted from moisture exposure.
Discolouration on the wall or ceiling in rooms adjacent to the bathroom — water is getting somewhere it shouldn’t be.
Soft or spongy flooring near the shower base or along the floor-wall junction.
Mould that keeps returning in grout lines or silicone joints, even after re-grouting or re-siliconing.
Water stains on the ceiling of the room directly below a first-floor bathroom.
If any of these are present, a cosmetic refresh won’t fix the problem. It’ll hide it — and the problem will get worse over time.
The “demo day surprise”
We’ve been doing this since 2017. And one thing that still surprises homeowners — though it rarely surprises us anymore — is what turns up once demo starts on an older Auckland bathroom.
Common discoveries during bathroom demolition:
Discovery
How Common
Typical Cost Impact
Failed or non-existent waterproofing membrane
Very common in pre-2000 homes
$2,000–$4,000 for membrane replacement
Rotten bottom plate or framing
Common in villas and older bungalows
$1,500–$5,000+ depending on extent
Galvanised steel plumbing (corroded)
Common in 1960s–1980s homes
$2,000–$5,000 to replace with copper or PEX
Asbestos-containing materials (in flooring, walls, or pipe lagging)
Occasional in pre-1990 homes
$1,000–$3,000+ for safe removal
Inadequate ventilation (no extractor fan or undersized duct)
Very common
$300–$800 for compliant extraction
This is exactly why we recommend a 15–20% contingency budget for any full bathroom renovation in Auckland — especially in older homes like the Grey Lynn villas, Hillsborough bungalows, or Mt Albert weatherboards that make up so much of Auckland’s housing stock.
Side-by-Side: Choosing the Right Scope for Your Bathroom
We’ve put this decision framework together based on the conversations we’ve had at hundreds of consultations. It’s the logic our design team actually uses when advising clients.
Factor
Cosmetic Refresh
Full Renovation
Bathroom age
Under 15 years old
Over 15–20 years old
Waterproofing
Sound — no signs of moisture damage
Failed, suspect, or unknown
Plumbing condition
Modern copper or PEX — working well
Galvanised, corroded, or undersized
Layout
Works for your household
Doesn’t function — needs reconfiguring
How long you’re staying
1–5 years (or renovating to sell)
10+ years — want it done once
Budget
Under $16,000
$25,000–$65,000+
Consent likely?
No (usually exempt)
Depends on scope — tiled showers typically require it
Expected lifespan of result
3–7 years (surfaces only)
15–20 years (full systems rebuild)
“I always ask clients two questions: how old is your bathroom, and how long are you planning to stay? Those two answers tell me more about the right scope than any wish list. If it’s a 1980s bathroom and you’re staying for a decade, the answer is almost always a full renovation.” — Alison Yu, Designer, Superior Renovations
The middle ground — is there one?
Sometimes. We occasionally do what you might call a “targeted renovation” — where we replace the shower and retile the wet area (including new waterproofing), but leave the rest of the bathroom largely untouched. This can work when the shower is the main problem area and the rest of the room is in reasonable condition.
A targeted shower replacement and retile in Auckland typically costs $12,000–$20,000 — less than a full renovation, but more than a cosmetic refresh, because you’re touching the waterproofing and tiling systems.
The risk with this approach is that once you start opening up the shower area, you may find damage that extends beyond it. At that point, you’re making decisions on the fly — which is why a clear scope assessment upfront is worth the time.
ROI and Resale Value: How Each Option Stacks Up
Auckland homeowners often ask which option delivers better return on investment. The answer isn’t as straightforward as “spend more, get more back.”
A well-executed cosmetic refresh delivers the best dollar-for-dollar ROI at resale — because you’re spending less to remove a buyer objection. A tired bathroom puts buyers off. A freshly painted, clean bathroom with modern fixtures doesn’t need to be brand new — it just needs to look like it’s been cared for.
A full renovation adds more absolute value to the property, but the ROI percentage is typically lower because of the higher investment. Where it pays off is in how long that value lasts — a full renovation is an investment in the next 15–20 years of the home, not just the next sale.
💡 Quick tip: If you’re renovating specifically to sell, focus your budget on the main bathroom and ensuite — these have the biggest impact on buyer perception. A guest toilet can get away with a simple cosmetic update. Check current Auckland property values for your suburb on homes.co.nz to gauge whether the renovation spend is proportionate to your property value.
Have you been putting off your bathroom renovation because you’re not sure where to start? You’re not alone. The first step is understanding what your bathroom actually needs — and that starts with a proper on-site assessment.
What Happens Next: How Superior Renovations Approaches This Decision
When you book a free consultation with us, we don’t arrive with a pre-set scope or a minimum spend in mind. Our project consultant visits your home, looks at the bathroom, talks through what you’re hoping to achieve, and — just as importantly — assesses the condition of the existing space.
After the consultation, you’ll receive an action plan that includes a recommended scope of works, concept designs from our design team, and a detailed fixed-price quote. We’ll tell you honestly whether a refresh or a full renovation is the right call for your specific bathroom.
We’ve been renovating Auckland bathrooms since 2017 and have completed over 1,000 home renovations across the city. We work with clients from our showroom in Wairau Valley through to completion — design, supply, build, and project management, all under one roof. You can see real examples of completed projects in our bathroom design gallery and read client stories from homeowners across Auckland.
How much does a cosmetic bathroom refresh cost in Auckland?
A DIY cosmetic tidy-up (paint, new accessories, vanity swap) costs $3,000–$5,000. A professional cosmetic refresh — including new vanity, toilet, tapware, shower screen, painting, and lighting — typically runs $9,000–$16,000 in Auckland in 2026. These figures assume no changes to plumbing positions, waterproofing, or tiling.
How much does a full bathroom renovation cost in Auckland in 2026?
A mid-range full bathroom renovation in Auckland costs $25,000–$35,000 in 2026, covering design, demolition, all trades, materials, and project management. Full renovations with layout changes run $35,000–$50,000. Luxury or custom bathrooms with premium fixtures and features like underfloor heating start from $45,000 and can exceed $65,000.
Do I need building consent for a bathroom renovation in NZ?
Most cosmetic refreshes and like-for-like fixture replacements do not require consent under Schedule 1 of the Building Act 2004. Consent is typically required if you're installing a new tiled wet-area shower, adding a new bathroom, increasing the number of sanitary fixtures, or making structural changes. Auckland Council assesses consent requirements on a case-by-case basis.
Can I do a partial bathroom renovation instead of a full one?
Yes — if the waterproofing is sound, the plumbing is in good condition, and the layout works for your household, a cosmetic refresh can deliver a significant visual upgrade for $9,000–$16,000 without gutting the room. This works best for bathrooms under 15 years old with no signs of moisture damage behind the tiles.
How long does a full bathroom renovation take compared to a refresh?
A professional cosmetic refresh takes one to two weeks. A full bathroom renovation takes three to four weeks from demolition to completion, assuming design is finalised and materials are on site. If consent is required — for layout changes or tiled wet areas — add four to eight weeks for Auckland Council processing before work begins.
How do I know if my bathroom needs a full renovation or just a refresh?
Key indicators that a full renovation is needed: the bathroom is over 15–20 years old, there are signs of moisture damage (musty smell, soft flooring, recurring mould), the plumbing is galvanised steel or corroded, or the layout doesn't work. If the bones are sound and the main issue is appearance, a cosmetic refresh may be all you need.
What is the ROI of a bathroom renovation vs a cosmetic refresh?
A cosmetic refresh typically delivers better dollar-for-dollar ROI at resale because the investment is lower — you're removing a buyer objection for $9,000–$16,000. A full renovation adds more absolute value and lasts 15–20 years, making it better long-term value if you're staying in the home. The right choice depends on whether you're renovating to sell or to stay.
What happens if my renovation company finds damage behind the tiles?
This is common in older Auckland homes. Failed waterproofing, rotten framing, and corroded plumbing are frequently discovered during demolition. A reputable renovation company will document the damage, discuss options with you, and provide a revised quote for the additional work. Budget a 15–20% contingency for unexpected findings, especially in pre-2000 homes.
Is it cheaper to stage a bathroom renovation over time?
Staging can actually cost more overall because trades need to visit multiple times, each requiring setup, access, and coordination. If budget is tight, a well-scoped cosmetic refresh done in one go is usually better value than doing half a full renovation now and finishing later.
Should I get a full bathroom renovation before selling my Auckland home?
Not necessarily. If the bathroom is structurally sound, a professional cosmetic refresh ($9,000–$16,000) can be enough to present well to buyers. A $35,000 full renovation may not return dollar-for-dollar at sale. Ask your renovation company and real estate agent to assess what level of update will deliver the best return for your specific property and suburb.
What trades are involved in a full bathroom renovation?
A full bathroom renovation in Auckland typically involves eight to ten trades: demolition, plumbing, electrical, waterproofing, GIB stopping and plastering, tiling, painting, joinery installation, glazing (shower screen), and final fit-off. A project manager coordinates all trades and manages the build timeline. At Superior Renovations, all trades, design, and project management are included in our fixed-price quote.
Does Superior Renovations do partial bathroom renovations?
Superior Renovations specialises in full bathroom renovations — complete demolition to frame, rebuild, design, supply, and project management. We don't undertake minor cosmetic updates or maintenance work. Our projects typically start from $25,000 and include all trades, materials, compliance, and a dedicated project manager. For a proper assessment of what your bathroom needs, book a free in-home consultation.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
Quick answer: Good bathroom tapware NZ homeowners should look for is solid brass, lead-free under New Zealand’s low-lead plumbing rules (in force from 2 May 2026), WELS-rated for Auckland mains pressure, and finished in PVD-coated chrome, matte black, brushed brass, or brushed nickel. Budget $600–$2,500 for tapware across a bathroom, depending on brand and finish.
Most bathroom tapware guides online are written by the companies selling the tapware. They’ll tell you all about their own product line and stay politely quiet about what fails after three years in an Auckland bathroom.
We’re a renovation company, not a tapware brand. We’ve installed tapware in over a thousand Auckland bathroom renovations — in Parnell villas, West Harbour new builds, Hillsborough bungalows, and Titirangi homes that back onto the bush. We’ve seen which brands hold up, which finishes wear, and what happens when someone specs a $90 budget mixer because it looked fine in the showroom.
This is what we actually tell clients when they ask “so which taps do we go with?” at the design studio in Wairau Valley — grounded in Auckland’s specific water conditions, our preferred brands, and honest cost figures for the 2026 renovation market.
Designer Bathroom By Superior Renovations
What Makes Auckland Bathroom Tapware Different
Before you pick a brand, you need to understand what the water coming out of it will actually do to it. Every tapware brand sold in New Zealand is tested to survive water, but Auckland’s water has a specific profile that wrecks some finishes faster than others — and almost nobody writes about it.
Auckland water is mostly soft — and that’s not the win you’d think
Auckland’s water is mostly soft. According to Watercare, the city’s drinking water comes from dams in the Waitākere and Hūnua Ranges, groundwater, and the Waikato River. Its water hardness data places the supply in the soft to moderately hard range, well within the national drinking-water guidelines. Surface water from the ranges is the softest; some groundwater-supplied pockets sit at the harder end. The metro supply most Auckland homes draw on is soft.
Most tapware guides treat soft water as the good news story. It’s more complicated than that.
Soft water doesn’t leave the chalky calcium scale you’d get in Adelaide or London, but it has a quietly damaging property: low-mineral water is mildly corrosive. Without a protective layer of mineral buildup, soft water slowly strips internal metal surfaces. Cheap zinc-alloy tapware corrodes from the inside faster than the same product would in a hard-water city. Solid brass fittings hold up — but only if the brass is the right alloy.
Silica is the other issue. Watercare’s water hardness page notes that scale on tapware and smooth surfaces can be silica rather than calcium — the whitish, hazy marks you sometimes see around a tap base, left behind when soft water evaporates. It isn’t easily descaled with vinegar the way calcium is. It just sits there.
Chlorine, PVD coatings, and the coastal question
All Auckland metro water is chlorinated as part of the disinfection process. Residual chlorine is low by international standards, but it still matters for tapware finishes. Cheap painted or electroplated finishes — the ones you sometimes see on budget matte black tapware — react with chlorine over time. The finish goes patchy. Sometimes after eighteen months. Sometimes after three years. Never after ten.
PVD (Physical Vapour Deposition) coatings are the durable answer. They’re molecularly bonded to the brass underneath, which means they resist chlorine, scratches, and the normal wear that kills cheaper finishes. Most premium brands now use PVD as standard on their coloured finishes. Budget brands still use painted or electroplated coatings and hope the customer moves house before the finish fails.
Then there’s salt air. If you’re renovating a bathroom in St Heliers, Mission Bay, Devonport, Herne Bay, or anywhere else within 500m of the coast, your tapware is dealing with airborne salt every day. Salt accelerates corrosion on any brass fitting, no matter how good. For coastal renovations we specify either 316-grade stainless steel or solid brass with a PVD coating — and we flag it to the client early because the brand choice narrows quickly.
💡 Quick tip: Coastal Auckland homes (Herne Bay, Mission Bay, St Heliers, Devonport, Takapuna) should factor salt air into tapware specification. The finish you see in a Newmarket showroom won’t look the same after two winters on the harbour edge. Ask your designer for PVD-coated options.
“We had a St Heliers bathroom last year where the client had picked budget matte black tapware before engaging us. Eighteen months in, the finish on the basin mixer had gone mottled. Salt air does that. We now have the salt-air conversation on day one with any coastal project — and spec PVD coatings from the start. It’s cheaper to pick the right tap once than to replace a full set at year three.” — Cici Zou, Designer (NZ Dip. Interior Design), Superior Renovations
Mixer vs Three-Piece Tapware: The Configuration Decisions That Drive Cost
The tapware type you pick affects three things: how the bathroom looks, how it’s plumbed, and how much of your renovation budget it consumes. Most clients focus on the first. We focus on all three.
Basin mixer vs three-piece tapware
A basin mixer is a single-lever tap that combines hot and cold into one spout. A three-piece set is separate hot and cold handles with a central spout. Mixers dominate contemporary Auckland bathrooms because they’re easier to use one-handed and lend themselves to minimalist design.
Three-piece taps look right in heritage villas and bungalows — the cross-handled or lever variants read as correct in a 1920s Grey Lynn villa where a sleek basin mixer would feel imported from a different era. If you’re renovating a character home in Ponsonby or Mt Eden, three-piece tapware from a heritage-styled brand often holds more property value than a modern mixer.
Wall-mounted vs bench-mounted
Bench-mounted tapware sits on the vanity or basin surface and runs into plumbing below. Wall-mounted tapware comes out of the wall, with all plumbing concealed behind the tiles.
Wall-mounted looks cleaner. It frees up the basin area, eliminates the water pooling around the base that kills a bench-mounted finish, and generally makes a small bathroom feel less cluttered. The catch: the plumbing has to be roughed in behind the waterproofing before tiling starts. If you want to replace a wall-mounted mixer in five years, you’re opening up tiled walls.
Bench-mounted tapware is the safer choice for renovations on a tight budget or where you might want to swap fixtures later. Wall-mounted is the premium choice when you’re committing to the design for a decade-plus.
Basin spout reach and height
One decision a lot of guides skip: the geometry of the tap matters for the basin you’re pairing it with. A tall vessel basin (the bowl-shape that sits on top of the vanity) needs a taller spout — typically 150mm+ from base to outlet — or the water hits the rim and splashes. A low undermount basin can take a shorter spout.
We’ve seen new bathrooms where a beautiful vessel basin was paired with a standard basin mixer and every handwash ends in splashed water across the vanity top. It’s the sort of thing you only notice after install.
💡 Quick tip: Match spout height to basin type before you lock in the order. A 142mm-tall basin mixer works for most standard undermount basins. For a tall vessel basin, look at 165mm+ or a wall-mounted spout so the water clears the rim.
The Brands We Install in Auckland Bathrooms
Every renovation company has a short list of brands they trust. Ours has been shaped by a thousand-plus installations, real warranty experience, and what our plumbers actually want to work with. We’re not paid to recommend any of these brands — they just keep performing.
Methven
Methven is New Zealand’s best-known tapware brand, started by George Methven in Dunedin in 1886 as a brass and iron foundry. They make tapware and shower systems with a strong contemporary design language, and their premium ranges (Aurajet, Turoa, Waipori) are standard specifications across a lot of our mid-range and premium bathroom renovations. The Aurajet showerheads have become almost default in Auckland new builds for good reason — the spray pattern is noticeably better than comparable imports. Methven offers a long warranty on most tapware, which is generous even by premium standards.
Felton
Felton is another New Zealand brand, based in Auckland. They sit at the mid-range price point with solid build quality and a broader style range than most imports — their Reflect and Axiss ranges get specified a lot on family bathrooms and ensuites where the client wants good tapware without the premium price tag. Felton’s national service network makes warranty claims straightforward, which matters more than clients realise.
Plumbline
Plumbline is a New Zealand-owned bathroomware company with a design-led product range and strong relationships with European manufacturers. Their Buddy, Progetto, and Lusso ranges show up often in architect-led Auckland renovations. Plumbline’s finishes — particularly their brushed finishes — are among the most durable we’ve seen hold up in Auckland bathrooms over five-plus years.
Paini
Paini is an Italian brand, made in Pogno since 1954, distributed in New Zealand through Robertson Bathware and plumbing merchants. Their tapware has the build quality Italian manufacturers are known for — solid brass bodies, long-life ceramic cartridges, and a design language that suits modern Auckland bathrooms. We specify Paini when a client wants European design without paying Astra Walker pricing.
Astra Walker
Astra Walker is a premium Australian brand, manufactured in Sydney. Their pricing is higher than most — a basin mixer starts around $750–$1,200 — but the tapware is essentially built forever. Solid brass, lead-free, with a long finish warranty on their PVD-coated ranges. We specify Astra Walker for high-end bathrooms in Parnell, Remuera, Herne Bay, and the premium ensuites where the client intends to live in the house for 15+ years.
Burlington
Burlington is a UK heritage brand specialising in traditional English bathroom tapware — cross handles, pillar taps, exposed thermostatic valves, period-correct detailing. If the client is renovating a bathroom in a 1910 Mt Eden villa or an Edwardian Ponsonby home and wants the tapware to look period-correct, Burlington is generally where we end up. It’s expensive and the lead time can be 6–8 weeks, so we bring it into the design conversation early.
St Michels
St Michels is a New Zealand distributor carrying a range of premium European-styled bathroomware, including tapware, vanities, and bathware. They frequent our premium renovations in Parnell and Remuera, typically on the fixtures and fittings side. Their tapware selection skews contemporary with strong matte black and brushed brass options.
💡 Quick tip: When budget tightens, tapware is often the first place clients try to save money. Don’t. Tapware is the fixture you physically touch every day — the difference between a $120 mixer and a $450 one is obvious within a month. Save on the things you don’t touch: tile backing, vanity MDF core, framing timber. Not the taps.
“When a client asks me where to splurge in the bathroom, I give them two answers — tapware and tiling. Those are the two things your hand and your eye land on every single day. A cheap tap reveals itself immediately; a cheap tile reveals itself over time. Neither one ages well.” — Eunice Qin, Designer, Superior Renovations
Finishes: What Holds Up in an Auckland Bathroom
Finish is where most tapware decisions go wrong. The showroom look isn’t the real test — the real test is how it looks after three Auckland winters of damp, daily use, and the occasional wipe with whatever cleaning product was on special at the supermarket.
Chrome
Chrome is the baseline. It’s the most forgiving finish in a bathroom — hides water marks and fingerprints better than matte black, resists chlorine and salt air better than cheap coloured finishes, and still looks crisp at year ten. For family bathrooms where the priority is zero maintenance and long life, chrome is usually the right answer. It’s also the cheapest finish across every brand we use, which frees budget for other parts of the renovation.
Matte black is the single most popular finish in Auckland new bathrooms right now. Our 2026 project log shows it in around 40% of our premium bathroom renovations — and it’s still trending up. The caveat: matte black shows water marks and fingerprints more than any other finish. In a family bathroom used hard, it wants a daily wipe to look its best.
The bigger caveat is finish quality. Budget matte black tapware — typically under $200 for a basin mixer — is usually painted or electroplated, not PVD-coated. These finishes start breaking down within 18–36 months in an Auckland bathroom. PVD-coated matte black from a premium brand (Plumbline, Astra Walker, Methven’s premium ranges) holds up for 10+ years without noticeable wear. The price gap between a budget and a premium matte black basin mixer is often $300. The performance gap is an order of magnitude.
Superior Renovations
Brushed brass
Brushed brass is the second-fastest-growing finish we specify. It’s warmer than chrome, softer than matte black, and hides water marks better than either because the brushed texture breaks up reflection. It pairs well with the timber vanities and neutral tile palettes that dominate contemporary Auckland bathrooms.
Brushed brass in a premium PVD coating holds up just as well as premium matte black. The aesthetic risk is trend — brass sits in a more specific design moment than chrome, so if you’re renovating to sell in two years, chrome is the safer resale finish.
Brushed nickel
Brushed nickel is quietly one of the most durable and versatile finishes available. Softer and warmer than chrome, cooler than brass, and fingerprint-resistant in a way matte black will never be. For a family bathroom where both durability and design matter, brushed nickel is a strong pick and probably under-specified in Auckland right now.
Brushed Nickel Meir
Gunmetal, polished nickel, rose gold
These are the specialty finishes. All three can look striking when paired with the right tiling and vanity, but all three are also trend-sensitive. Gunmetal reads contemporary but specific; polished nickel reads traditional; rose gold reads a very particular mid-2010s moment. If you’re renovating for long-term own-use, specify what you love. If you’re renovating for resale, stay closer to chrome, matte black, or brushed brass.
Mizu Silk Basin Mixer Brushed Gunmetal from Reece
💡 Quick tip: If you love matte black but share a bathroom with kids, consider brushed brass or brushed gunmetal instead. Same design intent, half the fingerprint visibility, much lower maintenance.
Mains Pressure, WELS Ratings, and Lead-Free Compliance
This is the section most buying guides skip. It’s also the section where specifying the wrong tapware creates the most expensive problems.
Auckland mains pressure — it’s not uniform
Most Auckland homes are on mains pressure water. Watercare commits to delivering a minimum of 200 kPa at the property boundary, with a flow rate of at least 25 litres per minute on a standard 15mm residential connection. Inside the house, a mains-pressure hot water system typically works at around 350–700 kPa, regulated by a pressure-reducing valve. Some older homes — particularly character homes with original cylinders — still run on low-pressure or unequal-pressure systems.
Specify mains-pressure tapware on a low-pressure system and you’ll get a weak dribble out of your new $600 mixer. Specify low-pressure tapware on a mains system and you risk flooding and failed seals. This is not the sort of mistake you want to find after the tiles are on.
Before picking tapware, your plumber should confirm your water pressure. If you’re doing a full bathroom renovation with us, our project manager handles this as part of the pre-quote process. Most premium tapware ranges come in both mains and universal (multi-pressure) versions — the universal ones work on either pressure but are slightly more expensive.
WELS — what the stars actually mean
Every tap and showerhead sold in New Zealand carries a WELS (Water Efficiency Labelling Scheme) star rating, from 0 to 6. The label is mandatory at the point of sale under the Consumer Information Standards (Water Efficiency) Regulations, enforced by the Commerce Commission. More stars = lower flow rate = less water used. Bathroom basin mixers are typically rated 4–6 stars.
For bathroom taps, a 5-star WELS rating is a good balance of water efficiency and usable flow. 6-star taps work but can feel underwhelming at the basin — great for environmental impact, mildly frustrating for handwashing. Most Auckland premium homes end up with 4–5 star tapware at the basin. Worth knowing: WELS showerheads currently top out at 3 stars in New Zealand (there’s no agreed low-flow performance test above that yet), and the scheme doesn’t cover shower mixers or bath mixers at all — so you won’t see a star rating on those.
Lead-free tapware — the rule that changed in 2026
From 2 May 2026, New Zealand’s Building Code requires any copper-alloy product in contact with drinking water — pipes, fittings, valves, taps, mixers and water heaters — to be lead-free, meaning a maximum weighted-average lead content of 0.25% across wetted surfaces. According to MBIE’s Building Performance, this sits in Acceptable Solution G12/AS1 (Amendment 14) and is verified to the NSF/ANSI/CAN 372 test standard — not, as is sometimes claimed, AS/NZS 3718, which is the separate tapware performance standard. The same update also requires tapware to resist dezincification — the slow corrosion that eats brass from the inside, which is exactly the failure soft Auckland water encourages.
The requirement is tied to the building consent process: it applies to new builds, renovations, and any replacement plumbing work going forward. Existing plumbing already in your home doesn’t have to be ripped out. But the moment a plumber installs new tapware on your drinking-water lines, the parts going in must be lead-free.
Legitimate brands sold in New Zealand (Methven, Felton, Plumbline, Paini, Astra Walker, Burlington, St Michels) supply compliant tapware. Imported tapware from non-certified overseas sources may not — and a registered plumber can’t legally install non-compliant product. Look for a WaterMark Lead Free mark or equivalent lead-free certification.
Important note: If you’re tempted by imported tapware bought online from an overseas retailer, check it’s certified lead-free to the New Zealand requirement before buying. A registered plumber can’t legally install non-compliant tapware on your drinking-water lines. We’ve had clients arrive with beautiful Italian taps that we couldn’t install — and the return shipping cost more than the taps.
What Bathroom Tapware Actually Costs in an Auckland Renovation
This is the number nobody publishes honestly. Here’s what we see across live 2026 Auckland bathroom renovations.
Tapware as a share of total bathroom renovation cost
A mid-range Auckland bathroom renovation runs about $25,000–$35,000, with luxury and custom bathrooms starting from $45,000 (see our full Auckland bathroom renovation cost guide for the line-by-line detail). Tapware across the full bathroom typically accounts for 4–8% of the total renovation cost. That’s $1,000–$2,800 for a mid-range bathroom and $2,000–$5,000 for a premium or custom bathroom.
Skimping on tapware to save $600 on a $35,000 renovation is almost always the wrong call. You’ll live with the tapware for 10+ years and touch it multiple times a day. The saving is 1.7% of project cost — the regret is daily.
Price ranges we see across brands
Item
Budget range
Mid-range
Premium
Basin mixer (chrome)
$140–$280
$340–$650
$700–$1,400
Basin mixer (matte black PVD)
$180–$340 (not recommended)
$420–$750
$800–$1,600
Basin mixer (brushed brass PVD)
N/A at this tier
$520–$850
$900–$1,800
Shower mixer
$180–$320
$420–$780
$850–$1,600
Rain shower head
$120–$260
$320–$620
$700–$1,400
Bath mixer and spout
$280–$480
$560–$1,100
$1,200–$2,400
Full bathroom tapware set
$900–$1,600
$2,000–$3,800
$4,200–$8,500
These figures are for tapware supply only — installation is separate and runs around $180–$350 per fixture depending on whether it’s a bench-mount retrofit or wall-mount with new in-wall rough-in. For an accurate estimate tied to your specific bathroom, use our bathroom renovation cost calculator — it factors in tapware tier, tile allowance, vanity specification, and Auckland labour rates.
💡 Quick tip: Budget the full tapware set in one go — basin mixer, shower mixer, rain head, bath mixer and spout, plus accessories. Buying individual fixtures in tranches usually ends with mismatched finishes because brands subtly change their PVD tones between production runs. One order, one finish, one match.
After a thousand bathrooms, our honest priority list for tapware spending:
Spend most on the basin mixer and shower mixer. These are the two fixtures you physically interact with every day. A cheap basin mixer feels cheap every single morning. A premium one disappears into routine — which is the goal.
Spend mid-range on bath mixer and spout. You use these less often. Mid-range premium brands (Felton, mid-tier Methven, mid-tier Paini) deliver 85% of the feel for 60% of the cost.
Spend less on accessories — towel rails, toilet roll holders, robe hooks. These get used less, touched lightly, and are the easy place to save a few hundred dollars. Pick matching finishes to your mixers and you won’t notice a tier drop.
Making the Decision — Where to See Tapware in Auckland
Tapware specification is one of those decisions that gets better once you physically touch the product. Showroom photos flatter every finish. In person, matte black reveals its fingerprint problem, brushed brass shows its warmth, and chrome’s durability becomes visible.
Our Auckland design studio at 16B Link Drive, Wairau Valley has a working display of bathroom tapware across all the brands we install — clients can run the water, feel the weight, and see the finish under real lighting. For premium ranges (Astra Walker, Burlington, higher-end Plumbline) we take clients to Reece in Albany or Newmarket. Mid-range specifications typically work from our in-house samples and tile suppliers like The Tile Depot.
The tapware conversation usually happens in the first or second design meeting, alongside the tile, vanity, and lighting decisions. Because tapware has 2–8 week lead times depending on brand and finish, pinning it down early keeps the whole renovation timeline honest.
“The clients who are happiest with their bathroom tapware 12 months later are the ones who made the decision standing in front of the product with the water running. Not the ones who picked it off Instagram. Same brand, different experience. Showroom beats screen every time.” — Cici Zou, Designer (NZ Dip. Interior Design), Superior Renovations
Next Steps for Your Auckland Bathroom Renovation
Bathroom tapware decisions sit inside a much bigger conversation about your renovation — design, layout, compliance, budget, and timeline. The tapware chapter is easier when the bigger chapters are in order.
If you’re planning a bathroom renovation in Auckland and want straight answers on specification, budget, and brand choice, start with a free in-home consultation. We’ll walk through the whole brief, including tapware, in one conversation. No hard sell, no obligation — just the sort of grounded advice you’d get if you had a renovator in the family.
How much should I budget for bathroom tapware in an Auckland renovation?
Plan for 4–8% of your total bathroom renovation budget to go on tapware. For a mid-range Auckland bathroom renovation at $25,000–$35,000, that's $1,000–$2,800 for the full tapware set (basin mixer, shower mixer, rain head, bath mixer and spout). Premium and custom bathroom renovations from $45,000 typically spend $2,000–$5,000 on tapware. Scrimping here is false economy — tapware is the fixture you touch every day for 10+ years.
Which tapware brand is best for Auckland's water conditions?
Methven (New Zealand-founded), Felton (Auckland-based), and Plumbline (NZ-owned) are our most-specified brands for Auckland bathrooms because they're built for New Zealand plumbing codes and hold up well in Auckland's soft, chlorinated water. For premium bathrooms, Astra Walker (Australian) and Burlington (UK heritage) are strong options. All legitimate brands sold in New Zealand supply lead-free tapware, which the Building Code has required on drinking-water lines since 2 May 2026.
Does Auckland's water damage bathroom tapware?
Auckland's water is mostly soft, so you don't get the heavy calcium scale seen in harder-water cities. But Watercare notes silica scale can still form on tapware when soft water evaporates, and Auckland's chlorine-disinfected water slowly attacks cheap electroplated finishes. The biggest risk is budget tapware with painted or non-PVD coloured finishes — these can start breaking down within 18–36 months. Premium PVD-coated solid brass tapware typically lasts 10+ years without noticeable finish wear.
Is matte black bathroom tapware worth it?
Matte black is the single most specified finish in our 2026 Auckland bathroom renovations, and it looks outstanding when it's the right quality. The catch: budget matte black tapware under $200 is usually painted or electroplated, and the finish degrades within 2–3 years. PVD-coated matte black from premium brands (Plumbline, Methven premium ranges, Astra Walker) holds up 10+ years. Matte black also shows water marks and fingerprints more than any other finish — for busy family bathrooms, consider brushed brass or brushed nickel as a lower-maintenance alternative.
Do I need lead-free tapware in NZ?
Yes, for any new tapware installed on drinking-water lines. From 2 May 2026, New Zealand's Building Code (Acceptable Solution G12/AS1, Amendment 14) requires copper-alloy products in contact with drinking water to be lead-free — a maximum 0.25% weighted-average lead content, verified to the NSF/ANSI/CAN 372 standard. The rule applies to new builds, renovations, and replacement work; existing plumbing doesn't need replacing. Legitimate NZ-distributed brands (Methven, Felton, Plumbline, Paini, Astra Walker, Burlington, St Michels) all supply compliant product, and a registered plumber can't legally install non-compliant tapware.
What's the difference between a basin mixer and a three-piece tap set?
A basin mixer is a single-lever tap where one handle controls both water flow and temperature. A three-piece set has separate hot and cold handles with a spout between them. Mixers dominate contemporary Auckland bathrooms because they're easier to use and suit minimalist design. Three-piece sets look right in character homes — villas, bungalows, Edwardian houses — where heritage styling is part of the property's value. For a family bathroom in a 2000s Hobsonville new build, a mixer is usually the right call. For a 1920s villa in Grey Lynn, a three-piece set often serves better.
How long does quality bathroom tapware last?
Premium bathroom tapware from brands like Methven, Plumbline, Astra Walker, and Burlington typically lasts 15+ years with no finish degradation, and longer again with a cartridge replacement. Mid-range tapware from Felton or Paini runs 10–15 years. Budget tapware under $200 per mixer often starts showing finish problems within 2–4 years in Auckland bathrooms, and cartridges usually need replacement by year 5–7. Longevity is heavily tied to finish quality (PVD vs electroplated) and brass alloy grade.
Can bathroom tapware be installed by the homeowner?
Sanitary plumbing is restricted work under the Plumbers, Gasfitters, and Drainlayers Act 2006, and most of it must be done by a licensed plumber. There is a narrow householder exemption for lower-risk jobs like replacing or repairing an existing tap — but a bathroom renovation's new pipework, fixture installation and wall-mounted rough-ins are restricted work that an authorised plumber has to carry out. Using an unlicensed person for restricted work can void your insurance and hold up your renovation's Code Compliance Certificate. In a full renovation, your plumber also sequences the wall-mounted rough-in with the tiler and waterproofer before tiling.
Why does my bathroom tapware have white marks on it?
The white marks on Auckland bathroom tapware are usually silica scale, not calcium scale. Watercare confirms silica can build up on tapware and smooth surfaces when soft water evaporates. Unlike calcium scale, silica doesn't respond well to vinegar — Watercare recommends drying surfaces before the water evaporates, or cleaning with a mildly abrasive glass cleaner. A daily microfibre wipe-down on matte black or brushed finishes keeps them looking new significantly longer than leaving water to air-dry.
How do I know if my Auckland home has mains-pressure or low-pressure water?
Most Auckland homes built after the 1990s are on mains pressure. Watercare delivers a minimum of 200 kPa at the property boundary, and mains-pressure systems inside the home typically work at around 350–700 kPa. Older character homes with original hot water cylinders often run on low or unequal pressure. Check your hot water cylinder — a mains-pressure cylinder is usually labelled as such and has a pressure-reducing valve and temperature control valve nearby. In a renovation, your plumber confirms pressure as part of the pre-quote process. Specifying the wrong tapware (mains on low pressure, or vice versa) causes performance problems and sometimes warranty-voiding failures, so it's worth getting right upfront.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
Quick answer: Structural changes — removing load-bearing walls, specifying beams, altering foundations — are where most Auckland renovation budgets blow up. Get the engineering wrong and the costs compound fast. This is how we manage it at Superior Renovations.
Pull the GIB off a wall in a Grey Lynn villa and you never quite know what you’ll find.
That’s not marketing copy. It’s what we tell clients in the first consultation at our Wairau Valley showroom. We’ve been doing full-home renovations across Auckland since 2017, and if you ask any of our project managers where a build is most likely to surprise everyone — the homeowner, the designer, the builder, the engineer — it’s always the same answer.
Structural.
Not the kitchen layout. Not the bathroom tiling. Not the paint schedule. It’s the moment someone walks into what they thought was a cosmetic refresh, points at a wall, and says “can we just take this out?”
Maybe. Probably. But the honest answer is: it depends on what’s above it, what’s beside it, what’s underneath it, and what the engineer’s numbers say once we’ve measured the loads. And the cost of getting that calculation wrong isn’t a few thousand dollars — it’s the whole programme.
This is a technical piece. Written for Auckland homeowners planning a full-house renovation where walls are coming out, beams are going in, and there’s a real chance the foundation is going to have something to say about it. We’ll walk through load paths, beam specification, foundation implications, and the process we run to keep structural risk bounded before you’ve paid for a single sheet of GIB.
If you’ve been staring at your villa thinking “surely we can open this up” — read on.
Why Structural Work Is Where Most Auckland Renovations Get Expensive
Ask ten Auckland builders where a renovation is most likely to surprise you. You’ll get roughly the same answer.
Cabinetry problems get solved with a phone call to the joinery shop. Tiling issues get fixed with a different batch. Paint gets repainted.
Structural problems rewrite the programme.
There are three reasons this is true across every full-home renovation we’ve done — from 1920s villas in Mt Eden to leaky-era townhouses in Albany to 1970s brick-and-tile in Manurewa. Understanding all three before you sign a building contract is the difference between a reno that runs and one that spirals.
The discovery problem — you can’t plan against what you can’t see
No set of plans drawn from outside a wall tells you what’s inside the wall.
We’ve opened walls in Titirangi that were supposed to be framed with 90×45 pine and found undersized 75×50 studs on 600mm centres with no dwangs where there should’ve been dwangs. We’ve found rotted bottom plates in mid-2000s Hobsonville homes where the original building paper failed. We’ve found notched studs where someone cut a 40mm slot to run a bathroom waste line through in 1986 — quietly compromising the load path of a whole wall for forty years.
None of that shows up in a pre-build quote.
It shows up at day five of demolition. That’s when the engineer’s phone rings at 7:30am.
💡 Quick tip: Ask any renovation company quoting you how they handle structural discovery after demo. If they can’t give you a clear answer — including a contingency line in the quote — the risk is sitting on your side of the contract, not theirs.
The compounding cost problem — one structural change pulls twelve others
Here’s what most homeowners don’t see until they’re mid-build.
A single structural decision rarely stays single. Remove one load-bearing wall in a 1960s Remuera bungalow and you will likely need: a new beam designed by a chartered engineer, a Producer Statement (PS1) for the design, temporary propping during the swap, an upgrade to the supporting studs or columns at either end of the beam, potentially a new pad footing underneath those supports, an amendment to the Building Consent if the scope shifted from what was lodged, and an inspection from Council before linings go back on.
Each of those line items is manageable in isolation. The risk is the interaction — a beam that turned out 60mm deeper than planned takes out the ceiling plan, which moves the lighting, which means the electrician re-runs, which delays the GIB stopper, which pushes the tiler out, which means the bathroom supplier’s delivery window doesn’t line up anymore.
That’s how a $4,000 structural variation becomes a $28,000 programme event.
The consent exposure problem — what Council cares about is non-negotiable
Most structural work in Auckland sits squarely inside Restricted Building Work under the Building Act. That means you need a Licensed Building Practitioner (LBP) signing it off, a Building Consent from Auckland Council, engineer-specified structural elements, and inspections at defined hold points — often including a pre-line inspection before GIB goes back up.
Skip any of those steps and the consequences aren’t theoretical. A Code of Compliance Certificate (CCC) that won’t issue. A LIM report at sale time that flags unconsented work. An insurance claim that gets declined because the work didn’t meet the Building Code.
We’ve seen homeowners inherit all three after buying a house where the previous owner “just took a wall out.” It takes $30,000–$60,000 of retrospective engineering, strengthening, and consent work to unwind — and that’s if the structure was actually adequate in the first place. MBIE’s Restricted Building Work guidance spells out where the line is. It’s not subtle.
“The three weeks nobody talks about are the three weeks after demo, when we find out what the house is actually made of. No set of drawings tells you that. Every full-home renovation we’ve done in Auckland has revealed something the original build got wrong — and it’s nearly always structural. The builds that run well aren’t the ones where nothing goes wrong. They’re the ones where the process assumes something will, and the engineer is on speed dial.” — Dorothy Li, Design Manager, Superior Renovations
Identifying Load-Bearing Walls (And Why Getting This Wrong Costs More Than You Think)
There’s a reason the question “is this wall load-bearing?” gets asked in every first consultation. It’s the single structural question homeowners are most confident about — and most often wrong about.
Not their fault. The answer is rarely obvious from inside the room.
How residential load paths actually work in NZ
Most Kiwi homes built from the late 1970s onward are framed to NZS 3604 — Timber-framed buildings. It’s referenced, with modifications, in Acceptable Solution B1/AS1 of the Building Code for standard residential construction, and defines stud sizes, beam spans, bracing requirements, and connection details for houses of ordinary size and shape.
In a NZS 3604 house, loads travel downward in a predictable chain. Roof weight lands on rafters, which transfer to the top plate, which transfers down through studs in specific walls, which deliver load to the bottom plate, which transfers to the foundation. The walls carrying that vertical load are load-bearing. Walls that only divide space are not.
So far, so textbook.
But there are three places this gets messy in real Auckland housing stock:
Villas and bungalows (pre-1940): Built before NZS 3604 existed. Often framed with whatever timber was around — rimu, kauri, matai — in non-standard sizes on non-standard centres. Original rooflines are often more complicated than they look, with hidden valleys and concealed beams that change which walls carry load. We’ve had villa jobs in Ponsonby where what looked like an internal partition was actually carrying the entire hip roof rafter via a timber beam concealed above the ceiling.
Leaky-building era homes (mid-1990s to mid-2000s): Framed to NZS 3604 correctly in most cases, but with a high rate of framing decay around window and door openings where the weathertightness system failed. Walls that are technically load-bearing may have studs that no longer are. The BRANZ guidance on leaky-home remediation is essential reading before any structural work on a home of this era.
Split-level and complex layouts: Any home with a mezzanine, a split floor level, or a structural beam running mid-span will have load paths that don’t follow the simple “exterior walls carry most of it” rule. This is where homeowner assumptions break down hardest.
Load-bearing vs bracing — a distinction that matters
Here’s a technical point that catches people out. A wall can be non-load-bearing in the vertical sense and still be critical for bracing — the lateral resistance that keeps the house standing up in wind and earthquake.
NZS 3604 calculates the bracing demand for every house based on wind zone and earthquake zone, then requires a certain number of Bracing Units (BUs) distributed around each floor level. Auckland’s wind zones range from Medium to Extra High under the NZS 3604 map, depending on the site’s exposure. A house with perfect vertical load paths can still fail its bracing demand if the wrong internal wall comes out.
Take out a wall without accounting for bracing and the house is technically non-compliant — even if the roof isn’t about to fall in. Council inspectors check bracing schedules at the pre-line stage. An engineer’s bracing report is often part of the consent package.
Important note: “The wall is only 2.4 metres long and made of GIB — it can’t be structural” is the assumption that causes the most expensive mistakes we see. Short walls can carry significant point loads. Non-bearing walls can be bracing walls. Always get an engineer’s eye before demo, not after.
Where homeowner and tradie assessments go wrong
We’ve been on the tools long enough to know that a quick visual assessment — even from an experienced builder — is not the same as an engineered assessment. There are four checks people commonly rely on that don’t tell you what they think they tell you:
1. “It’s parallel to the joists, so it’s not structural.” True in simple single-storey homes. Not true in split-level homes, not reliable in villas, and not necessarily true in two-storey homes where the first-floor wall may be carrying a beam that’s perpendicular to the visible joists above.
2. “There’s no wall above it.” This only confirms the wall isn’t carrying a direct stacked load. It says nothing about bracing. And it doesn’t account for concealed beams transferring load laterally across the ceiling space.
3. “The plans show it as a partition.” Original plans in Auckland are often either missing, partially revised during construction, or don’t reflect what was actually built. We regularly find walls built during construction that aren’t on any drawing.
4. “My builder said it was fine.” Builders are skilled. They’re not chartered engineers. For anything in the Restricted Building Work category, the signature you want on the decision is a CPEng structural engineer’s — not a verbal assurance from anyone, however experienced.
This is where our feasibility report process earns its keep. An engineer walks the house before design work starts. We know what’s possible and what’s expensive before you’re attached to a layout.
Beam Sizing and Specification — The Part That’s Easy to Get Wrong on Paper
Take out a load-bearing wall and something has to replace the path that load used to travel. Ninety percent of the time, that’s a beam.
Specifying the beam is where renovation projects meet real engineering. It’s also where the paper answer and the build answer can diverge badly if nobody is paying attention.
LVL vs steel — when each is the right call
For residential renovations in Auckland, the two common beam options are Laminated Veneer Lumber (LVL) and structural steel — typically a Parallel Flange Channel (PFC), a Universal Beam (UB), or a Universal Column (UC) used on its side.
LVL beams — manufactured by brands like Nelson Pine and Carter Holt Harvey — are the default for most residential openings. They’re cost-effective, install with standard carpentry trades and tools, and come in standard sections like 2/240×63 LVL11 or 2/360×63 for larger spans. They’re what we use on the majority of single-storey wall removals.
Steel beams become the right answer when:
The span is too long for a cost-effective LVL (typically above about 5–6 metres, though this depends on load)
The beam depth has to be minimised to preserve ceiling height
There’s a significant point load — for example, a second-storey wall stacking onto the new opening
Fire resistance requirements push towards a non-combustible member
A PFC 250 or a 310 UB can carry loads in depths that LVL simply can’t match. The trade-off is cost, weight, trade coordination (a steel fabricator and an installer with lifting gear, often a HIAB truck for placement), and a more complex connection detail at each end.
We’ve done Auckland kitchen openings where the choice between a 360-deep LVL soffit dropping below the existing ceiling and a 250-deep PFC sitting flush was the difference between a compromised-looking ceiling plane and a clean open-plan space.
“The engineering drawing is usually a thousand-dollar line item. That’s the cheap part. The expensive part is redesigning a kitchen because the beam you wanted turned out to need a 100mm soffit hanging below the ceiling line. I’ve had more than one client pick the beam first and the layout second — which sounds backwards, but on a full-home reno it’s often the order that saves the budget.” — Alison Yu, Designer, Superior Renovations
Reading a Producer Statement (PS1) — what you’re actually paying for
For any structural member of consequence, you’ll get a Producer Statement — Design (PS1) from a chartered structural engineer (CPEng). This is the document that states the beam has been designed to carry the calculated loads, meets the Building Code, and references the drawings and calculations that support that design.
The PS1 for a single residential beam typically costs between $1,500 and $3,000 depending on complexity, site visits, and how much structural analysis is required. For a full-home renovation with multiple openings, a new storey, or a complex roof alteration, an engineer’s total fee across PS1 design, site review, and PS4 construction review can sit between $5,000 and $15,000+.
That’s not where you want to save money. An engineer’s fee is the insurance policy that sits between you and every structural risk we’ve talked about.
Why “a standard 240×45 should do it” isn’t an answer
There’s a type of back-of-a-serviette engineering that still circulates in renovation conversations. “For a 3-metre opening in a single-storey house, a standard 240×45 LVL will be fine.”
Sometimes it will. Often it won’t. And the difference depends on:
The actual tributary area of roof loading onto the wall (which depends on rafter layout, roof pitch, and whether the beam is carrying just roof or also ceiling)
Wind zone — Auckland ranges from Medium to Extra High depending on exposure
Whether the wall above carries any stacked load from a second storey or an attic conversion
Snow load (generally zero in Auckland, but not zero everywhere in NZ)
Deflection limits — the beam might pass strength but fail the serviceability limit for deflection, causing visible sag and cracking in GIB above
Connection at each end — the studs, trimmers, and bottom-plate-to-foundation path that receives the beam’s end reactions
No standard answer handles all of that. Which is why we engage the engineer at the design stage, not after a wall has been opened.
💡 Quick tip: If you want a rough early-stage cost picture for full-home structural changes including beams, try the house extension cost calculator. It’s not a beam specification tool — but it’ll give you an order-of-magnitude figure to work with before you commit to an engineer’s design brief.
Foundation Implications Most Homeowners Don’t See Coming
Here’s the part of the structural conversation that catches even experienced renovators off guard.
Removing a wall doesn’t just mean adding a beam. It means changing where the loads land at ground level — and the existing foundation may not have been designed to take those new concentrated loads.
From distributed load to point load — why this matters
A load-bearing wall distributes its weight along its entire length. If the wall is 4 metres long, the load per linear metre at the foundation is the total wall load divided by 4 metres.
Replace that wall with a beam sitting on two posts and you’ve changed the game completely. The entire load the wall used to distribute along 4 metres now concentrates onto two small bearing points — often 90×90 or 140×90 timber posts, or a steel column base plate roughly 200x200mm. The force per square metre at those two points is several times higher than it used to be.
That force has to go somewhere. It travels down the post, through the bottom plate, into the foundation, and — ultimately — into the ground. Every element in that chain has to be checked.
Most Auckland villas are founded on timber piles — originally often kauri, sometimes later replaced with concrete perimeter footings when the house was restumped. The piles are designed to carry the distributed weight of the original walls.
They were not designed to carry a concentrated point load from a new beam-and-post arrangement.
We’ve had Grey Lynn jobs where the engineer’s calculation came back requiring a new pad footing under each end of the new beam — typically a 600x600x400mm mass concrete pad with reinforcing, replacing the original pile in that location. That’s a $2,000–$4,000 cost per pad, plus the sub-floor excavation work, plus the programme time. Times two for a single beam. Times more if multiple walls are coming out.
Older 1920s–40s Grey Lynn, Ponsonby, Herne Bay, and Mt Eden villas are particularly exposed here because the originals often have undersized, rotted, or sunken piles to begin with. A full-house renovation project is often the right moment to address sub-floor structure comprehensively — rather than patching one pile at a time over twenty years.
Second-storey additions and foundation capacity
If your renovation involves going up — a second storey, an attic conversion, a habitable loft — the foundation conversation escalates.
Adding a storey roughly doubles the vertical dead load on the existing foundation, and more than doubles the seismic and wind-induced lateral loads. The existing footings were designed for what’s there today, not what you want to build on top. For second-storey work we nearly always bring in a geotechnical engineer alongside the structural engineer, particularly in parts of Auckland with softer ground (subsoil classes C, D or E under the loadings standards), where you need deeper or wider footings. Site class assessment isn’t a step to skip when you’re adding load — the engineer needs it to design the foundations properly.
Take one full-house renovation we did in West Harbour — a five-bedroom home taken right back through the interior and exterior. The heavy early-phase work — stripping to the framing, reroofing, insulating, sorting the envelope — was sequenced before any finishing trades came on site, and it set the timeline for everything that followed. On a full strip-back like that, the structural and weathertightness work runs first, or the whole programme waits on it.
If you’re thinking about going up, our group architecture practice Sonder Architecture handles the structural design, engineering coordination, and Resource Consent work. That’s not a plug — it’s because structural additions this complex need a design team that’s connected to the build team from day one.
Concrete slab homes — a different set of constraints
Many homes built from the 1970s on — brick-and-tile bungalows through South and West Auckland, newer subdivisions in Flat Bush, Hobsonville, Albany, Millwater — are founded on concrete slab-on-grade with integral footings.
Slab foundations have different strengths and weaknesses for renovation. The good news: point loads spread into the slab reasonably well, and you’re less likely to need separate pad footings under new beam supports. The bad news: underfloor services are cast into the slab, which constrains where plumbing changes are viable, and thickening the slab locally for a major new load often isn’t practical.
For slab-founded homes, the structural conversation is usually more about confirming the existing slab has adequate capacity — via engineer’s calculation and sometimes a core sample — than about adding new foundations. This is cheaper and faster. It’s one of the reasons renovating a newer slab home is often simpler than renovating a villa on piles.
How We Manage Structural Risk at Superior Renovations
Everything above is the problem. Here’s our process for keeping it bounded.
We’ve renovated hundreds of Auckland homes and the structural package sits under a specific set of controls — not because we’ve added bureaucracy for its own sake, but because each control is there to prevent a failure mode we’ve seen cost somebody, somewhere, real money.
Before contract: feasibility, not optimism
The single most important thing we do is separate feasibility from quote.
Before any fixed-price renovation contract is signed, we run a feasibility process that includes an engineer walking the house with our project manager. They assess load paths, identify likely structural constraints, flag any foundation concerns, and give us the scope of structural work required to deliver the design brief.
That happens before the quote is priced — not after the contract is signed. It’s the reason our fixed-price quotes hold up. The structural unknowns get investigated at the feasibility stage, not discovered at day five of demo.
You can request this via our free feasibility report. For any full-home renovation involving wall removals or new openings, we’d consider this step non-optional.
During design: engineer as part of the team, not a late add-on
The second control is how we sequence the engineer into the design.
A common failure mode we see in other renovation projects: the architect or designer produces a beautiful set of plans, the homeowner falls in love with them, the plans go to the engineer for sign-off — and the engineer comes back requiring a beam depth that breaks the ceiling plan, or a post position that breaks the kitchen layout, or a foundation upgrade that the budget didn’t account for.
By the time this happens, the client is attached to a design that can’t actually be built as shown. Cue the redesign cycle. Cue the delays.
Our process puts the engineer in the room during design development, not at the end. Every structural element — beam, post, new footing, bracing line — is confirmed before drawings are finalised for consent. The plans you approve are plans that can actually be constructed at the cost we quoted.
💡 Quick tip: If you’re comparing renovation companies, ask at what stage of the design process the structural engineer gets involved. If the answer is “when we submit for consent,” the structural risk is likely to show up in your variation orders rather than the original quote.
During build: PS3, PS4, and the paperwork that keeps you safe
The third control is the sign-off chain during construction.
For any significant structural work, three Producer Statements come into play:
PS1 — Design: issued by the structural engineer, certifies the design meets the Building Code
PS3 — Construction: issued by the contractor (us), certifies the work was built in accordance with the consented documents
PS4 — Construction Review: issued by the engineer after site inspections, certifies they’ve reviewed the construction and it aligns with the design
Auckland Council typically requires PS3 and PS4 before issuing a Code of Compliance Certificate on any renovation with meaningful structural scope. Missing either is a compliance problem that surfaces at CCC stage and, later, at sale.
We schedule engineer site visits at each structural hold point — typically when beams are installed, when bracing is in, and before pre-line inspection. It’s a cost line that clients sometimes ask about. It’s not a line we’ll negotiate down.
Contingency — the line item nobody wants until they need it
Last control. Every full-home renovation quote we produce includes a contingency allowance, specifically for structural and weathertightness discovery. Typically 10–15% of the structural package cost, held in trust and only drawn down by variation when discovery requires it.
If it’s not used, it comes back to the client at the end of the job.
No renovation company can give you a zero-risk structural quote on a 60-year-old Auckland house. What we can do is price the known scope tightly and ringfence the unknown scope in a contingency that’s visible, managed, and doesn’t blindside you mid-build.
That’s how we keep the structural package from being the line that rewrites the programme.
So What Should You Actually Do Before Taking Out a Wall?
Four things, in this order.
Get an engineer’s eye on the house before you sign any renovation contract — ideally through a feasibility report that includes a structural walkthrough. Make sure the company you’re working with runs their engineer into design, not after it. Make sure your quote has a transparent contingency for structural discovery, not a zero-risk promise that’s going to evaporate on day five of demo. And make sure the PS1, PS3, PS4 chain is in your build contract as a deliverable.
If those four things are in place, structural changes stop being the part of the renovation where the budget goes to die. They become what they should be — the part of the renovation that lets you reshape the house you own into the house you actually want to live in.
Drop by our showroom at 16B Link Drive, Wairau Valley, or get in touch through the form at the bottom of this page. We’ll walk the house, answer the specific structural questions for your build, and give you an honest read on what’s possible and what’s expensive.
Do I need a building consent to remove a load-bearing wall in Auckland?
Yes — removing a load-bearing wall is Restricted Building Work under the NZ Building Act and requires a Building Consent from Auckland Council, a Licensed Building Practitioner to sign off the structural work, and engineer-specified beam and support design. Consent costs for residential structural work typically sit between $2,500 and $6,000 depending on scope. Doing it without consent creates problems at CCC stage and at resale when the LIM report flags unconsented work.
How much does a structural engineer cost for a renovation in NZ?
For a single residential beam design with a Producer Statement (PS1), expect $1,500 to $3,000. For a full-home renovation with multiple structural elements — beam design, bracing calculations, foundation review, PS1, PS3 and PS4 documentation, and site inspections — total engineer fees typically sit between $5,000 and $15,000+ depending on complexity. This is not where to cut budget. The engineer's fee is the insurance policy that sits between you and every structural risk on the job.
Can I tell if a wall is load-bearing without an engineer?
You can make an educated guess — walls parallel to ceiling joists with no wall above them are often non-structural — but you can't be certain without engineering assessment. Villas, leaky-era homes, and split-level houses have concealed beams and non-obvious load paths. Bracing walls can fail the Building Code even when they don't carry vertical load. For any full-home renovation, pay for a structural engineer's walkthrough before you commit to a layout. Guessing wrong is expensive.
What's the difference between LVL and steel beams for renovations?
LVL (Laminated Veneer Lumber) is the default for most residential openings — cost-effective, installs with standard carpentry trades, works up to about 5-6m spans. Steel (PFC, UB, UC sections) becomes necessary when spans are longer, depth must be minimised to preserve ceiling height, or there are heavy point loads from a second storey above. Steel costs more and needs a fabricator plus lifting gear, but can carry loads in shallower depths. The engineer specifies which is required based on the load and geometry.
How much does it cost to remove a load-bearing wall in Auckland?
For a typical single-storey wall removal in Auckland — engineer design, building consent, beam supply and install, propping, framing adjustments, GIB reinstatement — budget $8,000 to $20,000+ depending on span, beam type, and whether foundation upgrades are required. For multi-storey situations or villas needing new pad footings, costs can escalate above $30,000. As part of a full-home renovation, structural work often adds $15,000 to $40,000 to the overall budget, which fits within the mid-range $80,000–$160,000 full-reno bracket for Auckland.
Do I need to upgrade the foundation when removing a wall?
Often yes — even when the homeowner doesn't expect it. Removing a wall converts a distributed load into two concentrated point loads at the beam supports, which may exceed what the original foundation was designed for. Villas on timber piles frequently need new concrete pad footings under beam posts, typically $2,000–$4,000 per pad. Slab-on-grade homes usually handle the load change without new footings but require an engineer's confirmation. This assessment is part of the structural design, not an afterthought.
What is a PS1, PS3, and PS4 in a renovation?
Producer Statements are documents issued by qualified professionals confirming structural work meets the Building Code. PS1 (Design) is issued by the structural engineer and confirms the design is compliant. PS3 (Construction) is issued by the builder and confirms the work was constructed to the design. PS4 (Construction Review) is issued by the engineer after site inspections and confirms they've reviewed construction. Auckland Council typically requires PS3 and PS4 before issuing a Code of Compliance Certificate for structural work.
How long does structural work add to a full-house renovation timeline?
On a typical Auckland full-home renovation running five to seven months, the structural package — demolition, framing, beam installation, bracing and foundation work, plus engineer inspections — usually takes up the first third of the programme. On a five-bedroom full-house renovation we completed in West Harbour, the heavy structural and envelope work was front-loaded before any finishing trades started, which set the timeline for everything after. Structural work can't be compressed much — skip stages and you create compliance problems at CCC.
Can I do structural renovation work without telling Auckland Council?
No — not if you want a Code of Compliance Certificate, a clean LIM, and valid insurance. Structural work is Restricted Building Work. Unconsented structural changes become a problem when selling the house (the LIM flags it), when claiming on insurance (claims can be declined), and when applying for future consents (Council can require retrospective remediation). We've seen owners inherit $30,000–$60,000 of retrospective work on homes where a previous owner skipped consent.
Does Superior Renovations handle the engineer and consent process?
Yes — we manage the entire structural process as part of our full-service renovation. Our project manager engages the engineer during the feasibility stage, coordinates structural design alongside the architectural design (via our group practice Sonder Architecture for larger jobs), lodges the Building Consent, schedules site inspections, obtains PS3 and PS4 documentation, and delivers a clean Code of Compliance Certificate at handover. You deal with one point of contact from first consultation to final sign-off.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
Quick answer: A standard acrylic shower in Auckland costs $900–$2,000 installed and takes half a day. A tiled shower runs $2,500–$4,000, takes considerably longer, and usually requires a building consent — but it lasts two to three times as long and adds genuine value to your bathroom.
We hear this question at nearly every bathroom consultation. The client has done some browsing, they’ve seen the supplier websites, and they want a straight answer: acrylic or tiled?
Here’s the thing most of those supplier articles won’t tell you — they’re written by companies that sell one or the other. Newline makes acrylic showers. Englefield makes acrylic showers. Crest Showers sells glass and tile packages. Each one is going to nudge you toward their product. That’s not a criticism — it’s just how it works.
We’re a renovation company. We install acrylic showers and tiled showers across Auckland every week. We don’t manufacture either. We don’t get a better margin on one versus the other. So when a client in Remuera asks us what they should put in their ensuite, or a landlord in Henderson asks what makes sense for a rental refresh, we give them the honest answer based on their specific situation.
This post is that honest answer, written for Auckland homeowners. We’ll cover exactly what each option costs, what’s involved in the installation, whether you need a building consent (this one trips people up constantly), how long each lasts, and — at the end — what we actually recommend based on eight years of doing this.
What Does an Acrylic Shower Actually Cost vs a Tiled Shower in Auckland?
Let’s get the numbers on the table first, because this is usually what decides it.
An acrylic shower package — base, wall liner, glass, and waste — costs between $900 and $2,000 fully installed in Auckland. That’s the complete job. The lower end gets you a standard 900×900mm two-sided Newline or Englefield unit with framed glass. The upper end gets you a larger 1200×900mm unit with semi-frameless or frameless glass and a low-profile tray.
A tiled shower is a different proposition entirely. Expect to pay $2,500–$4,000 for a tiled shower as part of a bathroom renovation in Auckland — and that’s when you’re already renovating the room. The tiling labour, waterproof membrane, GIB Aqualine lining, tile supply, grout, and shower glass all add up. If you’re tiling the entire bathroom floor-to-ceiling (which most of our clients do when they go the tiled route), the shower becomes part of a larger tiling package rather than a standalone cost.
A few things to note. Those tiled shower figures assume you’re already doing a full bathroom renovation and the tiler is on site anyway. If you wanted to rip out a standalone acrylic unit and replace it with a tiled shower on its own — without renovating the rest of the bathroom — you’d be looking at $7,000–$10,000 or more once you add consent, waterproofing, tiling, plumbing, and glass. That’s what we consistently see on standalone shower jobs across Auckland.
💡 Quick tip: If you’re renovating the whole bathroom anyway, the cost gap between acrylic and tiled shrinks considerably — because the tiler, waterproofer, and plasterer are already booked. The real cost difference is when you’re replacing a shower in isolation.
One more number worth knowing. Across our Auckland projects, labour rates for bathroom trades run $90–$120 per hour. Tiling labour is on the higher end of that range, and a skilled tiler working on shower walls and a shower floor will spend 2–3 days minimum. That labour cost is baked into the tiled shower figures above.
Superior Renovations
Building Consent — The Part Most People Get Wrong
This is where the acrylic vs tiled shower conversation gets genuinely complicated in New Zealand. And it’s the section most supplier websites either skip entirely or oversimplify.
If you’re replacing an acrylic shower with another acrylic shower in the same position, you generally don’t need a building consent. It’s a like-for-like replacement. The plumbing stays where it is, no structural changes, no waterproof membrane work. A plumber swaps the waste, the installer fits the new unit, and you’re done in a day. Building Performance (MBIE) lists replacing an existing shower with a stand-alone or ready-made shower among the work that sits within the Schedule 1 exemptions.
Tiled showers are a different story — particularly level-entry ones.
Why Tiled Wet-Area Showers Usually Need Consent in NZ
According to Building Performance (MBIE), installing a “wet area” shower requires a building consent. A wet-area (or level-entry) shower is one where the shower floor is a continuation of the bathroom floor rather than a separate raised tray. MBIE’s position is that this work is not low-risk: the substructure for the tanking and the waterproofing falls outside the Schedule 1 exemptions because the consequences of getting it wrong are significant.
Auckland Council follows this guidance. If you’re building a tiled level-entry shower, expect to apply for consent.
But — and this is the part that’s been confusing tradies and homeowners across the country — a 2024 MBIE determination muddied the water.Determination 2024/054 looked at two tiled showers installed in an existing dwelling and found that, because the work involved removing existing linings and installing new ones, the wet-area membrane work fell within the scope of Clause 12 of Schedule 1. In plain English: in that specific situation, membrane work that MBIE’s own guidance treats as needing consent was found to be exempt under the Act itself.
“We always advise clients to get consent for a tiled shower. The cost is a few hundred to a couple of thousand dollars and it protects you when you sell. The determination created some grey area, but grey area in building compliance isn’t something you want to gamble on — especially in Auckland where LIM reports flag everything.” — Dorothy Li, Design Manager, Superior Renovations
Our position is straightforward. Get the consent. It’s a few hundred dollars and a few weeks of processing time. When you sell your home, a consented tiled shower is an asset. An unconsented one is a negotiation point — and not in your favour. We’ve seen Auckland property transactions where the buyer’s solicitor knocked $5,000–$10,000 off the purchase price because bathroom work wasn’t consented. That makes the consent fee look like very cheap insurance.
💡 Quick tip: If a tradie tells you a tiled shower doesn’t need consent, ask them to put that in writing. Most won’t — because they know the liability sits with the homeowner, not the installer. Use MBIE’s “Do you need a building consent?” tool or call Auckland Council’s building desk directly.
What This Means in Practice
For most Auckland homeowners doing a full bathroom renovation with a tiled shower, the consent is part of the process anyway. Superior Renovations handles all consent applications on behalf of our clients — it’s built into how we manage projects. You won’t be chasing council inspectors or trying to interpret Schedule 1 yourself. We work with Sonder Architecture for any projects that require architectural drawings or resource consent documentation.
For landlords doing a quick rental refresh with an acrylic swap? The consent question rarely comes up. That’s one of acrylic’s genuine advantages.
How Long Does Each Shower Type Actually Last?
This is where the value equation shifts — and where acrylic’s upfront cost advantage starts to shrink.
A quality acrylic shower typically lasts 10–20 years. The walls hold up well — acrylic is non-porous, doesn’t absorb moisture, and resists mould naturally. The tray is usually the first thing to show wear. Manufacturer warranties give you a sense of the range: Atlantis backs its Ellure acrylic wall panels for around 7 years, while its premium tile-over EasyTile shower base carries a 25-year leak-free warranty. Higher-end units with thicker acrylic and reinforced bases sit at the top of that lifespan range.
A tiled shower? Properly installed with quality porcelain or ceramic tiles, expect 40–50 years. The tiles themselves are almost indestructible. What needs attention is the grout and the waterproof membrane underneath. Per BRANZ, the waterproofing system under wet-area tiling must have a durability of at least 15 years under Building Code Clause B2 — and a well-maintained membrane often outlasts that. Grout should be resealed every 8–10 years, and silicone around glass and junctions needs replacing every 2–3 years (or sooner in Auckland’s humidity). That maintenance isn’t free — a professional silicone replacement and grout reseal runs $300–$600 — but it’s a fraction of a full shower replacement.
Maintenance Comparison
Maintenance Task
Acrylic Shower
Tiled Shower
Weekly cleaning
Wipe with soft cloth + mild soap — 5 mins
Clean tiles + scrub grout lines — 10–15 mins
Silicone replacement
Every 3–5 years
Every 2–3 years
Grout resealing
N/A — no grout
Every 8–10 years ($300–$600)
Damage repair
Difficult — cracks often mean full replacement
Individual tiles can be replaced without redoing the whole shower
Expected lifespan
10–20 years
40–50 years (with grout maintenance)
Here’s the maths that matters. Over a 40-year period in your Auckland home, you’d likely replace an acrylic shower two to three times — spending $2,700–$6,000 total. A single tiled shower installation at $3,500 with two grout reseals ($600–$1,200) totals around $4,200–$4,700 over the same period. Similar lifetime cost, but the tiled shower adds more to your home’s market value throughout.
💡 Quick tip: Auckland’s humidity is harder on both options than you’d expect — NIWA classifies the region’s climate as warm and humid, with mean morning relative humidity sitting around 80%. For acrylic, make sure your extractor fan is rated for the room size — inadequate ventilation accelerates yellowing. For tiled showers, use porcelain over ceramic where budget allows. Porcelain’s water absorption rate is under 0.5%, well inside the 6% maximum BRANZ specifies for shower tiles, making it far better suited to Auckland’s damp conditions.
“I always tell clients — the grout is not the enemy. Poor ventilation is the enemy. We see tiled showers in Ponsonby villas that look brand new after 12 years because the extractor fan is doing its job. And we see acrylic showers in new builds that have yellowed in five years because the bathroom has no window and a cheap fan.” — Cici Zou, Designer (NZ Dip. Interior Design, Certified Designer), Superior Renovations
Design and Aesthetics — When Each Option Makes Sense
Let’s be direct about this. A tiled shower looks better. That’s not a controversial statement — it’s why the majority of our Auckland bathroom renovation clients choose tiled. When you tile a shower floor-to-ceiling using the same tiles as the rest of the bathroom, you create visual continuity that makes the whole room feel larger and more cohesive. An acrylic box sitting inside a tiled bathroom does the opposite — it breaks the visual flow and immediately reads as a separate, lower-spec element.
That said, acrylic has come a long way. It’s not just the white plastic boxes people remember from the ’90s.
What Acrylic Can and Can’t Do
Modern acrylic showers from NZ brands like Englefield and Newline now offer low-profile trays, near-frameless glass, and cleaner wall profiles. Some manufacturers produce tile-look acrylic liners — Atlantis makes its Ellure range specifically to mimic a tiled wall without the waterproofing and consent requirements.
But there are hard limits. Acrylic is usually only available in white (coloured options exist but are made to order and significantly more expensive). You’re locked into the sizes the manufacturer offers — usually 900×900mm, 1000×1000mm, or 1200×900mm. If your bathroom has an awkward alcove or a non-standard dimension (common in older Auckland villas and bungalows), acrylic may not fit without compromising the layout.
What Tiled Showers Offer That Acrylic Can’t
Full design freedom. Any tile, any colour, any pattern, any size. You can run the same large-format 600×600mm porcelain across the bathroom floor and straight into the shower. You can create feature walls with textured or patterned tiles. You can build the shower to any dimension — wall-to-wall, oversized, or shaped to fill dead space in an unusual floor plan.
We recently completed a bathroom in Grey Lynn where the homeowner wanted a double-width walk-in shower spanning the full back wall of the room — 2.4 metres wide with a single glass panel. That’s not something an acrylic unit can do. The tiled shower with large-format charcoal porcelain and a linear channel drain made the bathroom look twice its actual size. Our bathroom design gallery has more of these completed tiled-shower projects.
For clients working with our in-house design studio, the tiled shower becomes a design element — not just a functional box. Our designers source tiles from The Tile Depot and work with fixtures from Reece to create bathrooms where the shower is the centrepiece, not an afterthought.
💡 Quick tip: If you’re renovating a bathroom in a character home — an early 1900s villa in Mt Eden, a 1930s bungalow in Epsom — a tiled shower with artisan or handmade-look tiles will complement the home’s character far better than a white acrylic unit. Continuity between the shower and the rest of the bathroom is what separates a good renovation from a great one.
So Which Should You Choose? Our Honest Recommendation
After installing hundreds of both across Auckland, here’s where we land.
You’re renovating a rental property. The maths are simple. An acrylic shower at $1,200 installed, lasting 10–15 years with almost zero maintenance, is the right call for a rental. Your tenants won’t appreciate (or maintain) expensive tilework, and you don’t need the design premium. We’ve done plenty of rental bathroom refreshes across Henderson, Papakura, and South Auckland where an acrylic unit with a basic vanity and new flooring brings the bathroom up to a good standard at the lower end of the budget range.
You’re on a very tight budget. If every dollar matters, acrylic saves you $1,500–$3,000 on the shower alone — money you can redirect to a better vanity, decent tapware, or underfloor heating.
You need it done fast. Moving in next week? Selling in a month? Acrylic goes in within a day. No consent, no waiting for a tiler, no curing time.
Choose a Tiled Shower If:
You’re renovating your own home. If this is the bathroom you’ll use for the next 10–20 years, spend the extra. The tiled shower will outlast the acrylic option by decades, and you’ll appreciate the design every morning. It’s not about luxury — it’s about doing it once and doing it properly.
You’re spending $25,000+ on the bathroom renovation. At this budget level, putting an acrylic shower in a fully tiled bathroom looks and feels wrong. It’s the equivalent of fitting laminate benchtops in a kitchen with custom cabinetry. The shower should match the standard of the rest of the room. A mid-range bathroom renovation in Auckland runs $25,000–$35,000 — and at that price point, our bathroom renovation cost calculator already factors the tiled shower in.
You’re trying to add value before selling. A tiled, consented bathroom reads as a quality renovation on a property listing. An acrylic shower in an otherwise upgraded bathroom sends mixed signals. Buyers notice.
“When clients come to our showroom at 16B Link Drive in Wairau Valley, we always show them both options side by side. Nine times out of ten, once they see the difference in person, they choose tiled. It’s not about cost at that point — it’s about how their bathroom will feel every day.” — Alison Yu, Designer, Superior Renovations
The Hybrid Option
There’s a middle ground worth mentioning. Some homeowners choose an acrylic tray with tiled walls. The acrylic base handles the waterproofing at floor level (where leaks cause the most damage), while the tiled walls give you the design flexibility and premium look. It can work — but talk to your renovation company about how the junction between tray and tile is detailed, because that’s where problems occur if it’s not done properly. It’s not a shortcut we recommend for most clients, but it has its place.
What Happens During Installation — Acrylic vs Tiled
Understanding what’s actually involved helps explain the cost and time difference.
Acrylic Shower Installation
Total time: 4–6 hours, one tradie. The process is straightforward. The plumber connects the waste fitting to the shower tray, the tray is set onto the floor (levelled with packing if needed), the acrylic wall liners are glued to the walls, silicone is applied at all junctions, and the glass is fitted. Done.
The simplicity is acrylic’s biggest practical advantage. One person, one day, minimal disruption. If you’re replacing an existing acrylic unit with a new one and the plumbing is in the same position, there’s very little that can go wrong.
Tiled Shower Installation
Total time: 5–10 working days (as part of a full bathroom renovation), involving multiple trades. Here’s the typical sequence:
Day 1–2: Demolition of existing shower, wall preparation, any structural modifications to floor joists or framing. Day 3: GIB Aqualine (or equivalent wet-area lining) installed on walls. Shower tray positioned and waste connected by plumber. Day 4: Waterproof membrane applied to all wet-area surfaces — walls and floor. This is the critical step. The membrane needs to cure for 24–48 hours minimum before tiling. Day 5–7: Tiling — walls first, then floor. Larger tiles reduce labour time, which is why 600×600mm formats have become standard in Auckland bathrooms. Day 8: Grouting and initial clean. Day 9–10: Silicone applied at all junctions, glass measured and fitted (custom glass may require a separate visit).
The waterproof membrane is what makes or breaks a tiled shower. Get it wrong and you’re dealing with leaks that damage framing, flooring, and potentially rooms below. This is why MBIE cares about consent for wet-area showers — and why you want a renovation company that uses licensed building practitioners, not a mate with a trowel. We use certified waterproofing systems and provide PS3 waterproofing producer statements as standard on every tiled shower we install.
💡 Quick tip: Ask your renovation company for a PS3 producer statement for the waterproofing. This is a document signed by the waterproofing applicator confirming the membrane was installed to the manufacturer’s specifications. It’s required for consent sign-off and it’s your proof that the job was done correctly. If a company can’t or won’t provide one, that’s a red flag.
A standard acrylic shower package — base, wall liner, glass, and waste — costs between $900 and $2,000 fully installed in Auckland. The price depends on the size (900×900mm to 1200×900mm), glass type (framed vs frameless), and brand. Popular NZ brands include Englefield, Newline, Atlantis, and Clearlite. Labour is typically 4–6 hours with one tradesperson.
How much does a tiled shower cost in Auckland?
A tiled shower costs $2,500–$4,000 when installed as part of a full bathroom renovation in Auckland. This includes the tile-over tray, waterproof membrane, GIB Aqualine lining, tiles, grouting, and glass. If you're replacing a standalone acrylic shower with a tiled shower without renovating the rest of the bathroom, expect $7,000–$10,000+ including building consent.
Do I need a building consent for a tiled shower in NZ?
In most cases, yes. Building Performance (MBIE) states that installing a wet-area (level-entry) shower requires a building consent because it involves waterproof membrane work classified as higher-risk. Auckland Council follows this guidance. A 2024 MBIE determination (2024/054) found membrane re-lining work in an existing dwelling could fall within a Clause 12 exemption, creating some grey area — but our strong advice is to get consent regardless. It protects you when selling your home.
Do I need consent to replace an acrylic shower with another acrylic shower?
Generally no, provided it's a like-for-like replacement in the same position with no changes to plumbing layout or structure. Building Performance (MBIE) lists replacing an existing shower with a stand-alone or ready-made shower among Schedule 1 exempt work. An authorised plumber should handle the waste connection. This is one of acrylic's key advantages — a straightforward swap with no council involvement.
How long does an acrylic shower last in NZ?
A quality acrylic shower typically lasts 10–20 years depending on the brand and maintenance. Manufacturer warranties give a guide — Atlantis backs its Ellure acrylic wall panels for around 7 years and its premium EasyTile shower base for 25 years. Auckland's high humidity can accelerate wear if ventilation is poor, so a decent extractor fan rated for the room size is essential.
How long does a tiled shower last?
A properly installed tiled shower with porcelain or ceramic tiles can last 40–50 years. The tiles themselves are extremely durable — it's the grout and waterproof membrane that determine overall lifespan. Under Building Code Clause B2, BRANZ notes the waterproofing system must have a durability of at least 15 years. Grout should be resealed every 8–10 years, and silicone at junctions replaced every 2–3 years. With regular maintenance, a tiled shower will outlast multiple acrylic replacements.
Is an acrylic shower or tiled shower easier to clean?
Acrylic is easier for day-to-day cleaning. The smooth, non-porous surface wipes clean with a soft cloth and mild soap in about 5 minutes. Tiled showers require more effort — you need to clean between grout lines where soap scum and mould can build up, especially in Auckland's humid climate. Using larger tiles (fewer grout lines) and porcelain over ceramic reduces the cleaning burden significantly.
Can I replace an acrylic shower with a tiled shower myself?
We strongly advise against it. A tiled shower involves waterproof membrane application, wet-area lining (GIB Aqualine), correct fall for drainage, and tiling to building code standards. Errors in waterproofing can cause thousands of dollars in hidden water damage. The work typically requires a building consent with council inspections. Use a licensed renovation company that provides PS3 waterproofing producer statements.
Which adds more value to my home — acrylic or tiled shower?
A tiled shower adds more value. When buyers inspect an Auckland property, a fully tiled, consented bathroom reads as a quality renovation. An acrylic shower in an otherwise well-renovated bathroom can signal cost-cutting. For owner-occupied homes and properties being prepared for sale, tiled is the better investment. For rentals where tenant-proof durability matters more than aesthetics, acrylic is the practical choice.
What is a PS3 waterproofing producer statement and why does it matter?
A PS3 producer statement is a document signed by the waterproofing applicator confirming the membrane was installed according to the manufacturer's specifications. It's used for building consent sign-off on tiled showers in NZ and serves as your proof that the waterproofing was done correctly. Always ask your renovation company for this document — if they can't provide one, consider it a warning sign.
What tiles are best for a shower in Auckland?
Porcelain tiles are the best choice for Auckland showers. Their water absorption rate is under 0.5%, well within the 6% maximum BRANZ specifies for shower tiles — important given Auckland's high humidity. Large-format tiles (600×600mm or larger) reduce grout lines and cleaning time. For the shower floor, use smaller mosaic tiles or textured porcelain for grip. Source options from NZ suppliers like The Tile Depot (tiledepot.co.nz) who carry a wide range.
How long does it take to install a tiled shower vs acrylic?
An acrylic shower installs in 4–6 hours with one tradesperson. A tiled shower takes 5–10 working days as part of a full bathroom renovation — involving demolition, wall preparation, waterproofing membrane application (plus 24–48 hours curing time), tiling, grouting, and glass fitting. Multiple trades are needed: plumber, waterproofer, tiler, and glass installer.
Take advantage of our FREE Complete Home Renovation Guide (48 pages), whether you’re already renovating or in the process of deciding to renovate, it’s not an easy process, this guide which includes a free 100+ point check list – will help you avoid costly mistakes.
*Lending criteria, fees, terms and conditions apply. Mastercard is a registered trademark and the circles design is a trademark of Mastercard International Incorporated.
Still have questions unanswered?
Book a no-obligation consultation with the team at Superior Renovations, we’d love to meet you to discuss your renovation ideas!
We have always loved working with Superior renovations and in particular Kevin. We felt like we were getting special one-on-one treatment at all hours of the day. They always produce their work super quick and to a good standard.
We added a new bathroom and upgraded the rumpus. Superior Renovations offered a reasonable price and delivered professional services and work. We recommend Superior Renovations for the house renovation.
This is our final and exceptionally positive review for Superior Renovations. First and foremost, we must emphasize that they are outstanding!
Superior Renovations has completed a comprehensive renovation of our entire house, both externally and internally, including the kitchen, bathroom, painting, carpeting, electronic gate, and more. Throughout the various projects over the past few months, we have been thoroughly impressed by their work and are delighted with the results. Their expertise and service continue to amaze us; they truly listen to our needs and engage in discussions whenever they believe improvements can be made.
We extend our gratitude to Cici, who not only served as the sales manager but also as the designer, transforming our kitchen from an early 2000s style to a modern and stylish new one. Neil, our project manager, worked with us daily, attending to every detail and going the extra mile to help us achieve an excellent result.
From the very first day of collaboration, we encountered no issues whatsoever, whether in communication, design discussions, or the execution by the on-site teams. We highly recommend Superior Renovations to anyone considering home renovation. Contacting them will reveal why we are so pleased with their work on our home.
SUPERIOR RENOVATIONS Renovations on one full bathroom and one small ensuite at my home in Sunnynook, Auckland, were completed on 26th June 2026. I am fully satisfied with the work done at my home by all workers and contractors and delighted with the results that I am now enjoying. All work is of a very high standard and attention to care leading to excellent results. All staff of Superior Renovations and associated contractors were at all times helpful and happy to explain all aspects of their work and respectful in listening to any of my concerns or questions, with any changes where necessary being quickly and effectively carried out. I have no hesitation in recommending Superior Renovations as your choice for any bathroom renovation.
In early June, I hired Superior Renovation company to thoroughly renovate our two bathrooms. The project has now been completed and we are very satisfied. Thank you sincerely, and we highly recommend it.
Despite some delays, Eunice, Neil and the team at Little Giants have done a really good job on out kitchen renovation. Great finishing and very responsive to fixing up any little thing we weren't happy with.
From the very first consultation, our experience with this team has been nothing short of stellar. Working with Eunice, our sales consultant, set a high bar for the rest of the project. Eunice is truly exceptional at what she does. When we first began our kitchen project, we went through several versions of our floor plan, and she was with us every step of the way—from the initial planning stages right through to the final concept. Her patience and dedication during the design process were remarkable. Throughout the project, Eunice provided: * **Invaluable Suggestions:** She has a keen eye for both aesthetics and functionality, pointing out details we never would have considered on our own. * **Seamless Adjustments:** No matter how many tweaks we requested, she handled every change with professionalism and a "can-do" attitude. * **Expert Guidance:** She transformed our vague ideas into a cohesive, stunning reality. Once the planning was complete, Neil, our project manager, took the reins and truly blew us away. Neil is a consummate professional who balances technical expertise with fantastic communication. He kept us informed at every stage, ensuring we knew exactly what to expect and when. Whenever a minor pivot was needed, Neil handled it with grace and efficiency, keeping the timeline on track. His standards for the renovation work were incredibly high, ensuring the final result was polished and beautiful. The transition from Eunice’s initial planning to Neil’s execution was flawless. If you are looking for a team that combines design expertise with top-tier project management, look no further. We are absolutely thrilled with our new kitchen and new flooring !
Superior Renovations has just finished a complete remodel of my bathroom. I can see, why the company has such a high reputation. At every stage, from sales, design, project management, and execution, the company excelled at every point. I am just so happy with the work that they have done and they have exceeded my expectations at every point.
Used Superior for a kitchen and bathroom renovation last year. They did an excellent job updating both rooms, communication was excellent ongoing tjrough the project, they coordinated all the tradies, synchronized so there was little downtime, and it all worked exactly as planned and on budget. Was really glad we chose Superior Renovations and plan to use again for our entrance way at some stage.
As I said to my work colleagues ‘I have just had the most pleasant experience’. When they realised it was with renovations at home they were shocked - ‘unheard of’ I was told. Everything went to plan - timing, project management, costs, etc, etc. Neil communicated with me daily and made my whole bathroom renovation a pleasure. The best decision I made was choosing Superior Renovations. Thank you Kevin for our initial connection and for passing me on to Neil to manage the whole process.
We just finished a bathroom renovation and couldn’t be happier with the results. The craftsmanship is top-notch, and the attention to detail in the tiling and finishing is impressive. The team was professional, kept the workspace clean, and delivered exactly what we envisioned. Highly recommend them for anyone looking for a high-quality transformation.
This is our second review for Superior Renovations. They have done two projects earlier this year and we were so impressed by the work they have finished. After discussing and very careful consideration, we decided to go with more projects with them. So far, they have now completed stage 1 renovation of our house. We still amazed for their knowledge and services; they really listen to us and discuss anything with us if they feel/think could be better… From the first day we work with them, we have no issue with them at all, from communication, discussing, designing to the teams working on the site. Especially we are highly recommended to those who are considering doing the house renovation, please contact them and you will know why we are so pleased to have them to do our house renovation. We are thanking Cici, Neil and the teams so much…. We are looking forward to seeing what the outcome will be.
We recently had our bathroom renovated by Superior Renovations and couldn’t be happier with the experience. Dorothy and Neil were an absolute pleasure to work with. They guided us through every step of the process, making what can be a stressful experience feel smooth and straightforward. The quoting process was transparent and detailed, with no hidden fees or surprises. Neil was incredibly responsive and always available whenever we had questions or requests, which gave us real peace of mind throughout the project. We really love the end result and enjoy our new bathroom! We’ll definitely be returning to the Superior Reno team for our next project. Highly recommended!
Our bathroom reno has just been completed & I am so happy. The whole process was easy & hassle free. Alison designed our bathroom & was very patient with our changes/then changes back again. Jacob our project manager was a delight to deal with. He always kept us informed of the scheduling & any other information we may have needed. All the tradies worked hard & the job was completed & signed off within 3 weeks. That's demo, full tiling, installation of new everything & delivery & pick up of the skip down a very tricky driveway. We absolutely love the new bathroom & would recommend Superior Renovations everyday. Future jobs I will definitely be contacting them again. Thank so much for your excellent work
Having explored our reno options, it was an easy decision to select Superior Renovations for our work. As first timers at anything like this we had to trust the system with grand old 100year old bungalow. We were so pleased to have Cici, Sonny and Kai working with us the whole way through. Be shout out to all the team, builders, plumbers, electricians, tilers and painters. A superb job delivered on budget and ahead of time. The communication from Cici and Sonny was first class. Would highly recommend working with Superior Renovations in fact, we already have more worked booked in. Thanks Superior you made Millie and Monty's parents very happy. 🐾
I am very happy with the recent renovation for my new kitchen. The team worked really hard to get it done within the time frame. The manager, Jacob, was very helpful and communicated well and always sorts out any issue immediately. Thank you Irene
We couldn’t be happier with our new pergola! From start to finish, the team was professional, punctual, and easy to work with. They took the time to listen to what we wanted and offered great suggestions to make the design even better. The quality of the materials and workmanship is outstanding — everything feels solid, well-built, and beautifully finished. Kudos to Sinan Sun as she has been an amazing contact with the company.
We are very pleased with our bathroom reno by Superior Renovations! Jacob, Cici and the team always kept us up to date, were always friendly to deal with and finished ahead of schedule. Most importantly we are very happy with the quality of the work.
We have been working with Superior Renovations as a supplier now for over three years. In that time we have found the team to be very professional and well organised. Which is a welcome relief in this industry! Just recently we have become their sole supplier for portaloos, which recognises the collaboration we have forged over these three years.
In particular, Leanne and Elaine set a very high standard of communication and flexibility. This is of vital importance when scheduling deliveries and pickups with us, however, they understand not everything can be done at once and are willing to work with us for the best (supplier/contractor/client) outcome.
I would imagine this ethos would flow directly through to all their contracted renovation work. A pleasure to work with!
We have been working with these guys for the past 4 years and find them an awesome company to work with, very efficient and organised. I highly recommend!
Finding someone reliable for renovations has always been the most stressful thing for us. In the past, we had several painful renovation experiences—money was spent but the problems were never truly solved, and things often ended up worse than before. We really didn’t know where to find a trustworthy renovation company.
For more than ten years, our wish had been to renovate our bathroom, laundry, and toilet, so that we could finally enjoy a comfortable and functional living environment. Just when we were about to give up, we came across Superior Renovations online. We quickly made an appointment with Cici, who designed and provided us with a quote.
Throughout the whole process, I was deeply impressed by the professionalism of Superior Renovations. What stood out most was that they always delivered on their promises—everything agreed upon was completed on time. This built a relationship of trust and reliability. Up until completion, I was completely satisfied with their dedication and the quality of their workmanship.
During the renovation, we encountered some of the challenges that often come with older houses, but Cici and her team helped us resolve the discomforts we had been living with for years. We are truly grateful to the construction team.
Some say renovations are easy if you just have money, but I believe the most important thing is finding a trustworthy team that keeps their word, values quality, and cares about the customer’s experience.
Because of this renovation experience, we can now confidently plan our next project—the kitchen—and Superior Renovations will definitely be our first choice. We strongly recommend them.
Finally, I want to thank Cici and the team for helping us fulfill our dream.
It was great to have Alison's recommendations and input on how & what would look best for our kitchen and bathroom reno. Jacob, our project manager, has been a star too; ensuring that the project was delivered as planned, AND giving us great ideas & suggestions along the way.
We will definitely be calling on you guys again for our next home reno. Thanks team!
